Grande-Anse harbour-basin dredging and containment-cell works
Participation
Not assessed
Project facts checked
Les Entreprises P E C inc holds active CAD 862,270 contract CW2452382 through 31 December 2026 for barge-excavator dredging and containment-cell reconfiguration; earliest site start was 6 July and field progress remains unverified
Les Entreprises P E C inc received CAD 862,270 contract CW2452382 from Public Services and Procurement Canada for basin dredging at Grande-Anse Wharf, New Brunswick. The package specifies a barge-mounted excavator and scow method plus reconfiguration of a containment cell. Work could start no earlier than 6 July 2026; a bird survey was required 48 hours before site activity, and a species-at-risk finding could defer construction to mid-September. DFO's register classifies Grande-Anse as a non-core fishing harbour managed by Le Comite d'Autorite Portuaire de Grande-Anse Inc. Dredged quantity, sediment route, plant identity, mobilisation and acceptance remain unpublished.
Fishing harbour wharf, dredging and shore protection
Phase
Delivery / Confirmed
Last checked
7 August 2026
Coverage
Related sectors
Fishing harbour wharf, dredging and shore protection is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Public Services and Procurement Canada (PSPC) is listed as contracting and end-user entity; DFO's separate register identifies Grande-Anse as a non-core fishing harbour managed locally
Delivery parties
Les Entreprises P E C inc - prime contractor under CW2452382, Barge, scow, towing, survey, sediment-testing and containment lower tiers - not named in the cited public records
Contract route
PSPC issued WS5618091638 as a Canadian construction tender and amended the notice once. CanadaBuys records a 12 May 2026 award to Les Entreprises P E C inc, active contract CW2452382 and a CAD 862,270 total. The public record names the dredging method but no vessel, subcontractor or priced quantity schedule.
Execution window
CanadaBuys records the contract from 12 May to 31 December 2026. The tender prohibited work before 6 July and required a bird survey 48 hours before on-site activity. If the survey identified a species at risk in the project area, activity could be deferred to mid-September. No cited field record establishes which path occurred.
Works package
The contract covers harbour-basin dredging by barge-mounted excavator and scow and reconfiguration of a containment cell at Grande-Anse Wharf. Public records do not publish design depth, horizontal dredge limits, estimated or measured volume, sediment classification, scow capacity, haul route, placement sequence, cell capacity or return-water controls.
Marine interfaces
The work links excavator and scow productivity to constrained small-harbour access, bathymetric control and an onshore containment cell. The environmental timing gate makes pre-start survey evidence decision-critical, while acceptance depends on post-dredge geometry, sediment records, cell stability and removal of temporary marine controls.
Commercial evidence boundary
CanadaBuys reports CAD 862,270 as the base contract amount under amendment 000. The tender's CAD 500,001 to CAD 1 million estimate is a pre-award category, not additional value. No public allocation separates dredging, scow transport, towing, survey, sediment management, containment works or environmental monitoring.
Contract and delivery chain
Work packages and named roles
Published scope, named parties and supporting evidence for each workstream.
Prime award
CW2452382 Grande-Anse basin dredging
Named party
Les Entreprises P E C inc
Evidence status
Confirmed
Source position
CanadaBuys records the 12 May 2026 award, CAD 862,270 value and 31 December 2026 end date. Source
Dredging method

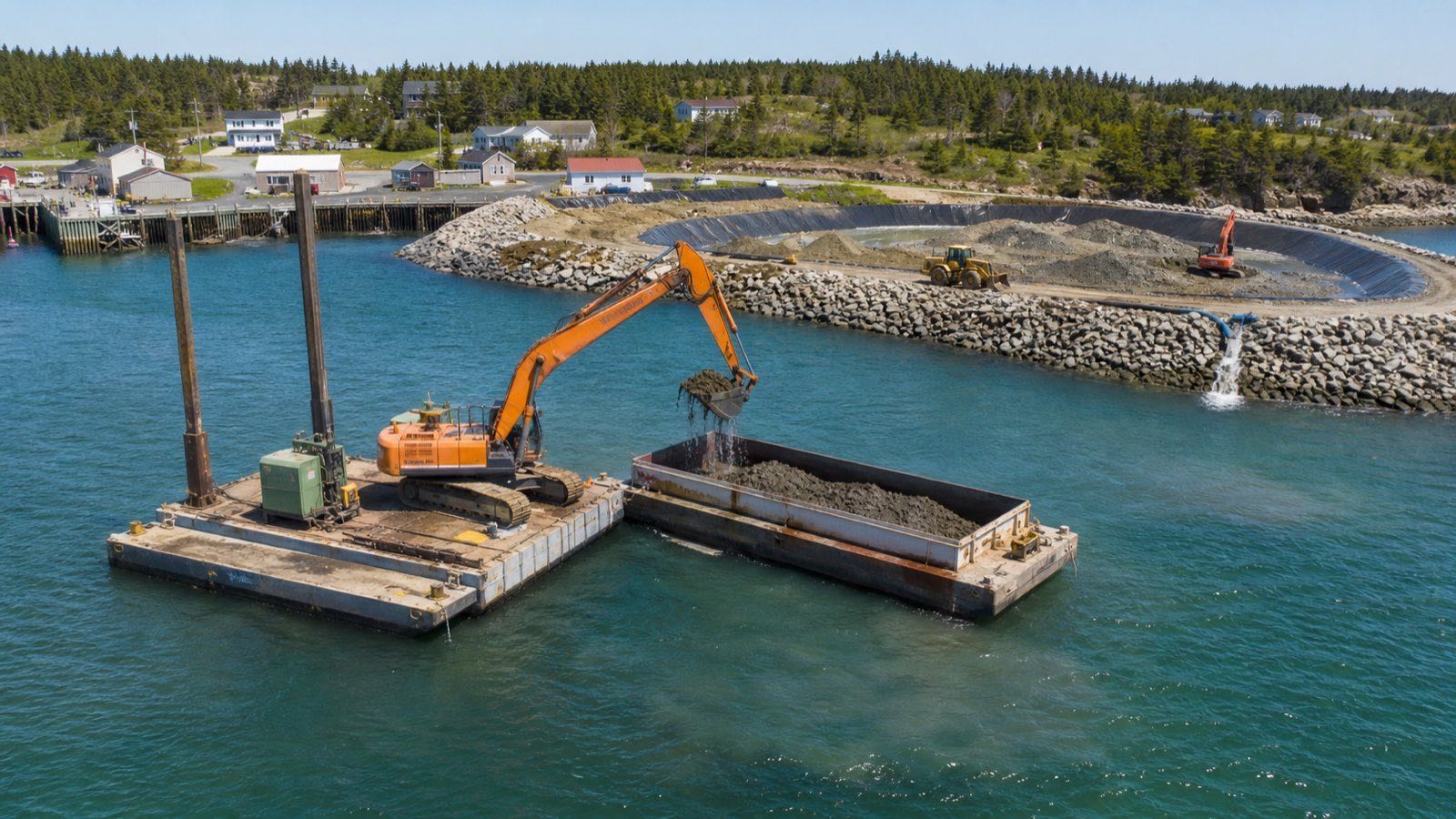

Barge-mounted excavator and scow
Named party
Les Entreprises P E C inc and undisclosed marine-plant chain
Evidence status
Reported
Source position
The tender and award description specify the method but identify no vessel, barge, scow or towing provider. Source
Environmental timing
Pre-start bird survey and species-at-risk gate
Named party
PSPC and project environmental team
Evidence status
Reported
Source position
The tender requires a survey 48 hours before activity and allows deferral to mid-September if a species at risk is found. Source
Completion and acceptance
Dredged basin and reconfigured containment cell
Named party
PSPC and Les Entreprises P E C inc
Evidence status
Not evidenced
Source position
No cited source publishes mobilisation, measured dredging, post-dredge survey, containment close-out or handover.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
