Maher's Contracting received F6140-210731/001/PWD on 15 November 2021; CanadaBuys records a CAD 1,763,368 cumulative contract after amendments, and the 2022-23 Public Accounts mark the Port de Grave contract completed
Maher's Contracting Limited received contract F6140-210731/001/PWD from Public Services and Procurement Canada for Fisheries and Oceans Canada's Port de Grave marginal-wharf reconstruction on 15 November 2021. The official package combined removal of the existing wharf with a new treated-timber crib marginal wharf, reinforced-concrete deck and slab, harbour dredging and cribseat excavation including rock removal if required, scour protection, drainage, water, electrical and waste-oil-tank relocation. The CAD 1,547,256 initial CanadaBuys award reached a CAD 1,763,368 cumulative contract after amendments. The 2022-23 Public Accounts separately report CAD 1,533,364 as both amount contracted and expenditure to date and apply the federal completed-contract marker.
Fishing harbour wharf, dredging and shore protection
Phase
Completed / Confirmed
Last checked
13 August 2026
Coverage
Related sectors
Fishing harbour wharf, dredging and shore protection is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Fisheries and Oceans Canada - Small Craft Harbours, procured through Public Services and Procurement Canada
Delivery parties
Maher's Contracting Limited - construction prime under F6140-210731/001/PWD, Dredging, blasting, timber, concrete, electrical, survey, testing, marine-plant and material-supply lower tiers - not named in the cited public records
Contract route
PSPC published F6140-210731/A under the Canadian Free Trade Agreement as an open, lowest-price construction competition for DFO. The tender ran from 27 September to 26 October 2021 and carried a CAD 1 million to CAD 5 million estimate range. CanadaBuys records award to Maher's on 15 November 2021, followed by amendment 001 on 9 November 2022 and amendment 003 on 19 January 2023; amendment 002 carries the cumulative value dated 14 December 2022.
Execution window
Bidders were required to complete the work within 50 weeks after award. CanadaBuys records expiry moving to 16 December 2022 and then 31 December 2022. Public Accounts for the fiscal year ended 31 March 2023 applies note f, defined by the Receiver General as contract completed; no cited record gives the exact substantial-completion, owner-acceptance or harbour-reopening date.
Works package

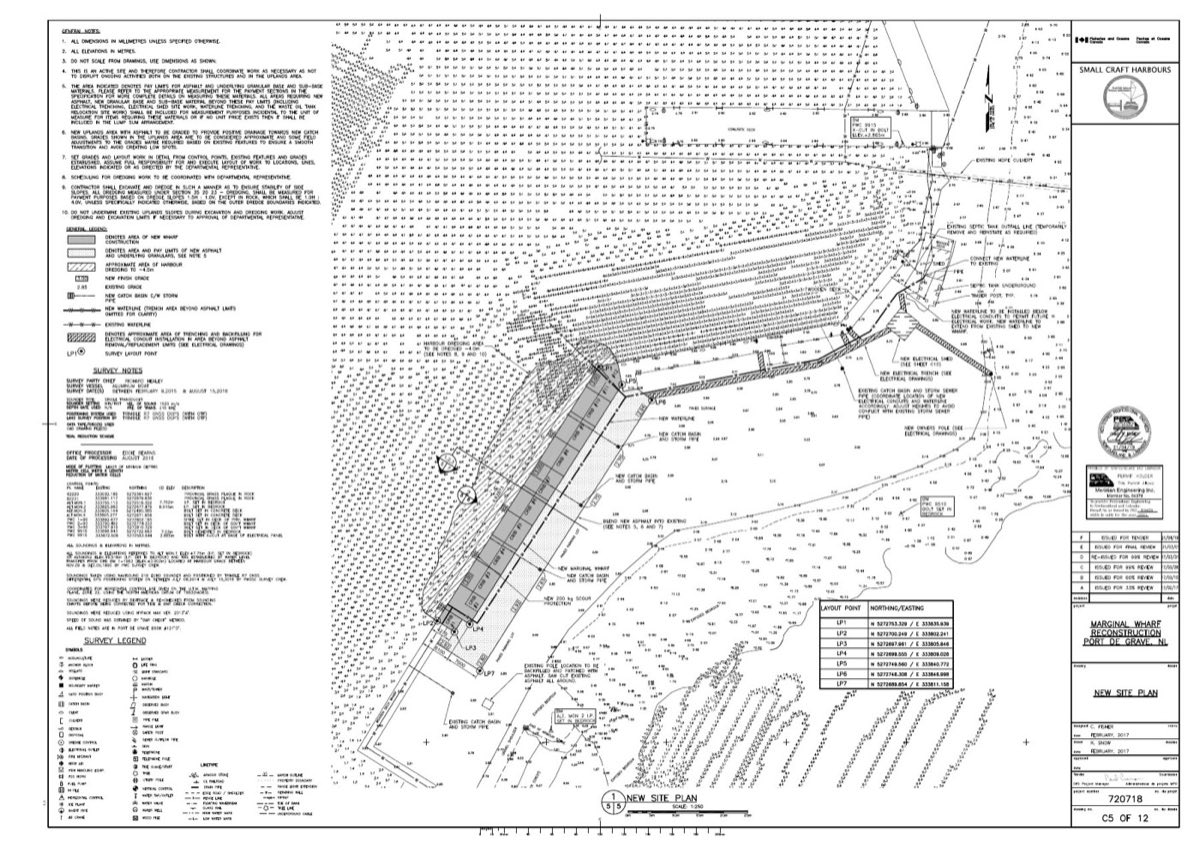

The contract covers complete demolition and disposal of the existing marginal wharf; removal and reinstatement of asphalt and services; a new treated-timber crib marginal wharf with reinforced-concrete deck and slab-on-grade; crib scribing to bedrock or rock mattress where required; rock scour protection; cribseat excavation and harbour dredging including rock removal if required; rock fill, granulars and asphalt; light poles and protection bollards; catch basins and storm sewer; relocation of the waste-oil tank; new water and electrical trenches; and an electrical shed and site upgrades. The mooring specification requires 225-kilogram Type A cleats on reinforced-concrete pedestals.
Marine interfaces
The package joins wharf demolition, dredging and cribseat preparation inside an operating fishing harbour. The dredging specification separates Class A rock from Class B material, requires a licensed explosives specialist for blasting, navigation marking for floating equipment, controlled disposal and PSPC survey verification before an area is accepted as cleared. Timber cribs, rock mattress, concrete deck, scour protection, service reinstatement and harbour access therefore share one constrained marine workfront.
Commercial evidence boundary
CanadaBuys reports a CAD 1,547,256 initial award, a CAD 32,768 amendment on 9 November 2022, a CAD 1,763,368 cumulative total on 14 December 2022 and a CAD 183,344 amendment dated 19 January 2023. The two stated amendment values reconcile exactly to the cumulative total. Public Accounts report CAD 1,533,364 as amount contracted and expenditure to date, with note f for contract completed. CAD 1,533,364 multiplied by 1.15 rounds to CAD 1,763,369, one dollar above the CanadaBuys total; this is consistent with HST and ledger rounding, not proof of the tax basis printed by either source.
Contract and delivery chain
Work packages and named roles
Published scope, named parties and supporting evidence for each workstream.
Construction prime
F6140-210731/001/PWD
Named party
Maher's Contracting Limited
Evidence status
Confirmed
Source position
CanadaBuys records the 15 November 2021 award, initial CAD 1,547,256 value and lowest-price procedure. Source
Wharf and dredging scope
Marginal wharf, dredging, cribseat, utilities and site works
Named party
DFO, PSPC and Maher's Contracting
Evidence status
Confirmed
Source position
The official bid package fixes the 50-week term, timber-crib and concrete configuration, dredging controls, utility scope and detailed construction drawings. Source
Contract amendments
Amendments 001 to 003
Named party
PSPC and Maher's Contracting
Evidence status
Confirmed
Source position
CanadaBuys records CAD 32,768 and CAD 183,344 amendment values and a CAD 1,763,368 cumulative contract total. Source
Completion and expenditure
Federal Public Accounts ledger
Named party
Fisheries and Oceans Canada and Maher's Contracting
Evidence status
Confirmed
Source position
The 2022-23 Public Accounts list CAD 1,533,364 as amount contracted and expenditure to date and apply note f, defined as contract completed. Source
Lower-tier supply chain
Dredging, blasting, timber, concrete, electrical, survey and marine plant
Named party
Undisclosed subcontractors and suppliers
Evidence status
Undisclosed
Source position
The reviewed official records identify the prime and work packages but no named lower tiers.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
The published amendment completes the arithmetic from the initial award and amendment 001 to the CAD 1,763,368 cumulative contract total; its work scope is not disclosed.
Maher's received the integrated reconstruction award
The award placed wharf demolition, timber-crib reconstruction, concrete deck, dredging, scour protection, drainage and utilities under Maher's as the integrated prime.
