Project record

Sainte-Marie-Sur-Mer structure 401 wharf and breakwater works

Participation
Not assessed
Project facts checked

L Breau and Sons Ltd holds active CAD 8.75 million contract CW2440554 through 24 August 2027 for structure 401 wharf reconstruction and a new breakwater; mobilisation, measured work and acceptance remain unconfirmed

Project sources

L Breau and Sons Ltd received CAD 8,745,856.95 contract CW2440554 from Public Services and Procurement Canada for Sainte-Marie-Sur-Mer structure 401 in New Brunswick. The official procurement title combines wharf reconstruction with a new breakwater, while the published description specifically replaces the existing timber-crib wharf with a Berlin-wall structure over a 79-week period. DFO's harbour register classifies Sainte-Marie-Sur-Mer as a core fishing harbour managed by Administration Portuaire de Ste-Marie-St-Raphael. Breakwater dimensions, lower tiers, mobilisation, installed quantities and owner acceptance remain unpublished.

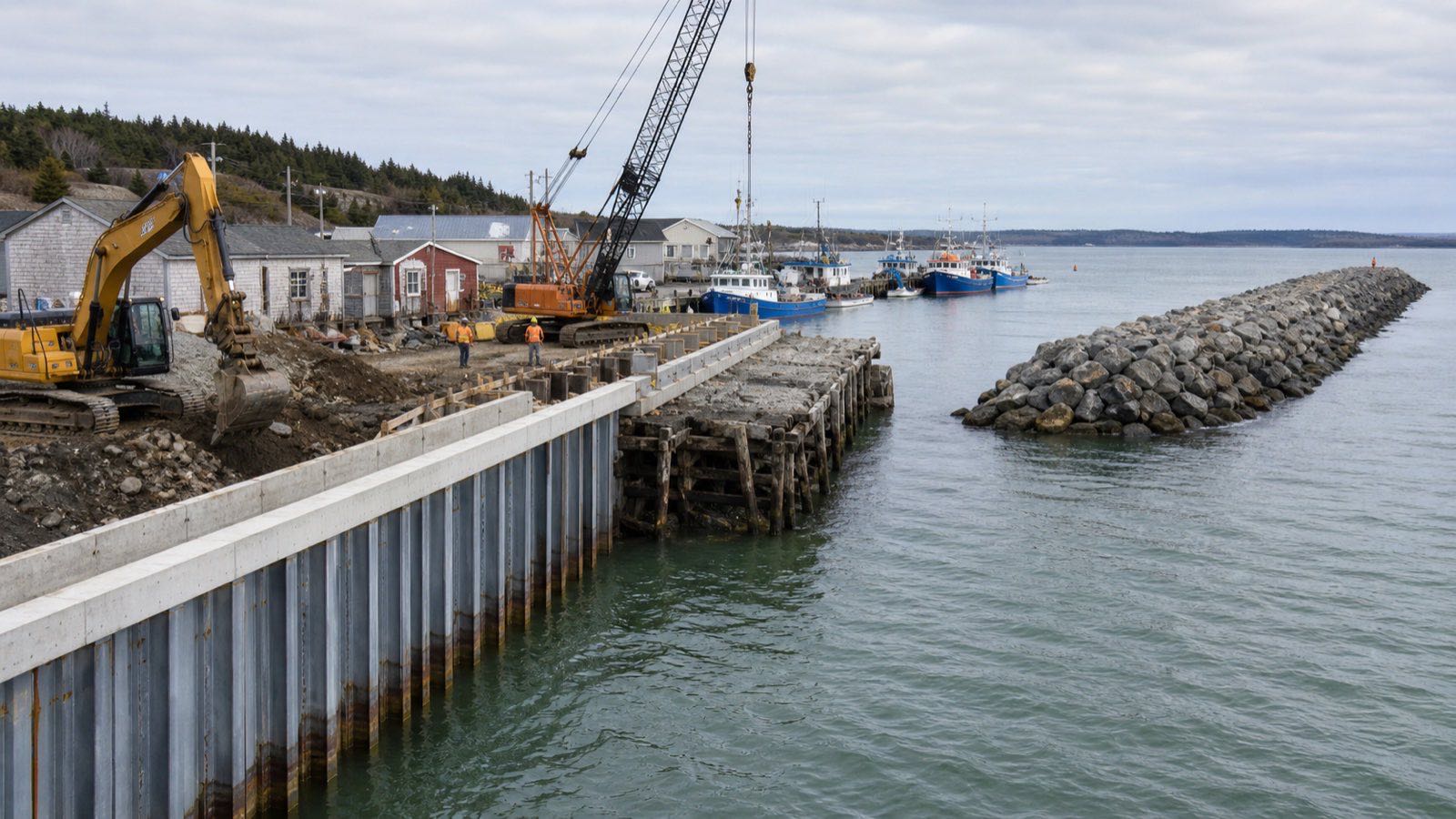

Structure 401 as a Berlin-wall wharf replacing timber cribwork beside a new breakwater in Atlantic Canada

IMWO artist's impression of the published Sainte-Marie-Sur-Mer structure 401 wharf and breakwater works scope

Location

Canada / Americas

Segment

Fishing harbour wharf, dredging and shore protection

Phase

Delivery / Confirmed

Last checked

7 August 2026

Coverage

Related sectors

Fishing harbour wharf, dredging and shore protection is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Public Services and Procurement Canada (PSPC) is listed as contracting and end-user entity; DFO's separate harbour register identifies Sainte-Marie-Sur-Mer as a core fishing harbour managed locally
Delivery parties
L Breau and Sons Ltd - prime contractor under CW2440554, Steel wall, piling, concrete, armour rock, marine plant, survey and environmental lower tiers - not named in the cited public records
Contract route
PSPC issued solicitation WS5486006650 as a Canadian construction tender. CanadaBuys records nine tender amendments, a 17 February 2026 award to L Breau and Sons Ltd, active contract CW2440554 and a CAD 8,745,856.95 total. The public open-data record does not publish bid ranking, lower-tier awards or a priced workstream split.
Execution window
The tender required completion within 79 weeks of award. CanadaBuys records a contract term from 17 February 2026 to 24 August 2027. Those dates establish the commercial window only; no cited source confirms notice to proceed, first piling, breakwater mobilisation, percentage complete or a handover milestone.
Works package
The official title covers reconstruction of structure 401 and a new breakwater. The tender description specifically calls for replacement of the existing timber-crib wharf with a new Berlin-wall wharf structure at Ste.-Marie-sur-Mer in Ste.-Marie-St.-Raphael. Public records do not state wall length, pile type or count, cap and deck quantities, breakwater alignment, armour grading, quarry source or dredging requirement.
Marine interfaces
Delivery must coordinate demolition of an existing timber-crib waterfront, steel retaining-wall installation, cap and berth reinstatement and a separately titled breakwater workstream inside a working core fishing harbour. Critical interfaces include temporary berthing, old-crib stability, pile toe conditions, fill retention, marine access, armour supply, environmental controls and safe release of structure 401.
Commercial evidence boundary
CanadaBuys reports CAD 8,745,856.95 as the base active contract amount under amendment 000. The tender's CAD 5 million to CAD 20 million estimate is a pre-award category and must not be added to the contract. No public split allocates value between wharf, breakwater, demolition, steel, concrete, rock, marine plant or local services.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Prime award

CW2440554 structure 401 reconstruction

Named party
L Breau and Sons Ltd
Evidence status
Confirmed
Source position
CanadaBuys records the 17 February 2026 award, CAD 8,745,856.95 value and 24 August 2027 contract end. Source
Wharf system

Timber-crib replacement with Berlin-wall structure

Named party
PSPC and L Breau and Sons Ltd
Evidence status
Confirmed
Source position
The official tender description identifies the existing timber crib and Berlin-wall replacement system. Source
Breakwater

New breakwater structure

Named party
PSPC and L Breau and Sons Ltd
Evidence status
Reported
Source position
The official procurement title includes a new breakwater, but the published description supplies no alignment, section, material or quantity detail. Source
Delivery and lower tiers

Mobilisation, construction, inspection and handover

Named party
Undisclosed delivery chain
Evidence status
Not evidenced
Source position
The cited records do not name subcontractors or publish physical progress, accepted quantities or owner handover.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

L Breau and Sons received the structure 401 award

The CAD 8.75 million award placed the Berlin-wall wharf replacement and title-level new-breakwater package under one named prime contractor.

Source

PSPC published the integrated harbour requirement

The December solicitation fixed a 79-week delivery period and identified structure 401's existing timber crib and replacement Berlin-wall system.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Notice to proceed and physical mobilisation
  • Berlin-wall length, pile schedule and toe conditions
  • Breakwater alignment, armour grading and quarry source
  • Temporary berthing and harbour access plan
  • Named steel, concrete, rock, survey and marine-plant lower tiers
  • Contract amendments and certified progress
  • As-built geometry and structural acceptance
  • Structure 401 handover and return to service

Reporting status

Project phase
Delivery
Evidence confidence
Confirmed
Last checked
7 August 2026
