Location
China / Asia Pacific
Project record
China Media Group / Hao Ziyang; Daorenji construction overview published 28 April 2025
Hunan's inland-waterway green-port programme links three terminal components: six berths at Daorenji and six at Songyanghu on the Yangtze, plus three proposed berths at Songmu on the Xiang River. Local approvals and procurements have advanced Daorenji and Songyanghu III even though AIIB's USD 200 million sovereign-financing proposal remains at Proposed status. The record therefore separates lender preparation from locally financed delivery, and separates the active Daorenji and Songyanghu packages from still-unverified Songmu II construction.
China / Asia Pacific
Inland-waterway green-port programme, open-piled bulk and general-cargo berths
Daorenji's main marine structure was reported complete in July 2026 with equipment installation and commissioning next; Songyanghu III moved from 1,556 precast deck panels into field installation in January 2026; no current Phase II construction evidence has been found for Songmu. AIIB still lists the proposed sovereign financing as Proposed / Confirmed
2 August 2026
Coverage
Inland-waterway green-port programme, open-piled bulk and general-cargo berths is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.

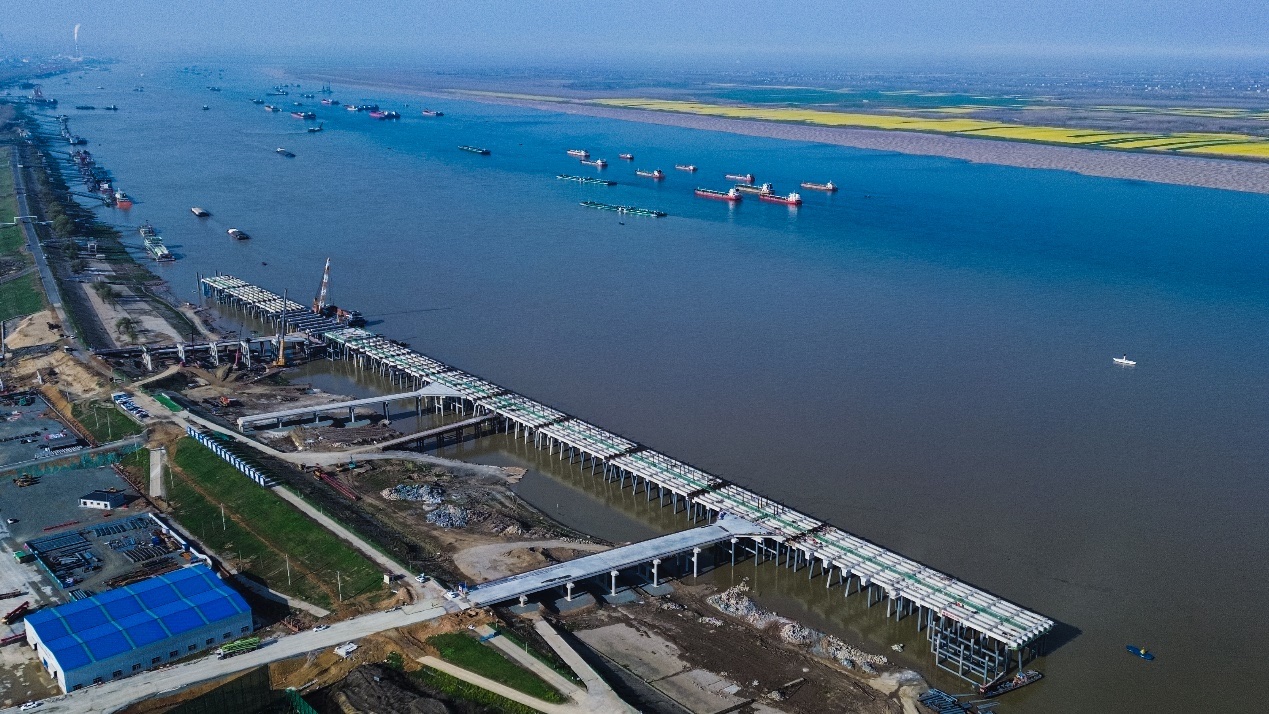

Open this project in the Change LogHunan's waterway authority reported that CCCC Second Harbor had completed the principal marine structure and installed the floating pontoons. Equipment installation, integrated commissioning, terminal acceptance and commercial operation remain separate later milestones.
SourceThe project completed all 1,556 precast deck panels and moved into on-site installation. This is component-production progress, not six completed berths or operating release.
SourceThe official result named Hangzhou Huaxin Mechanical & Electrical Engineering as winner at CNY 66.2288 million, creating a separate equipment-delivery lane after the main civil package.
SourceThe start notice defined six 5,000-tonne berths, a CNY 1.344 billion component investment, 758 metres of shoreline and 7.6 million tonnes per year throughput, moving this component beyond the lender concept stage.
SourceThe official progress record dated pile work from 29 March to 7 August 2024 and confirmed the high-pile berth geometry. Pile completion did not establish upper-structure, equipment or terminal completion.
SourceThe candidate notice ranked CCCC Second Harbor first at CNY 609,322,049.97. Later government progress records confirm it as contractor; the candidate price remains a bid figure unless a controlling contract result publishes the executed amount.
SourceThe PSI defined Daorenji, Songyanghu and Songmu components, Category A safeguards and a proposed USD 200 million loan. It did not constitute approval, signing, effectiveness, disbursement or a works award.
SourceHunan's state-assets authority reported the component start after September 2022 approval, demonstrating that local project delivery advanced independently of a later AIIB approval decision.
SourceEvidence gap
