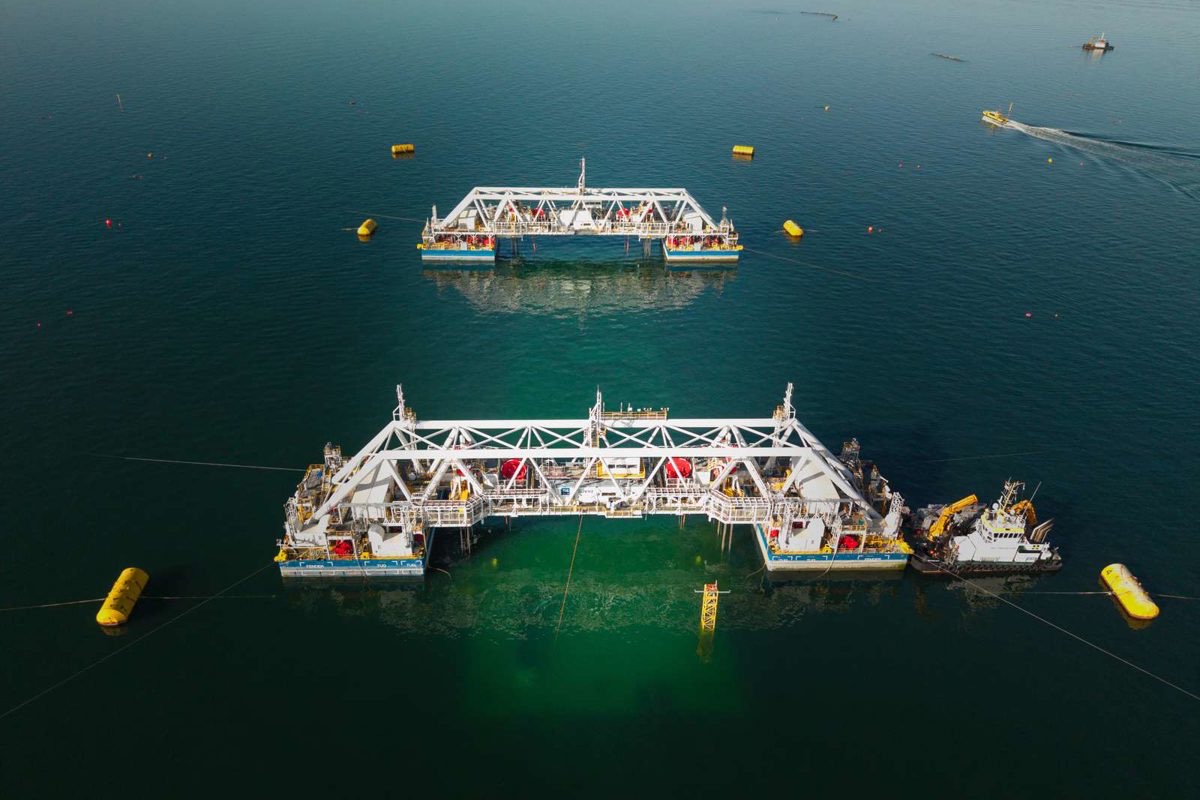

Femern A/S and Femern Link Contractors have moved the 18-kilometre Denmark-Germany fixed link into a three-element repeat sequence. The third standard element left Rødbyhavn on 30 July, was immersed on 31 July and connected on 1 August 2026. Each unit is 217 metres long and more than 73,500 tonnes. Three of 89 elements are now in place, but the owner has not published a new installed-length total, accepted protection quantity, series production rate or replacement opening date.
Denmark / Germany / Europe
Immersed tunnels and marine crossings
Third tunnel element immersed and connected on 1 August 2026; protection, serial immersion, systems integration, and a two-stage road-then-rail opening remain active / Confirmed
2 August 2026
Coverage
Immersed tunnels and marine crossings is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogFLC completed a third tow, immersion and connection sequence, after which stone and gravel protection began. The owner confirms three of 89 elements in place but does not publish a new installed-length total, accepted protection quantity, mature cycle time or overall completion percentage.
SourceThe owner record demonstrates an early repeat of the 73,500-tonne tow, positioning, immersion, and joint sequence and reports more than 500 metres installed; it does not establish mature series cadence, completed protection, or overall tunnel completion.
SourceThe decision changes the operating-release sequence and makes German railway landworks a separate service dependency, while replacement road and rail opening dates, final systems acceptance, and cost effects remain unpublished.
SourceThe first-of-kind operation proves the initial 217-metre element could be towed, lowered, positioned, laser-confirmed, and hydraulically connected, without proving repeat productivity or acceptance of the remaining 88 elements and systems.
SourceThe preparation update establishes that the immersion-vessel delay made a 2029 opening unrealistic and that a new overall schedule would follow early immersion experience; it does not publish replacement dates or a revised final cost.
SourceThe owner record closes the main dredging phase at about 15 million cubic metres and identifies FBC's Boskalis-Van Oord delivery role, while bedding, immersion, backfill, protection, portals, systems, and opening remain separate packages and gates.
SourceEvidence gap
