Project record

Höfn Grynnslin 2025 maintenance dredging

Participation
Not assessed
Project facts checked

Jan De Nul confirms that trailing suction hopper dredger Tristão da Cunha deepened the Höfn access channel between January and February 2025; the measured quantity and post-dredge acceptance remain unpublished, and a separate Boskalis contract now covers 2026-2028

Project sources

Hornafjarðarhöfn procured a weather-window maintenance-dredging campaign across Grynnslin, the ebb shoal outside Höfn's tidal harbour entrance. Official records show Jan De Nul selected after three technically scored bids and a 20 August 2024 contract conclusion. Jan De Nul then deployed trailing suction hopper dredger Tristão da Cunha in January and February 2025 and says the campaign kept the fishing port accessible.

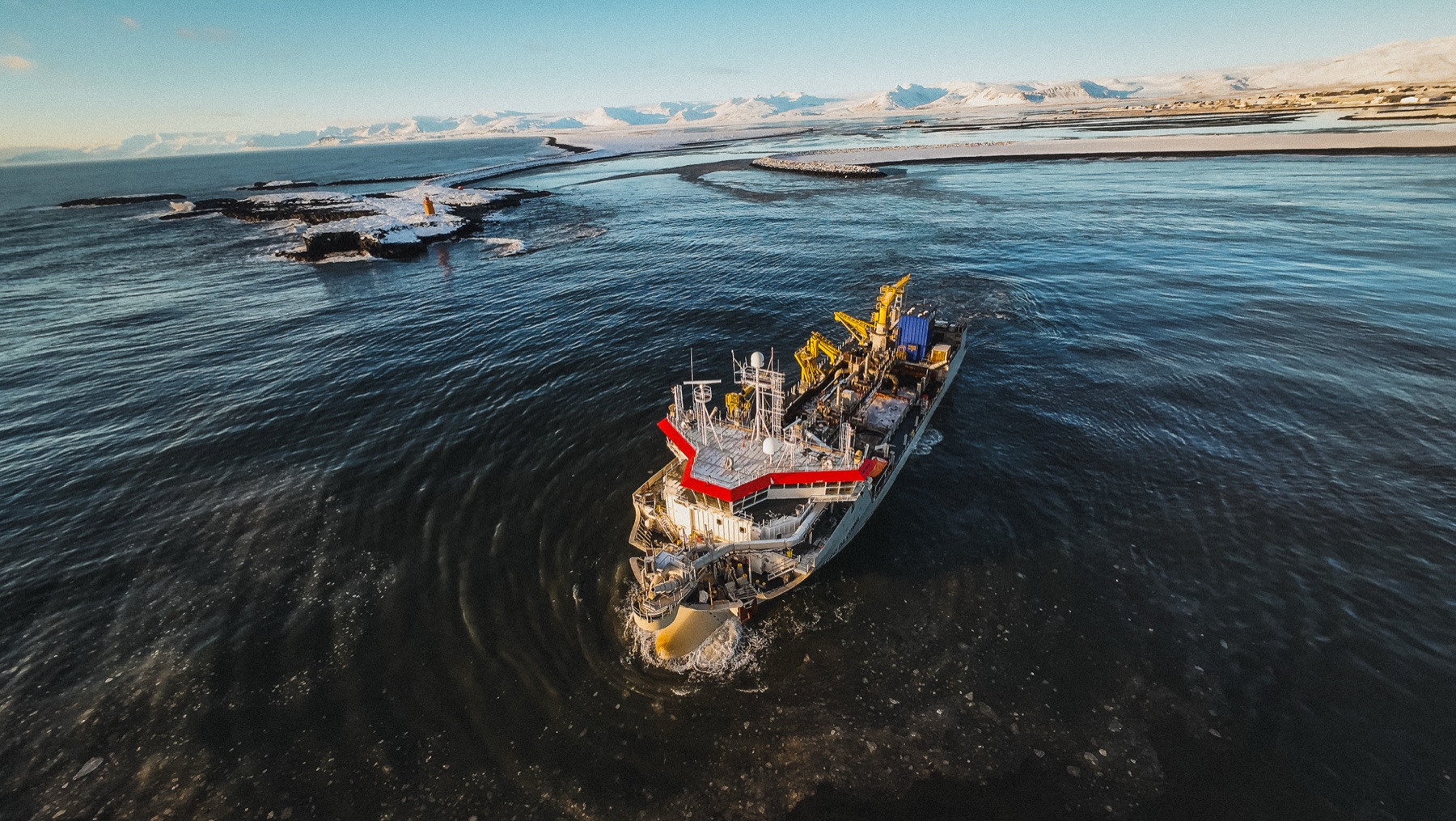

Jan De Nul trailing suction hopper dredger Tristão da Cunha working in the snow-lined Höfn entrance channel during the 2025 Grynnslin campaign

Jan De Nul Group; exact Höfn 2025 dredging campaign

Location

Iceland / Europe

Segment

Maintenance dredging and operating-port access

Phase

Completed / Confirmed

Last checked

2 August 2026

Coverage

Related sectors

Maintenance dredging and operating-port access is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Hornafjarðarhöfn, with Vegagerðin administering tender 24-077
Delivery parties
Jan De Nul NV - awarded dredging contractor and operator of trailing suction hopper dredger Tristão da Cunha for the January-February 2025 campaign, Björgun hf. and Gebr. van der Lee Dredging B.V. - unsuccessful technically scored bidders; not project contractors, Boskalis Westminster Ltd. - successor contractor under a separate 2026-2028 recurring-maintenance agreement, not a subcontractor to the 2025 campaign
Contract route
Vegagerðin administered open tender 24-077 for Hornafjarðarhöfn. The official tender record scored Jan De Nul at 90 technical points, Björgun at 75 and Gebr. van der Lee Dredging at 60, then recorded contract completion with Jan De Nul on 20 August 2024. TED procedure 658696c8-d7d4-4806-be9d-5bf84752e471 records the award, an ISK 300 million result value and a 20 August 2024 contract-conclusion date.
Execution window
The invitation defined a 2 January to 15 March 2025 work period using standby and active hourly rates when weather allowed. Jan De Nul's current project page and 2025 impact report narrow physical execution to January and February 2025 and identify Tristão da Cunha. No later public owner record provides a measured quantity, post-dredge survey or acceptance date.
Works package
Provide a dredger on standby and active rates to deepen the navigation channel across Grynnslin, the mobile ebb shoal outside Hornafjarðarós, when weather conditions permitted. The reviewed 2025 records do not publish a guaranteed quantity, design depth, final channel width, placement volume or accepted as-built geometry.
Marine interfaces
Höfn's access crosses a shallow, mobile shoal exposed to Atlantic winter storms, high waves and strong tidal currents between the entrance headlands. Jan De Nul says wave conditions frequently stopped dredging and tidal currents complicated entry and exit. The work therefore combined production, standby and live-navigation constraints around a fishing port handling roughly 3,600 vessel movements a year according to the contractor's impact report.
Commercial evidence boundary
TED records an ISK 300 million result value for the Jan De Nul award. The invitation's standby and active hourly-rate model means that figure should not be converted into a unit rate or final paid amount without certified hours, quantities and the final account. The separate three-year Boskalis agreement signed in February 2026 establishes a successor maintenance route, not a variation, extension or subcontract under Jan De Nul's 2025 contract.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Boskalis signed a separate three-year successor contract

Hornafjarðarhöfn moved to annual maintenance under a 2026-2028 Boskalis agreement. The later package provides continuity evidence but does not disclose or revise Jan De Nul's 2025 measured result.

Source

Jan De Nul confirmed January-February execution

The contractor identified Tristão da Cunha and said the campaign deepened the access channel and kept Höfn accessible despite waves and tidal currents. Physical execution is confirmed, while quantity and owner acceptance remain open.

Source

Tender 24-077 concluded with Jan De Nul

Jan De Nul was selected after three technically scored bids for the January-March 2025 weather-window campaign; TED later recorded an ISK 300 million result value.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Archived measured dredging quantity for the 2025 campaign
  • Post-dredge hydrographic survey and achieved channel geometry
  • Owner acceptance or completion certificate
  • Final account against the TED result value
  • Weather downtime and standby versus active dredging hours
  • Material placement route and environmental close-out
  • Separation from Boskalis' 2026-2028 maintenance contract

Reporting status

Project phase
Completed
Evidence confidence
Confirmed
Last checked
2 August 2026
Cited sources
6

Sources and related records

Project changes Methodology Email a correction Project tracker

Project sources 6
