Project record

Husøy Fishing Port Deepening

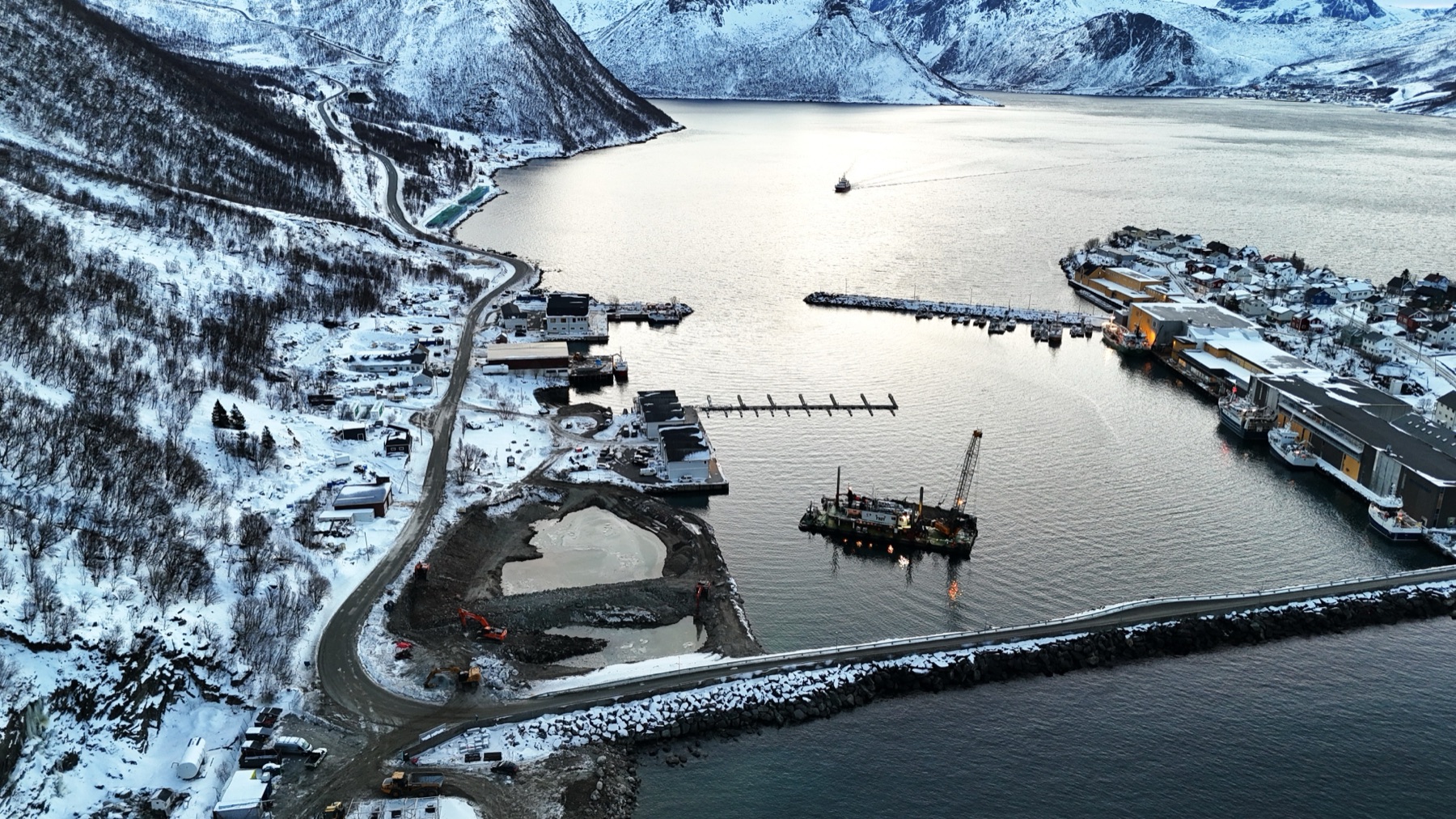

Aerial view of the active Husøy fishing port works in the fishing harbour, with shoreline containment, dredging plant, quays and breakwaters

Ole-Irgen Hammer / Kystverket; current Husøy construction overview

Kystverket is deepening Husøy fishing port on Senja from roughly 5–6 metres to an owner-stated -8 metres, with the tender describing a -8.3-metre design target. Norvald Jørgensen AS holds the approximately NOK 83 million main contract. Official Doffin award data declares eight subcontractors and a 36% subcontracting share; Kystverket's project presentation specifically identifies Gerd Stensen AS with dredging.

Project signal

Construction in Norway

Current status Kystverket's latest dated update records blasting complete and about 26,000 solid cubic metres of clean material dredged by 21 April 2026; the owner page says work remains in progress toward December 2026 completion Source confidence Confirmed

Location

Norway / Europe

Segment

Dredging

Status

Kystverket's latest dated update records blasting complete and about 26,000 solid cubic metres of clean material dredged by 21 April 2026; the owner page says work remains in progress toward December 2026 completion / Confirmed

Last checked

2 August 2026

Coverage

Related sectors

Dredging is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Kystverket (Norwegian Coastal Administration), acting on an assignment from Norway's Ministry of Trade, Industry and Fisheries
Delivery parties
Norvald Jørgensen AS - main contractor selected from six tenders and contracted by Kystverket, Gerd Stensen AS - official Doffin subcontractor specifically identified with dredging in Kystverket's project presentation and start-up meeting record, VVS-24 AS, Veidekke Industri AS, Finnsnes dykk og anleggsservice AS, Lynghaug Fjellsprengning AS, H K Sørensen AS, Arctic Maskin AS and Nordisk Fjellsikring AS - subcontractors declared in official Doffin award data; individual package allocations are not established by the cited public record
Contract route
Kystverket ran an open works procedure under Norway's procurement rules above the EEA threshold. TED records the competition as dredging and pumping works with marine construction, waterway construction, environmental improvement and contaminated-soil disposal classifications. Kystverket says six tenders were received, Norvald Jørgensen was selected on 19 September 2025 and the contract was signed on 3 October 2025.
Execution window
The competition notice scheduled work from 21 September 2025 to 25 December 2026. Kystverket records project start in autumn 2025 and planned completion in December 2026. Its 21 April 2026 update reported blasting complete, about 26,000 solid cubic metres of clean material dredged and dredging and placement planned to resume on 1 June; no later official production quantity has been located.
Works package
Dredge 115,000 cubic metres of loose material from the harbour basin to the owner's -8-metre target; the tender describes a -8.3-metre design depth. Establish a blasted and bunded shoreline containment area for contaminated material, route clean material to a seabed deposit, place up to 10,000 cubic metres of clean material in the northern fill and build a boat launch. The project presentation separately uses rounded design quantities of approximately 22,000 cubic metres contaminated and 98,000 cubic metres clean material, which should not be forced to reconcile with the owner's 115,000-cubic-metre headline scope.
Marine interfaces
The work is being delivered inside an operating fishing harbour that lands around 7,000 tonnes annually and experiences its busiest season from February to April. Dredging, blasting, barge transport, contaminated-material containment and clean-material placement must be coordinated with fishing vessels, fish landing, relocated floating pontoons, high- and low-voltage services, water lines, temporary access, drainage, rock processing and reinstatement.
Commercial evidence boundary
Kystverket describes the contract as approximately NOK 83 million. The official Doffin result publishes NOK 82,950,376 as the result value and NOK 83,245,688 as the value of all contracts awarded in the procedure; it also reports received tenders from NOK 83,245,688 to NOK 169,829,524. Those fields are preserved as distinct procurement values rather than reduced to one false exact contract price. Doffin marks subcontracting as 36% with value unknown and names eight subcontractors.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Blasting completed and clean dredging reached 26,000 fm³

Kystverket reported excavation and blasting complete subject to minor unforeseen work, about 26,000 solid cubic metres of clean material dredged and the project moving to bund and northern-fill construction before dredging and placement resumed.

Source

Owner presentation exposed the dredging subcontractor

Kystverket's start-up presentation identified Gerd Stensen with dredging and set out the sequence for contaminated and clean material handling, fills, utilities and reinstatement.

Source

Kystverket signed the main works contract

Norvald Jørgensen secured the approximately NOK 83 million contract after six tenders; official award data subsequently declared eight subcontractors and a 36% subcontracting share.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Dated dredging quantities after the announced 1 June restart
  • Package allocation for seven subcontractors whose roles remain unpublished
  • Contaminated-material excavation and sealed shoreline containment
  • Clean-material seabed placement and northern fill
  • Final -8 metre owner target and -8.3 metre tender design basis
  • Boat launch, utilities, access road, drainage and reinstatement
  • As-built hydrography and December 2026 completion

Reporting status

Construction, confirmed confidence

Last checked 2 August 2026 across 9 cited sources. The dated timeline above carries the project events.
