Project record

London Gateway Berth 5 quay and automated yard

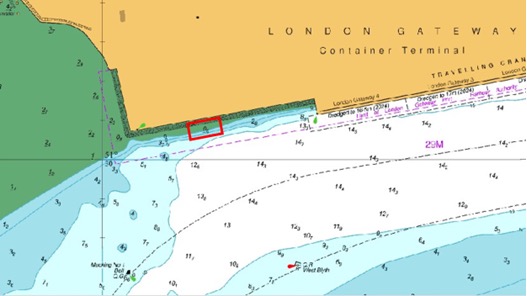

Port of London Authority chart marking the London Gateway Berth 5 and Berth 6 piling work area

Port of London Authority; exact navigation chart attached to Notice L6-26

DP World is expanding London Gateway with two additional all-electric berths. McLaughlin & Harvey is the confirmed contractor for the fifth-berth quay works, where Port of London Authority notices trace a 430-metre extension, steel tubular piling and named marine plant. Gobion separately reports a GBP 52 million contract for ten automated-stacking-crane yard modules. The quay-wall milestone does not establish completion of the yard, cranes, automation or commercial opening.

Project signal

Construction in United Kingdom

Current status Port of London Authority reported the 430-metre Berth 5 quay extension complete by 1 August 2026 while further retaining-wall piling continued toward the Berth 6 interface; the separately contracted ten-module automated yard remains on a contractor-reported programme to March 2027 Source confidence Confirmed

Location

United Kingdom / Europe

Segment

Deep-water ports and automated container terminals

Status

Port of London Authority reported the 430-metre Berth 5 quay extension complete by 1 August 2026 while further retaining-wall piling continued toward the Berth 6 interface; the separately contracted ten-module automated yard remains on a contractor-reported programme to March 2027 / Confirmed

Last checked

1 August 2026

Coverage

Related sectors

Deep-water ports and automated container terminals is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
DP World London Gateway, owner and operator of the Thames deep-water container terminal
Delivery parties
McLaughlin & Harvey - confirmed contractor for the Berth 5 quay works and steel tubular pile installation, Gobion - contractor-reported award for the separate ten-module automated container yard, including pavements, ASC rails and foundations, reefer plinths, drainage, utilities, substations, 11kV distribution and SCADA, Neptune 585 Eurobarge, Neptune NP674 barge, mult-cat Felix or similar, WSB Resolute and associated support craft - plant named in Port of London Authority notices; the notices do not convert every plant owner or operator into a confirmed subcontractor, No reviewed primary record allocates the Berth 5 quay cranes, automation systems, equipment commissioning or all downstream electrical and marine subcontracts to named suppliers
Contract route
DP World is funding a wider GBP 1 billion two-berth expansion. McLaughlin & Harvey is delivering the marine quay works for Berth 5. An official Find a Tender notice separately described the automated yard as a ten-module civil and electrical package with an estimated GBP 60 million value; Gobion later reported securing that package for GBP 52 million.
Execution window
DP World announced construction from May 2025 within a four-year two-berth programme. Marine piling was expected from August 2025 for about 18 months. The PLA stated on 1 August 2026 that the 430-metre Berth 5 extension was complete while a further 75 metres of retaining-wall piling continued into the Berth 6 formation. Gobion reports its yard programme running from late March 2026 to March 2027.
Works package
Extend the quay for Berth 5 and deliver a separate automated container yard with ten ASC modules, heavy-duty pavement, ASC rails and foundations, reefer and container plinths, drainage, utilities, substations, 11kV distribution, SCADA and live-terminal tie-ins. The wider DP World programme adds two 400-metre all-electric berths and a second rail terminal.
Marine interfaces
The tubular-pile quay and retaining wall must be released into a separate yard, crane, power, automation and operating-terminal integration sequence. PLA notices establish the marine geometry and plant window; they do not evidence yard acceptance, crane commissioning, terminal operating-system readiness or commercial service.
Commercial evidence boundary
The top-tier marine and yard packages are visible, but the interface ledger below them remains incomplete. The strongest current milestone is physical completion of the 430-metre Berth 5 extension. The yard award value is supplier-reported, while integrated handover and a Berth 5 opening date remain unconfirmed.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

The 430-metre Berth 5 extension was reported complete

PLA moved the marine quay record beyond mobilisation while explicitly showing further piling continuing into the Berth 6 formation.

Source

Gobion reported the automated-yard award

The contractor separated ten yard modules and associated civil, power and controls work from the quay package, with a reported March 2027 completion target.

Source

Marine plant mobilised for the quay extension

The PLA notice identified the main barge, crawler crane and support-vessel spread assigned to the 430-metre marine workfront.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Gobion yard mobilisation and March 2027 programme
  • ASC rail, foundations, substations and 11kV acceptance
  • Quay-crane supplier and delivery allocation
  • Automation, SCADA and terminal-system commissioning
  • Further 75-metre retaining wall at the Berth 6 interface
  • Downstream marine and electrical subcontract disclosures
  • Integrated Berth 5 handover and commercial opening

Reporting status

Construction, confirmed confidence

Last checked 1 August 2026 across 8 cited sources. The dated timeline above carries the project events.

Last checked 1 August 2026 Cited sources 8
