Project record

Upper Mississippi Lock and Dam 9 miter-gate replacement

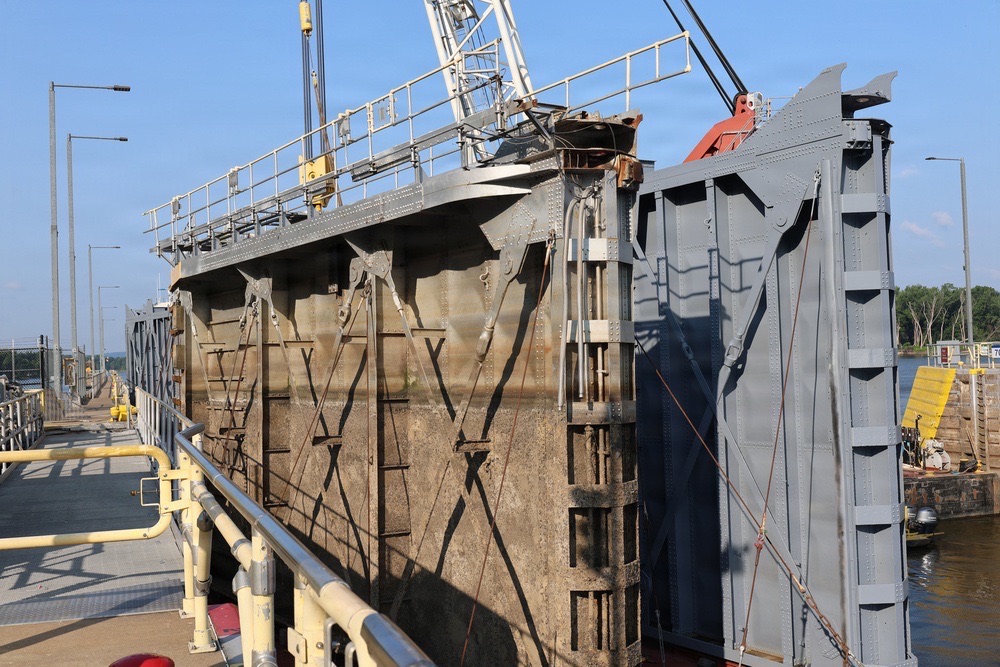

Old and new steel miter gates beside the Lock and Dam 9 replacement workfront near Lynxville, Wisconsin

USACE St. Paul District photo by Melanie Peterson via DVIDS; photographed 21 July 2026; public domain

Federal navigation crews replaced all four main-chamber miter gates at Lock and Dam 9 near Lynxville, Wisconsin, in July 2026. G&G Steel of Russellville, Alabama, fabricated the gates over about two years; they then moved by barge to the site. St. Paul District's maintenance and repair crew installed them with Rock Island District personnel and the 500-ton heavy-lift crane The Quad Cities. The four-day installation completed a four-to-five-year USACE design and delivery effort, but the public sources do not disclose G&G Steel's fabrication-contract value, fabrication subtiers, transport contracting, accepted installation cost or final account.

Project signal

Completed in United States

Current status USACE reports that all four main-chamber miter gates were replaced in July 2026 by St. Paul and Rock Island District maintenance and repair crews; G&G Steel fabricated the gates in Alabama, while accepted installation cost, final account and post-installation performance remain unpublished Source confidence Confirmed

Location

United States / Americas

Segment

Inland navigation lock rehabilitation and hydraulic steel structures

Status

USACE reports that all four main-chamber miter gates were replaced in July 2026 by St. Paul and Rock Island District maintenance and repair crews; G&G Steel fabricated the gates in Alabama, while accepted installation cost, final account and post-installation performance remain unpublished / Confirmed

Last checked

11 August 2026

Coverage

Related sectors

Inland navigation lock rehabilitation and hydraulic steel structures is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
U.S. Army Corps of Engineers, St. Paul District, with Rock Island District delivery support
Delivery parties
G&G Steel, Inc. - confirmed fabricator of the Lock and Dam 9 miter gates in Russellville, Alabama, USACE St. Paul District maintenance and repair crew - field installation team named by USACE, USACE Rock Island District maintenance and repair personnel - joint installation support and operator of the 500-ton heavy-lift crane The Quad Cities, Fabrication subtiers, coating suppliers, barge transport contractor and other private lower tiers - not identified in the cited public records
Contract route
USACE's project page identifies G&G Steel as fabricator but does not publish the fabrication solicitation, award identifier, contract value, competition record, delivery terms or modification history. The same page separately allocates fiscal-year 2026 funding of USD 1.5 million for the Lock and Dam 9 anchorage upgrade and USD 1.25 million for miter-gate installation. The completion story states that USACE professionals supervised construction and contracting and that USACE crews performed installation; neither source establishes a private installation award.
Execution window
The gates took approximately two years to fabricate in Alabama and were transported by barge to Wisconsin. USACE scheduled 12-hour lock closures on 14, 16, 21 and 23 July 2026 to replace all four gates, then reported the four-day installation complete on 11 August. The broader design-to-install effort lasted four to five years. Public sources do not disclose the fabrication notice to proceed, gate delivery date, post-installation acceptance date, defects period or final commercial close-out.
Works package
The completed package replaced two upstream and two downstream miter-gate leaves in the main lock chamber and upgraded the anchorages and pin plates supporting the heavier gates. USACE states that the new gates retain the original length, width and height but are about 50% heavier, were designed to modern codes using current ice and current knowledge, and carry a nominal 50-year design life. Published records do not provide dimensions, steel tonnage, coating system, bearing details, seal manufacturer, hydraulic or electrical modifications, testing criteria or as-built drawings.
Marine interfaces
Delivery combined inland-waterway heavy fabrication, barge transport, controlled commercial-navigation closures, removal and lifting of four large steel leaves, anchorage work and recommissioning inside an operating nine-foot navigation system. Rock Island District's 500-ton floating crane The Quad Cities was the named heavy-lift asset. The closures protected both commercial and recreational traffic, but no cited record identifies towage, rigging, diving, survey, temporary works or gate-component suppliers.
Commercial evidence boundary
USD 1.5 million for the anchorage upgrade and USD 1.25 million for gate installation are USACE fiscal-year 2026 funding lines. They do not disclose G&G Steel's fabrication award, actual obligations, internal force-account cost, transport price, accepted quantities, variations or final account. No cited public source assigns a private installation contractor or names fabrication subcontracts; reporting G&G Steel as installer would therefore be incorrect.

Contract and delivery chain

Named roles and open packages

Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.

Gate fabrication

Four main-chamber miter-gate leaves

Named party
G&G Steel, Inc.
Status
Confirmed
Source position
USACE names G&G Steel of Russellville, Alabama, as fabricator; the completion story says fabrication took approximately two years before barge transport to Wisconsin. Source
Anchorage preparation

Anchorage and pin-plate upgrades for heavier gates

Named party
USACE St. Paul and Rock Island District maintenance and repair teams
Status
Confirmed
Source position
USACE's programme page explains the anchorage and pin-plate work and assigns USD 1.5 million in fiscal-year 2026 funding; the cited records do not identify a private contractor. Source
Heavy-lift installation

Removal and replacement of four main-chamber miter gates

Named party
USACE St. Paul and Rock Island District maintenance and repair crews
Status
Confirmed
Source position
USACE reports a completed four-day installation using Rock Island District's 500-ton heavy-lift crane The Quad Cities. Source
Commercial close-out

Fabrication award, actual installation cost, variations and final account

Named party
USACE and G&G Steel
Status
Not evidenced
Source position
The official sources publish fiscal-year funding and role allocation but no fabrication-contract value, accepted force-account cost, subcontract ledger or final account.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

USACE reports four-gate installation complete

The project moves from scheduled summer work to reported physical completion, with the two-district USACE installation team and heavy-lift asset now public.

Source

Fourth planned 12-hour lock closure

The last planned closure completed the published four-date installation sequence; the 11 August USACE story later confirmed physical completion of all four replacements.

Source

USACE publishes fabricator and fiscal-year funding baseline

G&G Steel is fixed as gate fabricator while USD 1.5 million anchorage and USD 1.25 million installation lines remain separate public funding baselines.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • G&G Steel fabrication award identifier, value and modification history
  • Gate dimensions, steel tonnage, coating, seals and acceptance testing
  • Named fabrication suppliers and private lower tiers
  • Barge transport, towage, rigging, diving and survey responsibility
  • Actual cost against USD 1.5 million anchorage and USD 1.25 million installation funding
  • Post-installation testing, acceptance and defects close-out
  • Navigation availability and maintenance after the first operating season
  • Ice-season inspection and long-term 50-year design-life performance

Reporting status

Completed, confirmed confidence

Last checked 11 August 2026 across 4 cited sources. The dated timeline above carries the project events.

Last checked 11 August 2026 Cited sources 4

Sources and related records

Read featured analysis Methodology Submit a correction Project tracker

Project sources 4
