Project record

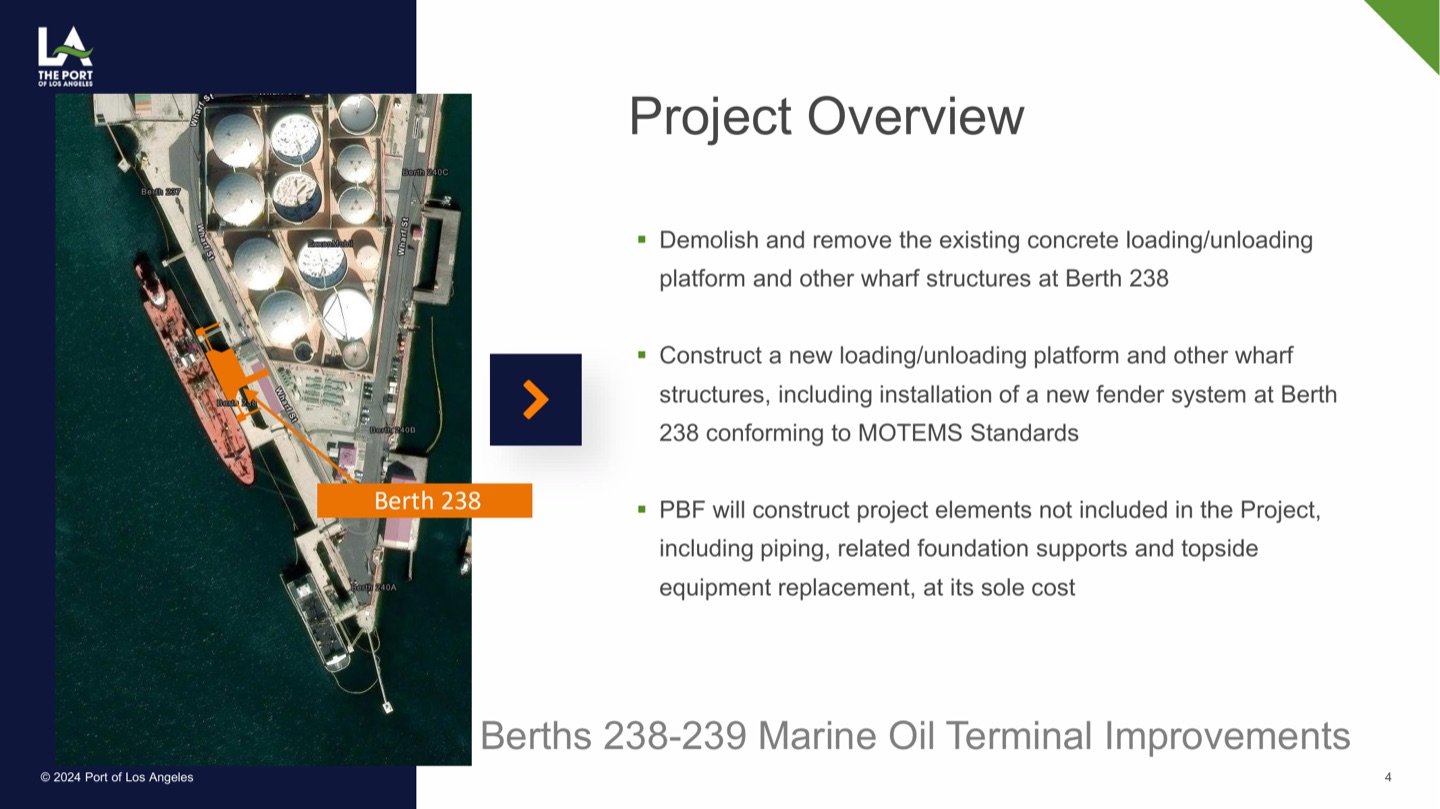

The City of Los Angeles Harbor Department awarded Specification 2792A and Contract 2326 to Manson Construction Co. on 24 April 2025. Manson's USD 27,414,900 bid, plus a 10% contingency for a USD 30,156,390 authorization, covers demolition of existing Berth 238 structures, a new 125 by 58 foot loading and unloading platform, access ramp, two berthing dolphins, four landside mooring dolphins, catwalks, fenders and a separate maintenance-dredging workfront at Berths 167-169. The official contractor list names 12 subcontractors worth USD 3,331,945. The January 2026 CIP report is the latest official progress baseline recovered: 22% construction complete through November 2025, with a 31 March 2027 forecast finish.
United States / North America
MOTEMS wharf replacement, dolphins, fenders and maintenance dredging
The Port of Los Angeles January 2026 CIP report classifies the project in construction and, using actuals through November 2025, records 22% construction completion, a 31 March 2027 forecast finish, USD 39,288,466 projected project cost and USD 6,315,074 spent to date / Confirmed
11 August 2026
Coverage
MOTEMS wharf replacement, dolphins, fenders and maintenance dredging is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract and delivery chain
Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogThe January CIP report confirms that the project moved from contract award into construction, with 22% completion reported through November 2025 and a revised finish forecast of 31 March 2027.
SourceManson becomes the prime contractor at USD 27.415 million, with a 10% contingency and 600-day term; the official attachment also resolves 12 subcontract packages.
SourceThe project and lease framework clear the environmental and property gates that precede the later construction award and tenant delivery programme.
SourceEvidence gap
