Vadhvan Greenfield Deep-draft Port

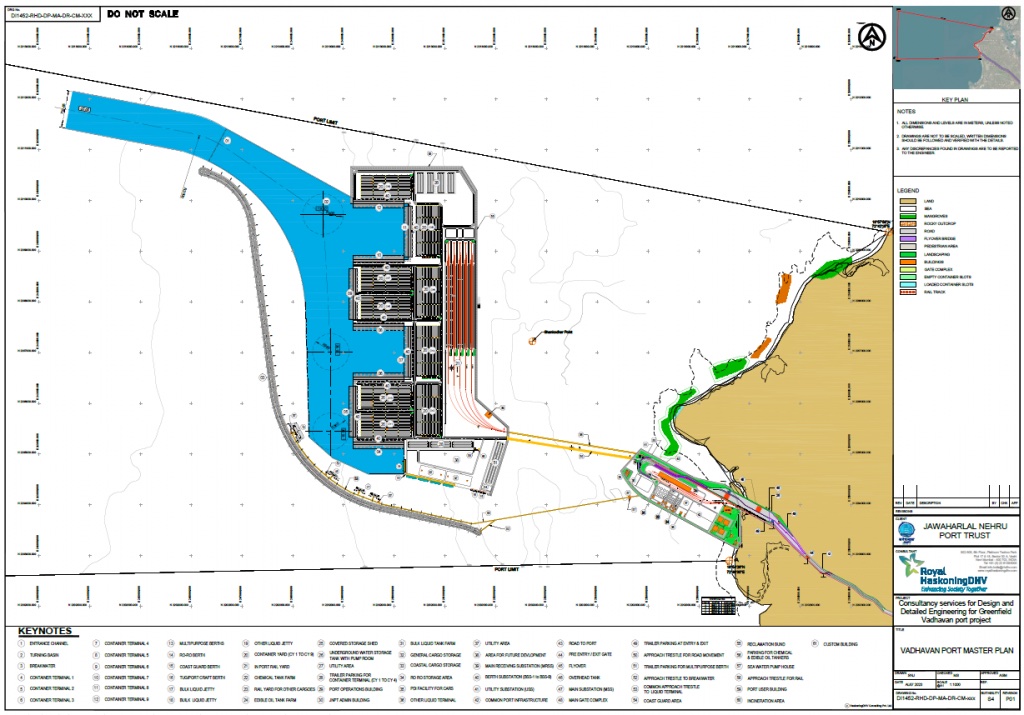

Official Vadhvan Port master-plan drawing showing the proposed offshore breakwater, reclaimed terminal platform, access channel, terminals and shore connections

Vadhvan Port Project Limited

Vadhvan is a planned two-phase, all-weather deep-draft port near Dahanu in Maharashtra. India's Cabinet approved an estimated INR 762.2 billion programme including land acquisition, with 1,448 hectares of sea reclamation, a 10.14-kilometre offshore breakwater, nine container terminals and other cargo facilities designed for 298 million tonnes and about 23.2 million TEU per year. Those are programme design figures, not built or operating capacity. VPPL awarded an INR 16.48 billion EPC package for about 200 hectares of nearshore reclamation and shore protection to ITD Cementation, now Cemindia Projects, in December 2024. The current owner-posted status file places the offshore breakwater in technical bid evaluation, while the official eProcurement status for the offshore dredging, reclamation and protection-bund HAM package does not show completed financial evaluation or an award of contract. A separate June 2026 tender covers investigation of an offshore Daman marine-sand borrow area; it is site investigation, not a dredging or reclamation award.

Project signal

Tender in India

Treat Vadhvan as a programme of separate marine, terminal and connectivity packages. Keep the awarded nearshore work distinct from the unawarded breakwater and HAM packages, and keep programme quantities distinct from package quantities. Track official award, mobilisation, design acceptance, survey and geotechnical baselines, dredging and reclamation, breakwater delivery, terminal and navigation systems, connectivity and phased operating proof before describing the port or any design capacity as delivered.

Current status The approximately 200-hectare nearshore reclamation and shore-protection EPC package is awarded; as of 15 July 2026, the owner tender page lists the offshore dredging, reclamation and protection-bund HAM package closing on 17 July and the Daman marine-sand investigation closing on 15 July, while no award or AOC is published for either package or for the 10.14-kilometre offshore breakwater Source confidence Confirmed

Location

India / Asia Pacific

Segment

Deep-water ports, dredging and reclamation

Status

The approximately 200-hectare nearshore reclamation and shore-protection EPC package is awarded; as of 15 July 2026, the owner tender page lists the offshore dredging, reclamation and protection-bund HAM package closing on 17 July and the Daman marine-sand investigation closing on 15 July, while no award or AOC is published for either package or for the 10.14-kilometre offshore breakwater / Confirmed

Evidence reviewed

15 July 2026

Controlled taxonomy

Related sectors

The detailed segment above is the primary work classification. These broader sector links connect the project to related delivery and market research.

Knowledge context

Related knowledge topics

Continue through the topic collections to compare this record with related projects, evidence guides, briefs, articles, reports, and performance records.

Project anatomy

Scope, counterparties, and execution logic

Client / authority
Vadhvan Port Project Limited
Delivery parties
Cemindia Projects Limited (formerly ITD Cementation India Limited) - nearshore package
Contract route
Vadhvan Port Project Limited is the project SPV, held 74% by Jawaharlal Nehru Port Authority and 26% by Maharashtra Maritime Board. The programme uses a landlord model: VPPL packages core infrastructure, terminals are planned through PPP structures, the nearshore reclamation and shore-protection package was awarded as EPC, and the offshore dredging, reclamation and protection-bund package is being procured on Hybrid Annuity Mode. Package values and award states must be reported separately; the Cabinet's programme estimate is not a single marine contract value.
Execution window
Cabinet approval was announced on 19 June 2024 and the foundation-stone ceremony followed on 30 August 2024; the ceremony did not establish physical marine mobilisation. VPPL approved the nearshore EPC award on 31 December 2024. The owner opened the offshore HAM tender on 22 August 2025 and its current tender page lists a 17 July 2026 close, while the separate Daman marine-sand investigation opened on 12 June 2026 with a listed 15 July close. The official April 2026 road-access release states that first-phase capacity of 15 million TEU is targeted for operation by 2030. Tender dates and the 2030 target are not evidence of award, marine completion, terminal commissioning or commercial service.
Works package
The awarded nearshore package covers development of about 200 hectares and shore protection. The proposed offshore breakwater is 10.14 kilometres long. The HAM tender presentation defines phase-one dredging of the access channel to at least -20 metres Chart Datum, an 800-metre turning circle and inner basin to at least -17.5 metres, berth pockets to at least -19.5 metres, marine-borrow-pit dredging, 850 hectares of phase-one offshore reclamation to +6.8 metres and a protection bund around a 1,207-hectare land parcel; phase two adds 357 hectares. Those levels, areas and durations are tender requirements, not as-built results. The Cabinet's 1,448-hectare overall reclamation figure and a separate workshop's 1,227-hectare statement use different programme definitions and should not be merged without a controlled master-plan or contract reconciliation.
Marine interfaces
The marine delivery chain spans borrow-area investigation, bathymetry and geotechnical baselines, dredging and material winning, offshore reclamation, settlement and ground improvement, perimeter protection, a deep access channel, turning and berth areas, the 10.14-kilometre offshore breakwater, navigation aids, pilotage and towage interfaces, terminal quay and utility packages and environmental monitoring. The June 2026 Daman tender seeks marine-sand-borrow investigation over a 90-day work period. It supports material-source definition only and does not prove environmental clearance, borrow approval, production suitability, awarded dredging or accepted fill.
Commercial read
Vadhvan has crossed programme approval and one enabling-package award, but the defining offshore works remain in procurement. The INR 16.48 billion nearshore award cannot be used as the value or contractor evidence for the INR 51.11 billion breakwater estimate or the INR 192.3857 billion HAM package estimate. Likewise, the 298 million-tonne, 23.2 million-TEU and 15 million-TEU figures are design or target capacities, not throughput. A nonofficial lowest-bidder report is not an award; package status requires an owner award, official AOC or equivalent contract evidence.
Next milestone
Seek an official award or AOC for the offshore breakwater and HAM packages; the Daman investigation award and accepted geotechnical/material reports; approved package designs and environmental controls; nearshore mobilisation and acceptance evidence; dated dredging, fill, settlement, bund and breakwater progress; terminal and utility awards; navigation and harbour-service readiness; external road and rail completion; trial calls; authority acceptance; and repeat commercial service.

Material change register

What changed, when, and what it proves

Only source-bound events that alter phase, scope, counterparties, delivery, completion, commissioning, or acceptance are listed. A change can advance the record without proving the next gate.

Owner opened a Daman marine-sand investigation tender

The 90-day investigation procurement advances definition of a potential offshore borrow area. Environmental or mining permission, material suitability, a production source, a dredging or reclamation award and accepted fill remain unconfirmed.

Read controlling source

NHAI awarded the port's external highway connection

The road award advances landside connectivity and carries the government's attributed 2030 first-phase operating target. It is not an award, mobilisation or completion record for the breakwater, offshore HAM package, terminals, rail, harbour systems or commercial port service.

Read controlling source

Owner opened the offshore dredging and reclamation HAM tender

The procurement covers offshore land creation by dredging, reclamation and protection-bund work. The current owner listing carries a 17 July 2026 close, but opening and deadline evidence do not establish technical or financial evaluation, AOC, contract execution, mobilisation or accepted output.

Read controlling source

VPPL approved the nearshore reclamation EPC award

The INR 16.48 billion award to ITD Cementation, now Cemindia Projects, covers about 200 hectares of nearshore reclamation and shore protection. It does not award the proposed offshore breakwater or HAM package and does not prove mobilisation, formed area, settlement performance or owner acceptance.

Read controlling source

Prime Minister laid the Vadhvan Port foundation stone

The ceremony records political launch of the approved programme. It carries no evidence of contractor mobilisation, dredging, reclamation, breakwater construction, terminal works, accepted capacity or port opening.

Read controlling source

Union Cabinet approved the Vadhvan Port programme

The approval established the INR 762.2 billion programme, SPV structure and design frame including overall reclamation, breakwater, terminals and planned capacity. Programme approval is not a package award, construction start, as-built result or operating record.

Read controlling source

Delivery watch

Evidence needed next

Seek an official award or AOC for the offshore breakwater and HAM packages; the Daman investigation award and accepted geotechnical/material reports; approved package designs and environmental controls; nearshore mobilisation and acceptance evidence; dated dredging, fill, settlement, bund and breakwater progress; terminal and utility awards; navigation and harbour-service readiness; external road and rail completion; trial calls; authority acceptance; and repeat commercial service.

Decision watchpoints

  • Official AOC or contract evidence for the 10.14-kilometre offshore breakwater
  • Official award state and final risk allocation for the offshore HAM package
  • Daman borrow-area investigation, environmental approval and material suitability
  • Reconciliation of the 1,448-hectare, 1,227-hectare and 1,207-hectare source definitions
  • Nearshore mobilisation, approximately 200-hectare formation and shore-protection acceptance
  • Channel, turning-circle and berth-pocket geometry supported by dated as-built hydrography
  • Offshore fill, settlement, ground improvement, protection bund and breakwater acceptance
  • Quays, terminals, utilities, navigation aids, pilotage, towage and emergency readiness
  • External road and rail integration
  • Navigation release, first commercial service and repeat operating evidence

Project availability status

This public project page is a tracked market record rather than a tender notice, contractual commitment, or commercial instruction. Use the status, confidence label, evidence-review date, and source note together when judging how much weight to place on the signal.

Read featured analysis Review methodology Submit stronger evidence or a correction Open project tracker

Record control

Evidence reviewed date is not a project-event date.

IMWO changes phase, participants, scope, completion, or acceptance wording only when a dated source establishes the change. The review date records when the evidence set was checked; it does not claim that physical work changed on that date.

Evidence reviewed 15 July 2026 Sources in this record 11

Source record

The Cabinet release controls the approved programme, SPV ownership, overall reclamation, breakwater, terminal and design-capacity figures. The 30 August 2024 PIB release controls the foundation-stone event and is ceremony evidence only. VPPL and JNPA control the nearshore EPC award and about-200-hectare scope. VPPL's status file and the central eProcurement portal control the reviewed procurement states for the breakwater and HAM packages; the owner tender page controls the current 22 August 2025 HAM opening, 17 July 2026 listed close, 12 June 2026 Daman opening and 15 July listed close. VPPL workshop presentations define proposed marine geometry and the HAM commercial model but carry disclaimers and do not establish award or physical completion. The April 2026 government release controls the road award and attributed 2030 first-phase operating target. Tender material, ceremony imagery, bidder reports and target dates do not establish an offshore award, construction start, accepted depth, reclaimed area or operating capacity.

Phase: tender. Evidence reviewed: 15 July 2026.

Project sources 11
