Casablanca, SADDN, Alkimos, Aqaba-Amman and Hassyan carry confirmed intake, outfall, tunnel, offshore-structure or commissioning scope. Taweelah C remains a watch until owner, EPC or environmental records define the physical coastal utility package.
The sector label is only the first clue
Power, desalination, mining-water, and bulk-conveyance announcements are usually organised around output: megawatts, litres per second, cubic metres per year, financing, or commercial-operation dates. The marine scope may sit several layers lower in an environmental assessment, EPC description, lender disclosure, construction update, or commissioning sequence. That is where intake towers, tunnels, shoreline shafts, cofferdams, trenching, outfall pipelines, diffusers, temporary jetties, dredging, diving, and marine monitoring become visible.
A coastal location is not enough. Marine scope is credible only with a project-specific physical interface, an attributable source, a delivery position, and a next event that can confirm or disprove the current reading. That threshold prevents two opposite errors: missing real marine work because the headline calls the scheme a power or water project, and inventing a marine package because a plant happens to be beside the sea.
Project screening method
From coastal plant to confirmed marine scope
The six checks trace the water path, construction method, acceptance interface, contract position and evidence needed to classify the marine work.
01
Start with project-level evidence
Use the owner, authority, lender, regulator, concessionaire, or named EPC source. Search the project record for seawater, cooling water, intake, outfall, tunnel, diffuser, marine pipeline, cofferdam, dredging, offshore structure, and discharge controls.
Source trail supports the coastal scope at project level.
02
Trace the complete water path
Follow water from the sea to abstraction, treatment or cooling, storage and conveyance, then back through brine, thermal discharge, or treated-water return. Include power and pumping systems that make the marine assets operable.
Abstraction-to-return system is bounded as one operating route.
03
Name the construction methods
Identify whether the route needs tunnels, shafts, trenching, drilling and blasting, floated pipe strings, piling, offshore lifts, risers, diffusers, revetment, temporary jetties, dredging, diving, or seabed protection.
Marine workfronts, specialist plant and access constraints are visible.
04
Map the acceptance chain
Connect the offshore and shoreline assets to plant, electrical, pipeline, control, environmental, and operating systems. Ask which interface can delay integrated testing or first reliable output.
Controlling handovers connect marine assets to reliable output.
05
Locate the contract and lifecycle gate
Separate financing, concession, EPC award, subcontract formation, construction, commissioning, and operations. Record which packages are committed and where supplier or service demand can still form.
Committed packages remain separate from open supplier demand.
06
Set confidence and next proof
Use Confirmed only for explicit project-level scope, Reported for attributable but incomplete evidence, and Watching when the connection remains a hypothesis. Name the next source or milestone that would change the classification.
Confidence can rise or fall against a dated next event.
Six-project evidence map
Physical marine scope and watch-stage assumptions
Five projects disclose a physical marine system in project-level sources; Taweelah C remains at watch stage until a coastal utility package is identified.
Offshore intake towers, submarine intake and brine-return corridor, blasted seabed trench, auxiliary pier, coastal sump, plant, pumping, and 160 km conveyance.
Next proof
Accepted marine systems, validated water quality and rated flow, continuous high-head pumping, distribution to all divisions, and owner-declared commercial operation.
Two bored marine tunnels, offshore intake structures, vertical risers, piled works, and a 130 m outfall diffuser installed from marine plant.
Next proof
Diffuser installation, outfall-tunnel completion, controlled breakthrough and permanent riser connections, followed by integrated marine-system testing.
The published scope does not define a project-specific cooling-water, intake, outfall, brine, seawater-pipeline or marine-civil package.
Next proof
An official EPC, environmental, procurement, design, or construction disclosure that identifies the physical coastal utility interface.
Five confirmed records expose different controlling interfaces
Casablanca concentrates risk in shared marine and tunnelling systems that must serve both desalination phases. SADDN connects an offshore intake tower and submarine corridor to 160 kilometres of high-head conveyance and a mine reservoir, so first water at the reservoir is a commissioning milestone rather than proof of full commercial operation. Alkimos requires bored tunnels from shore to meet offshore risers, structures, and a diffuser within survey and mechanical tolerances before integrated testing can start.
Aqaba-Amman is earlier in the cycle: the marine design is disclosed, but financial close and notice to proceed still control mobilisation. Hassyan is later: one block is commissioned, while intake-outfall acceptance, environmental performance and the remaining capacity are the next unresolved acceptance points. The physical vocabulary overlaps across these projects, but the open decision is different in each one.
Taweelah C defines the evidence boundary
Taweelah C is an awarded 2.6 GW combined-cycle project at the Al Taweelah Power and Desalination Complex, with commercial operation forecast for 2029. The reviewed owner, partner, and equipment announcements establish the IPP award, ownership structure, power-purchase arrangement, technology, and schedule. Those announcements do not define a project-specific cooling-water intake, outfall, brine, seawater pipeline, or marine civil package.
Taweelah C therefore remains a watch-stage example, not a confirmed marine-work case. It would qualify only when an EPC scope, environmental filing, procurement notice, design package or construction disclosure identifies the physical coastal system. Until then, the marine interface remains under review.
Commercial relevance moves with the lifecycle gate
At financing stage, the high-value questions concern bankable design, environmental conditions, package strategy, final quantities, baseline surveys, and notice to proceed. During construction, attention shifts to access, marine plant, temporary works, geotechnical and seabed conditions, tunnel or trench production, environmental windows, survey control, lifting, and interface handover. During commissioning, the market moves again toward inspection, corrosion and integrity management, water quality, diffuser performance, pumping reliability, spares, operator readiness, and sustained output.
The same intake or outfall description therefore does not imply the same opportunity. The contract may already be embedded in a concession or EPC package; the remaining value may sit with specialist subcontractors, monitoring providers, commissioning teams, or long-term operators. A credible market read states what is committed, what remains open, and which acceptance event changes the supplier map.
Acceptance evidence matters more than construction optics
A visible offshore structure, completed tunnel drive, delivered pipe string, or first flow can be important without closing the whole marine system. Intake and outfall assets still have to connect to plant, power, conveyance, monitoring, and operating controls; the relevant owner or authority must then accept performance against the applicable requirements.
Each project needs a milestone that can disprove the current reading: financial close, final design acceptance, mobilisation, diffuser installation, tunnel breakthrough, permanent connection, rated-flow testing, environmental compliance, owner acceptance or commercial operation. When that milestone changes, the project status changes. Until it does, the evidence level should not be promoted by inference.
Continue through the topic collections to compare this record with related projects, evidence guides, briefs, articles, reports, and performance records.

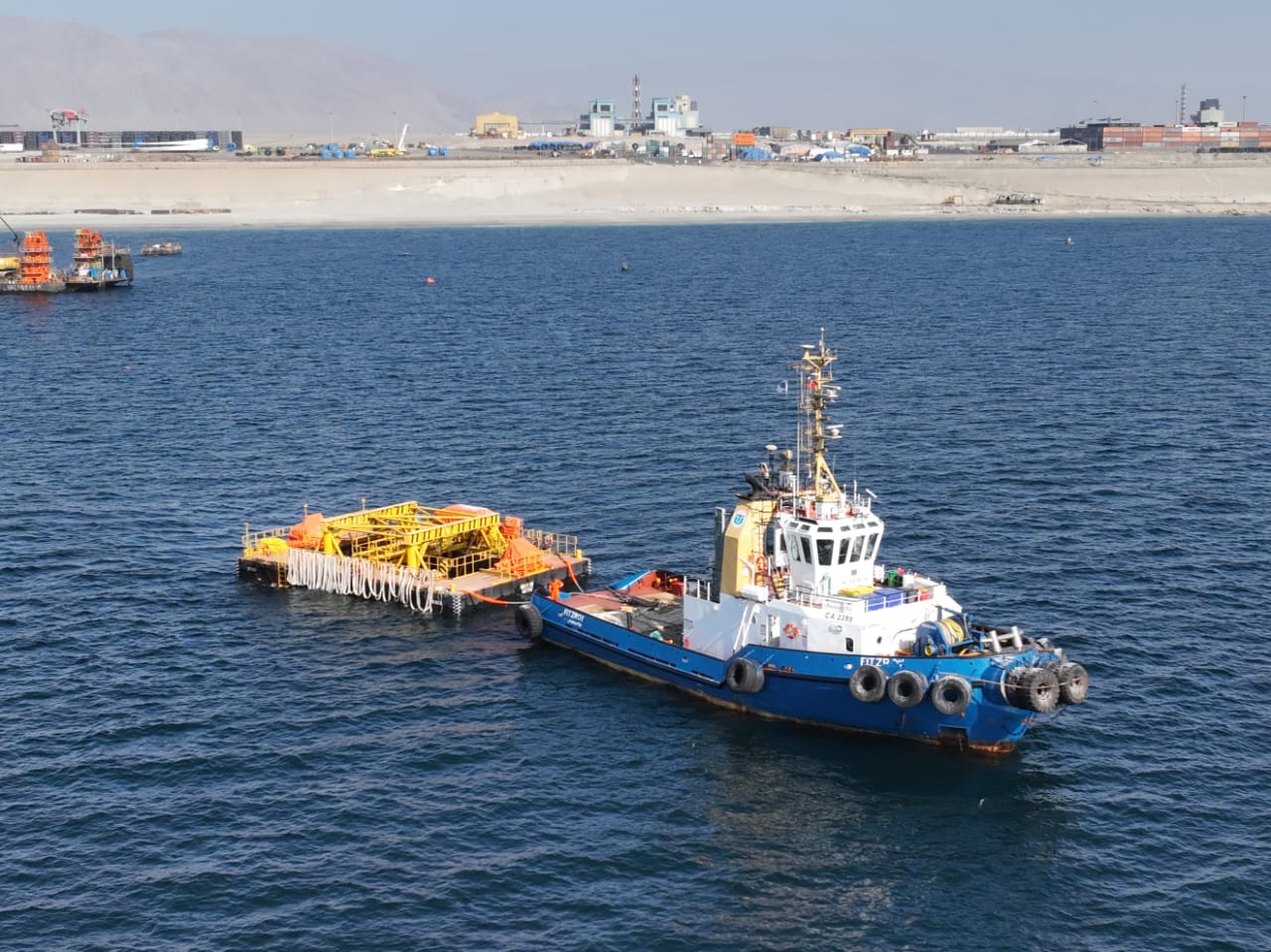

Used for the shoreline intake, cofferdam, nearshore outfall, temporary jetty, diffuser, seabed-protection, environmental, and construction-method evidence.
