Project record
Maher's Contracting received F6140-210681/001/PWD on 22 October 2021; two CanadaBuys amendments raised the tax-inclusive contract to CAD 2.76 million, and the 2023-24 Public Accounts mark the Winterton contract completed

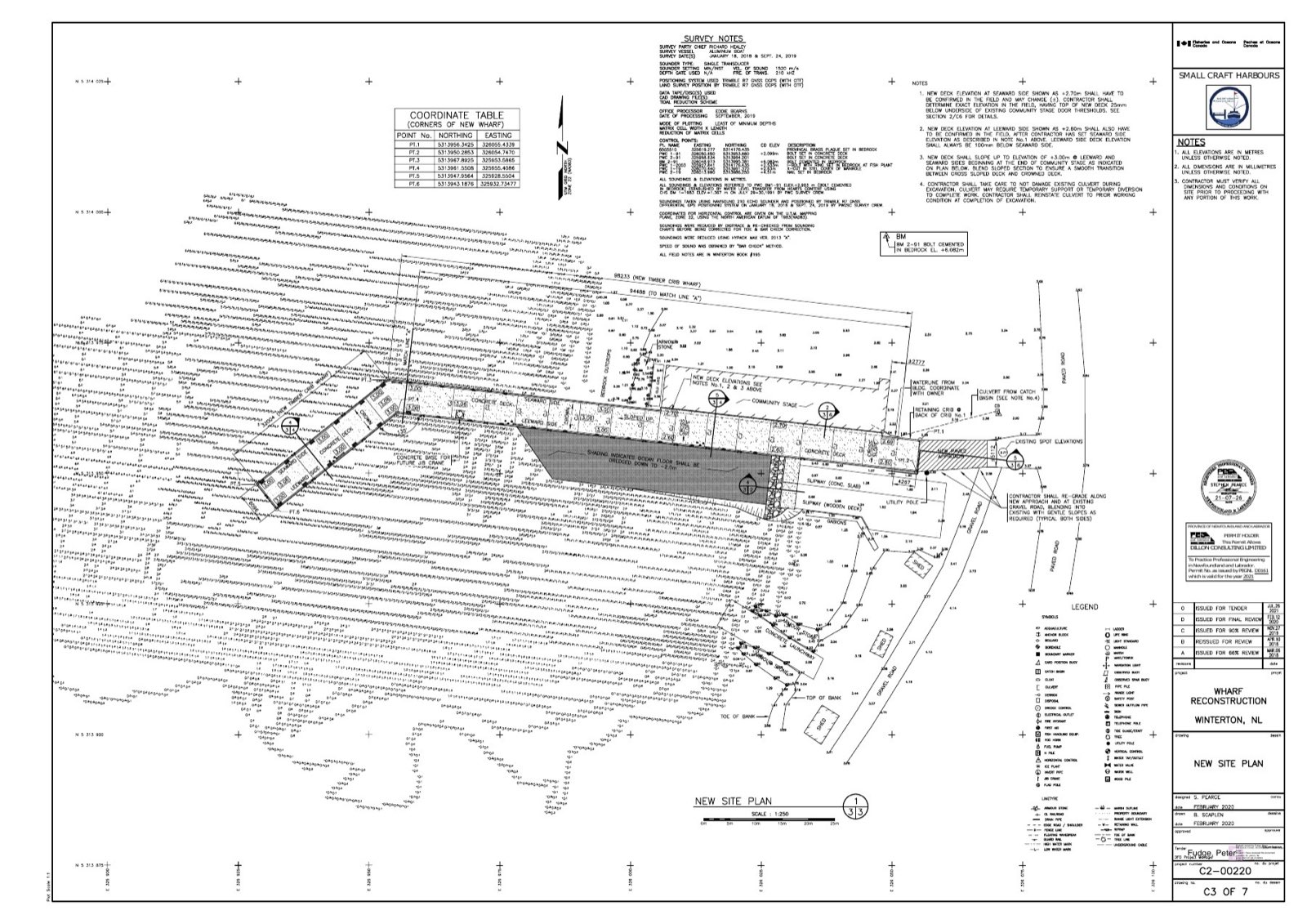

Maher's Contracting Limited received contract F6140-210681/001/PWD from Public Services and Procurement Canada for Fisheries and Oceans Canada's Winterton wharf reconstruction on 22 October 2021. The official package called for demolition of the existing crib-and-span finger pier; a new treated-timber crib finger pier with reinforced-concrete deck; 275 cubic metres of Class B dredging to -2.0 metres LNT; slipway-anchor cribs; approach, electrical and culvert work; and 60 cleats and mooring rings. CanadaBuys records an initial CAD 2,616,163.75 award and a CAD 143,750 amendment, reaching CAD 2,759,914. The 2023-24 Public Accounts separately report CAD 2,399,925 amount contracted, CAD 2,399,651 spent to date and the federal completion marker.
Canada / Americas
Fishing harbour wharf, dredging and shore protection
Completed / Confirmed
13 August 2026
Coverage
Fishing harbour wharf, dredging and shore protection is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract and delivery chain
Published scope, named parties and supporting evidence for each workstream.
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogThe federal ledger closes the contract-status gap and reports CAD 2,399,651 expenditure to date against its CAD 2,399,925 amount-contracted field.
SourceThe second amendment records the cumulative CAD 2,759,914 contract value and extends the published expiry from 18 November 2022 to 10 February 2023.
SourceThe published amendment adds CAD 143,750; this is exactly 1.15 times the CAD 125,000 increase visible between annual Public Accounts amount-contracted fields, but the change scope remains undisclosed.
SourceThe award placed finger-pier demolition, timber-crib reconstruction, concrete deck, dredging, slipway, mooring and electrical works under Maher's as the integrated prime contractor.
SourceEvidence gap
