Project record
Phase 1 plant construction and CBM equipment delivery are active. Masirah Marine is the reported installation lead; its contract, vessel allocation and ASD-tug support remain undisclosed
ACME's Phase 1 plant at Duqm is designed to export refrigerated green ammonia through a four-buoy Conventional Buoy Mooring. Engineers India Limited holds the offshore engineering consultancy, Bluewater the CBM agreement and Straatman the delivered and pre-commissioned control package. An industry source identifies Masirah Marine as the most likely selected installation contractor. The attribution is plausible but unconfirmed: Masirah publishes relevant Oman-based buoy, anchoring, pipeline, diving, survey and construction-barge capabilities, yet its project list does not name ACME, Bluewater or Duqm. Bluewater's project announcement describes its ACME scope as CBM delivery, while its wider company literature records a history of delivering and installing CBM systems. Masirah could therefore hold the full offshore installation package or a narrower marine-construction and diving subcontract. The operating spread is also incomplete in public sources. Masirah lists twin-screw tugs rather than ASD or anchor-handling vessels, and an Imodco/SBM Offshore Oman study calls for two ASD tugs during Khareef connection operations. Offshore mobilisation, the tug provider and accepted first transfer remain undisclosed.
Oman / Middle East
Deep-water ports and energy terminals
Construction / Confirmed
13 August 2026
Coverage
Deep-water ports and energy terminals is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract and delivery chain
Published scope, named parties and supporting evidence for each workstream.
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogMasirah's live portfolio still does not name ACME, Bluewater or Duqm, while its fleet shows relevant barges, diving and survey craft and three twin-screw tugs but no ASD or anchor-handling vessel. Imodco's two-ASD-tug Khareef requirement therefore exposes a separate undisclosed provider or charter interface.
SourceCurrent market intelligence identifies Masirah as the most likely selected installer, while its official portfolio demonstrates exact-fit buoy, SPM, subsea-anchor, chain, pipeline, diving, survey and marine-plant capability in Oman. No project-specific public award or mobilisation evidence confirms the appointment, so the role remains Reported rather than Confirmed.
SourceA project-team post showed water filling in progress for an approximately 3,178 m3 tank ahead of hydrotesting. It is current plant-construction evidence and a reported lower-tier contractor attribution, not proof of CBM mobilisation or installation.
SourceThe authority places USD 4.2 billion of investment, 800,000 tpa of green ammonia and 142,000 tpa of green hydrogen across the two later phases, with commercial operation planned for 2030 and 2033. The agreement governs a separate expansion track and leaves the Phase 1 CBM installation status unchanged.
SourceThe shipment is tangible Phase 1 plant-equipment progress under Sungrow's wider 320 MW supply agreement. Site installation, commissioning and every CBM marine scope remain outside this evidence.
SourceThe supplier confirms official delivery of 16 systems for ACME's 300 TPD project; company and industry records identify the batch as 80 MW. Delivery does not prove site installation or commissioning.

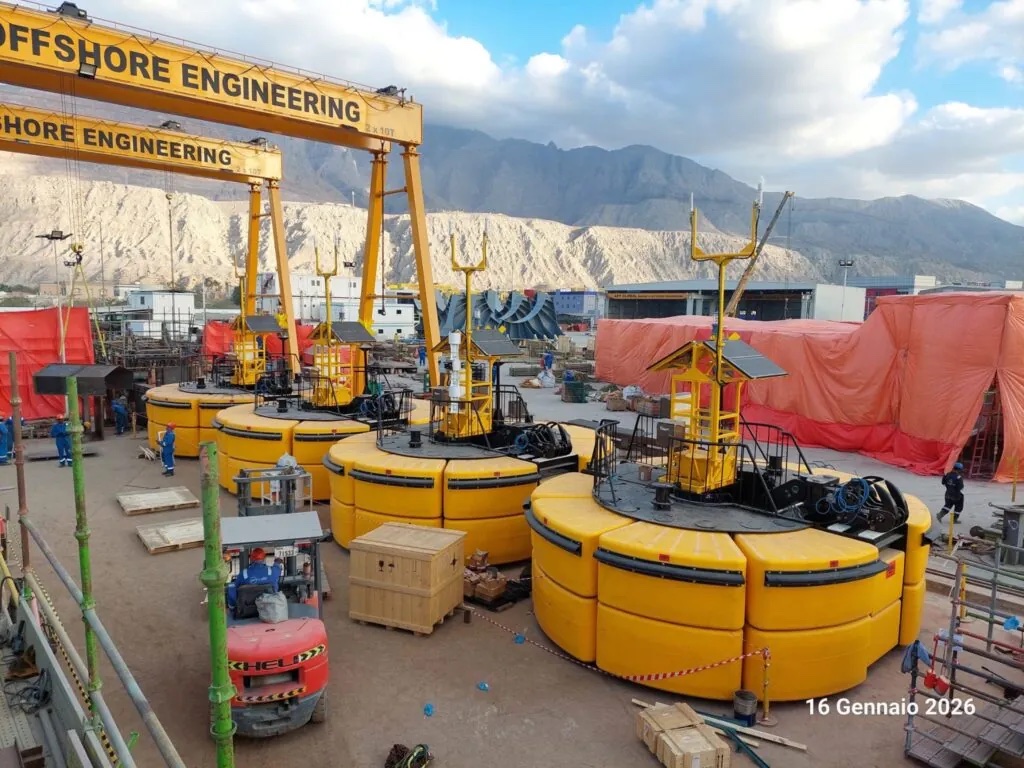

SourceThe supplier confirmed four offshore buoys, eight hydraulic release hooks in total and integrated power, navigation, control and telemetry systems. Its project thread confirms Resinex cooperation and places the assembled system at APT Global's Ras Al Khaimah yard, while offshore installation and acceptance remain open.
SourceThe Oman country manager said all major packages were ordered and construction was on schedule. The statement updates the plant programme while leaving CBM installation and plant commissioning unconfirmed.
SourceIts project case records 14 packages, including a 120-tonne piece, received under hook and moved through clearance, port handling, escorted transport and unloading at the Duqm site. This is plant logistics, not offshore CBM mobilisation.
SourceThe company identifies a 175 MWp SkyLine II tracker supply role for the 300 TPD project. It adds a named plant-side supplier without changing the marine installation gap.
SourceThe agreement fixed Bluewater's delivery role, identified the system as a CBM and linked it to refrigerated-ammonia export in 2027. It did not disclose the offshore installer or all downstream suppliers.
SourceThe disclosed investigation covered deep and shallow marine boreholes, CPT, pipeline routes and marine anchor points, followed by oceanographic data acquisition. It attributes pre-installation engineering work but does not identify the offshore construction installer.
SourceEIL's official order table identifies a consultancy contract valued at INR 61 million for the offshore portion of the 300 MTPD Phase 1 project, with March 2027 scheduled completion. This names the offshore engineering-services firm but does not identify the physical installation contractor.
SourceConstruction start moved the plant into execution, while the marine export system retained separate equipment, offshore-installation and operating-acceptance gates.
SourceThe 100,000 tpa long-term offtake created the future export demand and a 2027 supply objective, but did not prove marine infrastructure readiness.
SourceScatec removed the green-ammonia project from its pipeline because ACME chose to progress before debt financing, while retaining an option for potential second-phase participation. The disclosure removes Scatec from the evidenced current Phase 1 delivery chain.
SourceEvidence gap
