Project record

Callao access-channel and inner-roadstead maintenance dredging

Participation
Not assessed
Project facts checked

APN started the access-channel and inner-roadstead campaign on 20 December 2025; a Jan De Nul post-dredging environmental report covers January 2026 monitoring, while owner acceptance, as-built hydrography and final account remain unverified

Project sources

Peru's SEACE adjudications dataset identifies Jan De Nul N.V. Sucursal del Peru as award recipient for maintenance dredging in Callao's access channel and inner roadstead, with a source-reported awarded amount of USD 59,694,989.93. APN announced physical works from 20 December 2025 to an estimated 7 February 2026 and a safe-depth objective of up to -16.50 m. APN later published Jan De Nul's post-dredging environmental report, revised 9 March 2026 and based on January monitoring, establishing that the campaign reached a post-dredging evidence stage without proving formal owner acceptance or final commercial closeout.

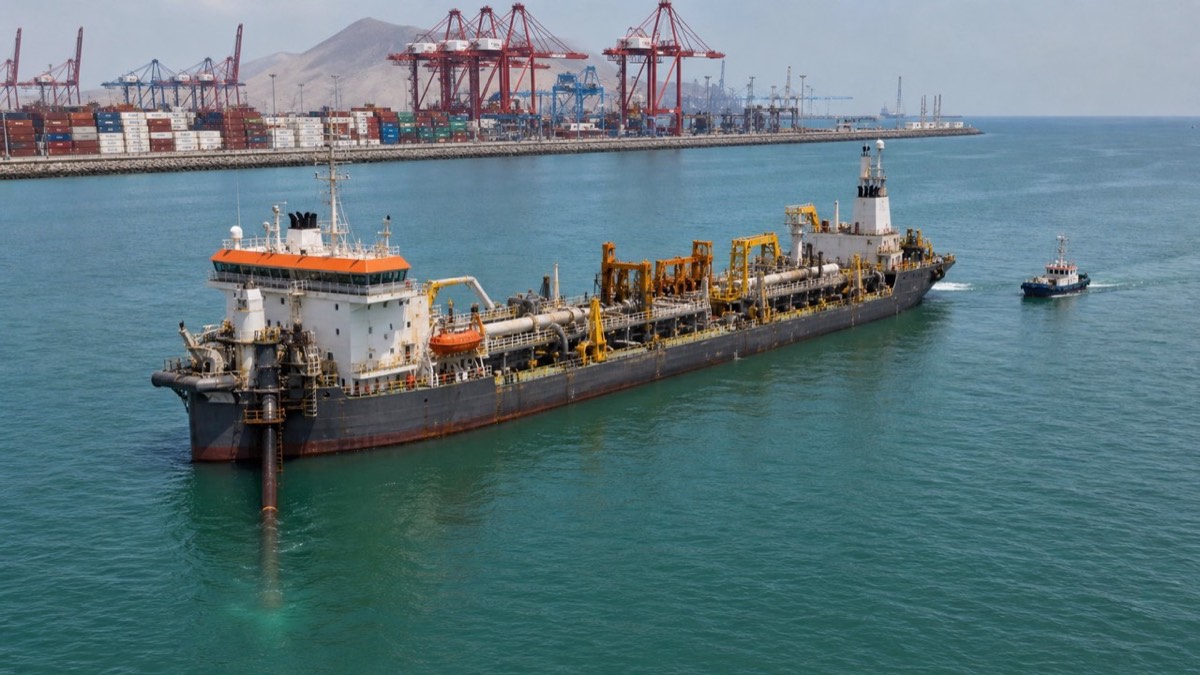

A trailing suction hopper dredger maintaining Callao's access channel beside the container port while survey and environmental-monitoring craft work nearby

IMWO artist's impression of the published Callao access-channel and inner-roadstead maintenance dredging scope

Location

Peru / Americas

Segment

Maintenance dredging and operating-port access

Phase

Commissioning / Confirmed

Last checked

5 August 2026

Coverage

Related sectors

Maintenance dredging and operating-port access is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Autoridad Portuaria Nacional under Peru's Ministry of Transport and Communications
Delivery parties
Jan De Nul N.V. Sucursal del Peru - SEACE award recipient and author of the published post-dredging environmental report, Hydrographic surveyor, disposal-site operator, environmental laboratories, marine support craft and other lower-tier providers - not identified in the cited public records
Contract route
The 2025 SEACE adjudications workbook classifies the specialized maintenance-dredging service as Contratado, names APN as buyer and Jan De Nul N.V. Sucursal del Peru as award recipient, and reports USD 59,694,989.93. The open-data row does not expose the executed instrument, variation history, payment certificates, taxes or final account.
Execution window
APN announced a 20 December 2025 start and an estimated 7 February 2026 finish without interrupting commercial vessel operations. The published post-dredging report records January 2026 monitoring and a 9 March 2026 document revision. These dates support a post-dredging phase but do not establish the owner's final completion certificate or commercial closeout.
Works package
The public package covers maintenance dredging in Callao's common port areas: the access channel and inner roadstead. APN's stated objective was to recover safe operating depths of up to -16.50 m. Public sources reviewed do not disclose the final measured volume, dredging limits by reach, over-dredge tolerance, vessel spread, disposal quantities, accepted depth surfaces or payment measurement.
Marine interfaces
The campaign interfaces with continuous commercial navigation, fisheries and mariculture activity, dredging and disposal controls, turbidity and water-quality monitoring, bathymetric survey, port traffic management and safe-depth release. PRODUCE recorded stakeholder concern and permanent environmental monitoring during works, making environmental closeout and transparent survey evidence material to acceptance.
Commercial evidence boundary
The USD 59.695 million SEACE awarded-item total is a procurement record, not a certified final account. Without the signed instrument and bill of quantities, it does not reveal the commercial split among dredging production, disposal, surveys, monitoring, standby, variation and support services.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

APN published the pre- and post-dredging environmental reports

The Jan De Nul report records January 2026 post-dredging monitoring and moves the evidence chain beyond award and mobilisation, while formal acceptance and final hydrography remain open.

Source

APN announced the start of maintenance dredging

Physical work was scheduled to begin at 19:00 in the access channel and inner roadstead, targeting safe depths up to -16.50 m and an estimated 7 February 2026 finish.

Source

SEACE published the contracted dredging service record

The open dataset names Jan De Nul N.V. Sucursal del Peru as award recipient and reports USD 59,694,989.93 for the specialized maintenance-dredging service.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Executed contract and notice-to-proceed record
  • Dredger, survey and support-vessel spread
  • Measured dredged volume and disposal route
  • Final bathymetry and accepted -16.50 m surfaces
  • Water-quality, sediment and fisheries monitoring closeout
  • Navigation release and uninterrupted-operations record
  • APN completion and acceptance certificates
  • Variations, payments and final account

Reporting status

Project phase
Commissioning
Evidence confidence
Confirmed
Last checked
5 August 2026
Cited sources
5

Sources and related records

Project changes Methodology Email a correction Project tracker

Project sources 5
