Project record

Gdynia Outer Port protective breakwaters

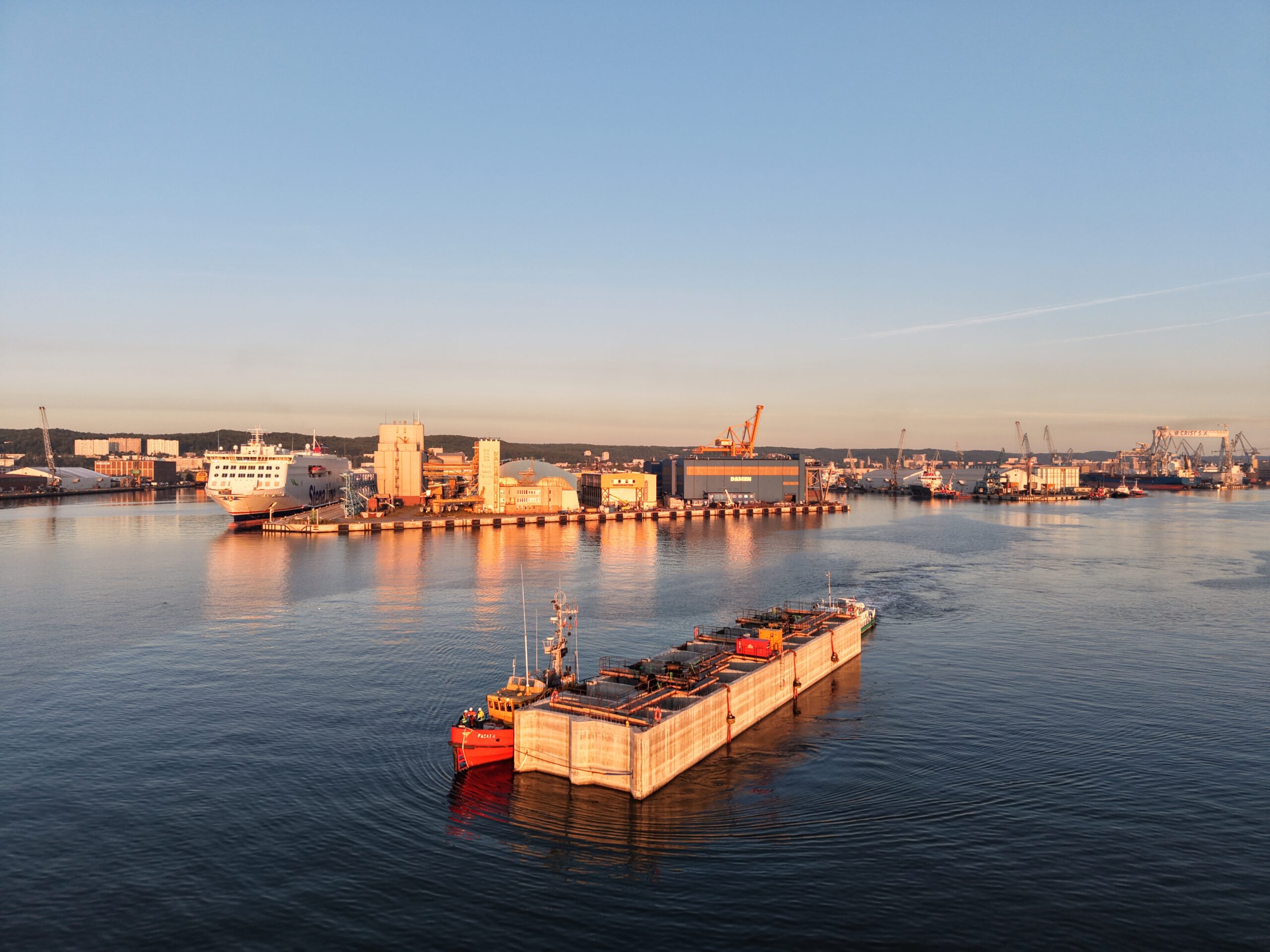

Gdynia Outer Port reinforced-concrete caisson under tow during the first launch for the protective breakwaters

Port Gdynia / D. Adamski; exact first-caisson tow in July 2026

The Maritime Office in Gdynia and Port of Gdynia Authority are delivering almost 2.5 kilometres of protective breakwaters for the future Outer Port through a PLN 438.70 million net design-build contract. Budimex leads the delivery consortium with a 50% share, while Roverpol and Rover Maritime each hold 25%. A May 2026 building permit enabled the transition to principal in-water works, and the first of 49 reinforced-concrete caissons was launched and towed toward its placement position in July. The legal consortium is confirmed; published project records do not name a downstream subcontractor.

Project signal

Construction in Poland

Current status The May 2026 building permit has moved the design-build contract into principal in-water works; the first reinforced-concrete caisson was launched and towed toward its placement position in July 2026, with the remaining 48 caissons and breakwater systems still to be delivered Source confidence Confirmed

Location

Poland / Europe

Segment

Caisson breakwaters and port access infrastructure

Status

The May 2026 building permit has moved the design-build contract into principal in-water works; the first reinforced-concrete caisson was launched and towed toward its placement position in July 2026, with the remaining 48 caissons and breakwater systems still to be delivered / Confirmed

Last checked

2 August 2026

Coverage

Related sectors

Caisson breakwaters and port access infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Director of the Maritime Office in Gdynia and Port of Gdynia Authority S.A. as joint contracting authorities
Delivery parties
Budimex S.A. - consortium leader and 50% participant, Roverpol Sp. z o.o. - consortium partner and 25% participant, Rover Maritime S.L. - consortium partner and 25% participant, Downstream design, caisson-production, towage, seabed-preparation, dredging, backfill, navigation-lighting and specialist marine subcontractors - not disclosed in published project records
Contract route
The joint contracting authorities tendered a design-build package in November 2023. Budimex reported on 25 March 2024 that its consortium's PLN 438,699,534.11 net bid ranked highest; the procedure remained unawarded on that date. TED records Contract MZ/67/KJ/MG/2024 concluded on 2 October 2024, and Budimex's same-day release confirms the signed consortium. The public investor report assigns 50% to Budimex and 25% to each Rover entity. It also records a 10% advance, 30-day payment term, 5% performance guarantee, 20% aggregate penalty cap and 10-year defects warranty. These are contract-level terms, not evidence of downstream subcontracts.
Execution window
The signed contract retained a second-quarter 2028 completion target. The tender baseline allowed up to 490 days for design and the building permit, followed by up to 819 days for construction and the occupancy permit. The building permit was approved in May 2026. The Maritime Office reported in July that close to 50 caissons were planned for launch over the following year; the first launch does not establish the pace, accepted quantity or final completion date for the remaining structures.
Works package
Design, permit and construct four independent protective breakwaters, reported in the current design at approximately 250, 800, 850 and 500 metres, and strengthen parts of the existing eastern main breakwater. The tender baseline included hydrographic and geophysical preparation, necessary seabed clean-up and dredging, possible soil replacement, caisson foundations and backfill, wave attenuators, navigation lighting and BIM-based design management. The July 2026 update fixes the current structural system at 49 reinforced-concrete caissons across almost 2.5 kilometres, with selected caissons incorporating wave-energy-dissipation chambers.
Marine interfaces
Caissons are produced directly on the water at the Bulgarian and Puck Quays using a floating pontoon and continuous slip-form concreting. The first reported unit was nearly 50 metres long, more than 13 metres wide and about 12 metres high, using 1,465 cubic metres of concrete and 185.8 tonnes of reinforcement. Budimex's signed-contract description gave a broader design envelope of about 50 by 13.6 metres and 14.5 to 16.5 metres high. Each unit must be floated, towed, aligned and founded on prepared seabed while the port remains active and environmental controls protect birds, fish and marine mammals.
Commercial evidence boundary
The main contract, value, clients, consortium and partner shares are transparent. The unresolved market layer is below the consortium: public sources do not allocate detailed design, survey, geotechnical work, seabed preparation, dredging, caisson fabrication labour, concrete and reinforcement supply, towage, marine plant, rock and backfill, navigation aids or testing among named subcontractors. Those names should be added only from an award, signed supplier disclosure, project reference or attributable site record.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

First reinforced-concrete caisson entered the waterborne installation sequence

The first of 49 planned caissons was launched and towed toward its placement position, marking the shift from design and permitting to principal hydrotechnical construction on the water.

Source

Building permit enabled principal marine works

The Maritime Office reports approval of the building permit in May 2026, closing the principal design-and-permit gate before the caisson installation programme.

Source

Joint authorities signed the design-build contract

Contract MZ/67/KJ/MG/2024 fixed the Budimex-Rover consortium, PLN 438,699,534.11 net value and the contractual route toward a Q2 2028 target.

Source

Joint design-build tender defined the enabling marine package

The procurement notice separated breakwaters, existing-structure strengthening, seabed preparation, dredging, foundations, backfill, wave attenuation and navigation lighting from the future terminal works.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • First caisson placement, foundation survey and acceptance record
  • Production and launch sequence for the remaining 48 caissons
  • Named detailed designer, surveyor and geotechnical subcontractors
  • Seabed preparation, dredging, soil-replacement and backfill quantities
  • Towage, floating-pontoon, crane and other marine-plant assignments
  • Breakwater-by-breakwater geometry and any change from the procurement baseline
  • Navigation lighting, wave attenuators and energy-dissipation chamber commissioning
  • Environmental monitoring for birds, fish and marine mammals
  • Occupancy permit, as-built hydrography, final account and Q2 2028 completion target

Reporting status

Construction, confirmed confidence

Last checked 2 August 2026 across 5 cited sources. The dated timeline above carries the project events.

Last checked 2 August 2026 Cited sources 5
