Project record

Fass Boye modern fishing quay

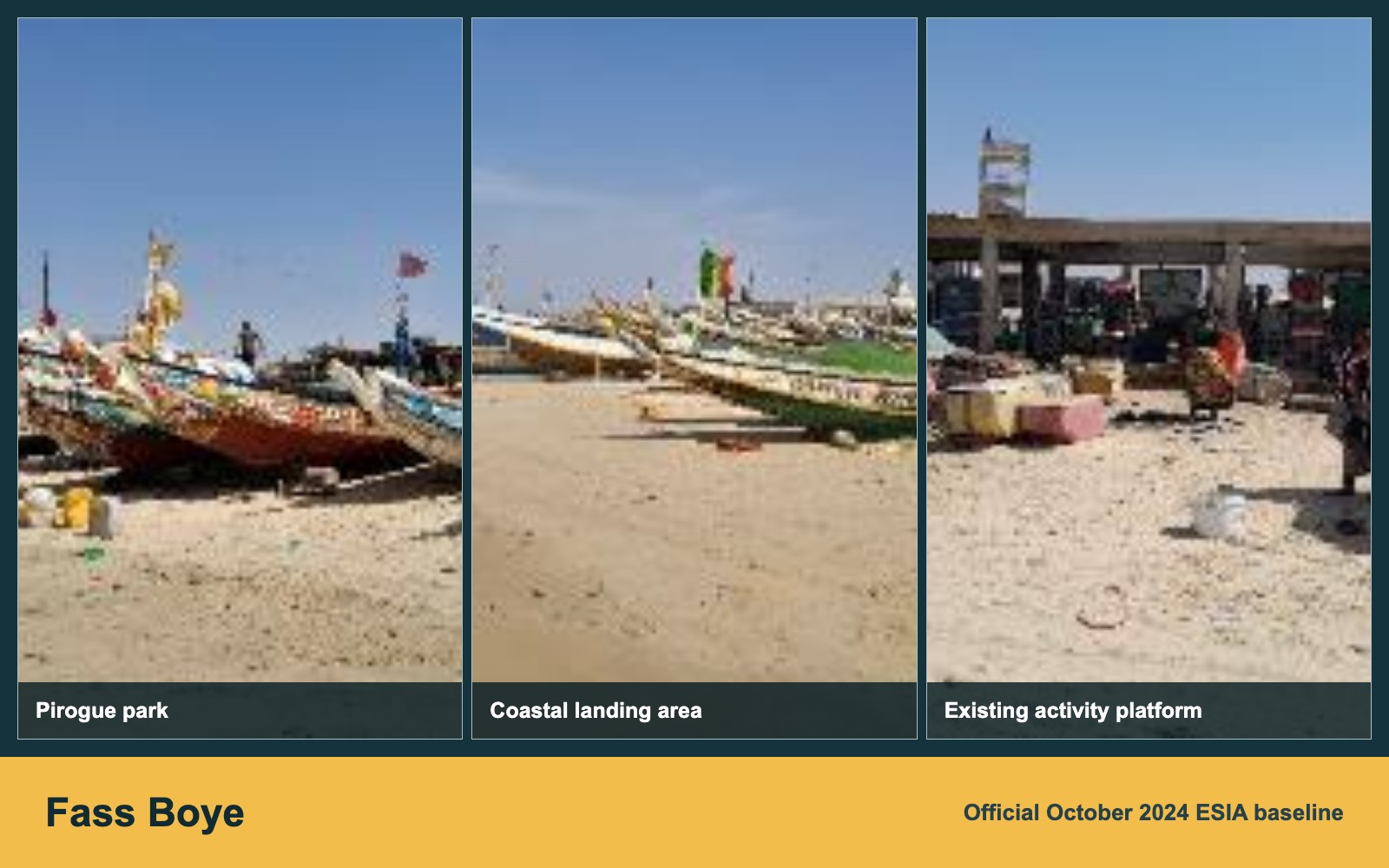

Official Fass Boye ESIA baseline photographs showing the pirogue park, fish landing area and existing activity platform

SENRM; composite from exact Fass Boye October 2024 ESIA site photographs, preparatory baseline only and not evidence of construction progress

KELIMANE ENTREPRISE signed the Fass Boye Lot 01 contract under P175915 on 5 February 2025, with a USD 1,938,458.02 supplier commitment. The final resettlement plan and environmental assessment describe a modern fishing quay, local and export markets, laboratory, cold room, ice production and support facilities on a 1.21-hectare occupied site. They also make relocation and compensation a precondition to works. A separate replacement relocation-site package remains awaiting execution; no controlled source confirms main-works mobilisation or physical progress through 8 August 2026.

Project signal

Award in Senegal

Current status KELIMANE ENTREPRISE's Lot 01 contract was signed 5 February 2025, while a separate replacement relocation-site package remained awaiting execution in the current plan; no controlled main-works start evidence through 8 August 2026 Source confidence Confirmed

Location

Senegal / Africa

Segment

Fish landing quay and fisheries value-chain infrastructure

Status

KELIMANE ENTREPRISE's Lot 01 contract was signed 5 February 2025, while a separate replacement relocation-site package remained awaiting execution in the current plan; no controlled main-works start evidence through 8 August 2026 / Confirmed

Last checked

8 August 2026

Coverage

Related sectors

Fish landing quay and fisheries value-chain infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Senegal Ministry of Fisheries and Maritime and Port Infrastructure through the SENRM project implementation structure, World Bank project P175915
Delivery parties
KELIMANE ENTREPRISE - supplier name in the World Bank award dataset for Lot 01; exact legal identity, consortium structure and lower tiers not disclosed, Relocation-site contractor for DC_T-SITES-DEPLACES-QUAIS_SENRM/MPEM/25 - not identified in the reviewed plan, Designer, supervision consultant, marine subcontractors, cold-chain, ice-plant, laboratory and wastewater suppliers - not identified
Contract route
Lot 01 used a post-review request for bids under package AON-T-SENRM-MPEM/03. Contract record 1855362 identifies KELIMANE ENTREPRISE and the 5 February 2025 signing. The current plan lists separate direct-contracting package DC_T-SITES-DEPLACES-QUAIS_SENRM/MPEM/25 as awaiting execution.
Execution window
KELIMANE ENTREPRISE signed on 5 February 2025. The November 2024 RAP requires resettlement and compensation before works, and the replacement relocation-site package remained awaiting execution in the current plan. No main-site handover, notice to proceed, mobilisation, physical progress or revised completion date has been confirmed.
Works package
Develop a modern fishing quay with local and export market compartments, fish reception and weighing, treatment and sales rooms, washing and storage, changing and sanitation facilities, loading and unloading areas, shared laboratory, cold room, ice factory, administration, engine repair, approximately 60 motor shelters, clinic, childcare, prayer and rest space, borehole, reservoir and site services. The RAP identifies a 1.21-hectare occupied project site and a separate 1.25-hectare relocation site.
Marine interfaces
Construction must preserve safe pirogue access and fish-trading continuity while managing an occupied shore platform, coastal exposure, drainage, wastewater discharge, waste handling and relocation of mainly women-led processing groups. The ESIA and RAP define these interfaces but do not establish completed enabling works or accepted construction.
Commercial evidence boundary
The main Lot 01 supplier commitment is USD 1,938,458.02. The separate relocation package is estimated at USD 318,150 in the current procurement plan and covers displaced-site enabling scope rather than the quay main contract. No variation, payment, measured-quantity or final-account evidence has been published.

Contract and delivery chain

Named roles and open packages

Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.

Main works award

AON-T-SENRM-MPEM/03 Lot 01 - Fass Boye modern fishing quay

Named party
KELIMANE ENTREPRISE
Status
Confirmed
Source position
World Bank contract award 1855362 records a USD 1,938,458.02 supplier commitment and 5 February 2025 signing. Source
Relocation enabling works

DC_T-SITES-DEPLACES-QUAIS_SENRM/MPEM/25

Named party
Contractor not identified
Status
Confirmed
Source position
The current procurement plan records the replacement USD 318,150 package as awaiting execution; it is separate from the quay main contract. Source
Resettlement prerequisite

Compensation and relocation before works

Named party
SENRM
Status
Confirmed
Source position
The final November 2024 RAP requires resettlement and compensation to be completed before main works proceed. Source
Main-works delivery

Mobilisation, physical progress and acceptance

Named party
No controlled milestone published
Status
Not evidenced
Source position
No controlled source located through 8 August 2026 proves site possession, main-works start, measured progress or completion.

Evidence gap

What remains unverified

Outstanding evidence

  • Relocation-site package award, execution and physical completion
  • Compensation close-out and documented site possession
  • Notice to proceed, baseline programme and contractor mobilisation
  • Quay, landing apron, drainage and coastal-interface construction
  • Cold room, ice factory, laboratory and fish-handling suppliers
  • Borehole, reservoir, wastewater and waste-management systems
  • Designer, supervision consultant, subcontractors and lower tiers
  • Testing, acceptance, operating handover and final account

Reporting status

Award, confirmed confidence

Last checked 8 August 2026 across 7 cited sources. The dated timeline above carries the project events.

Last checked 8 August 2026 Cited sources 7
