From dredging award to usable port capacity

Published 15 July 2026 Editorial responsibility IMWO Section Analysis

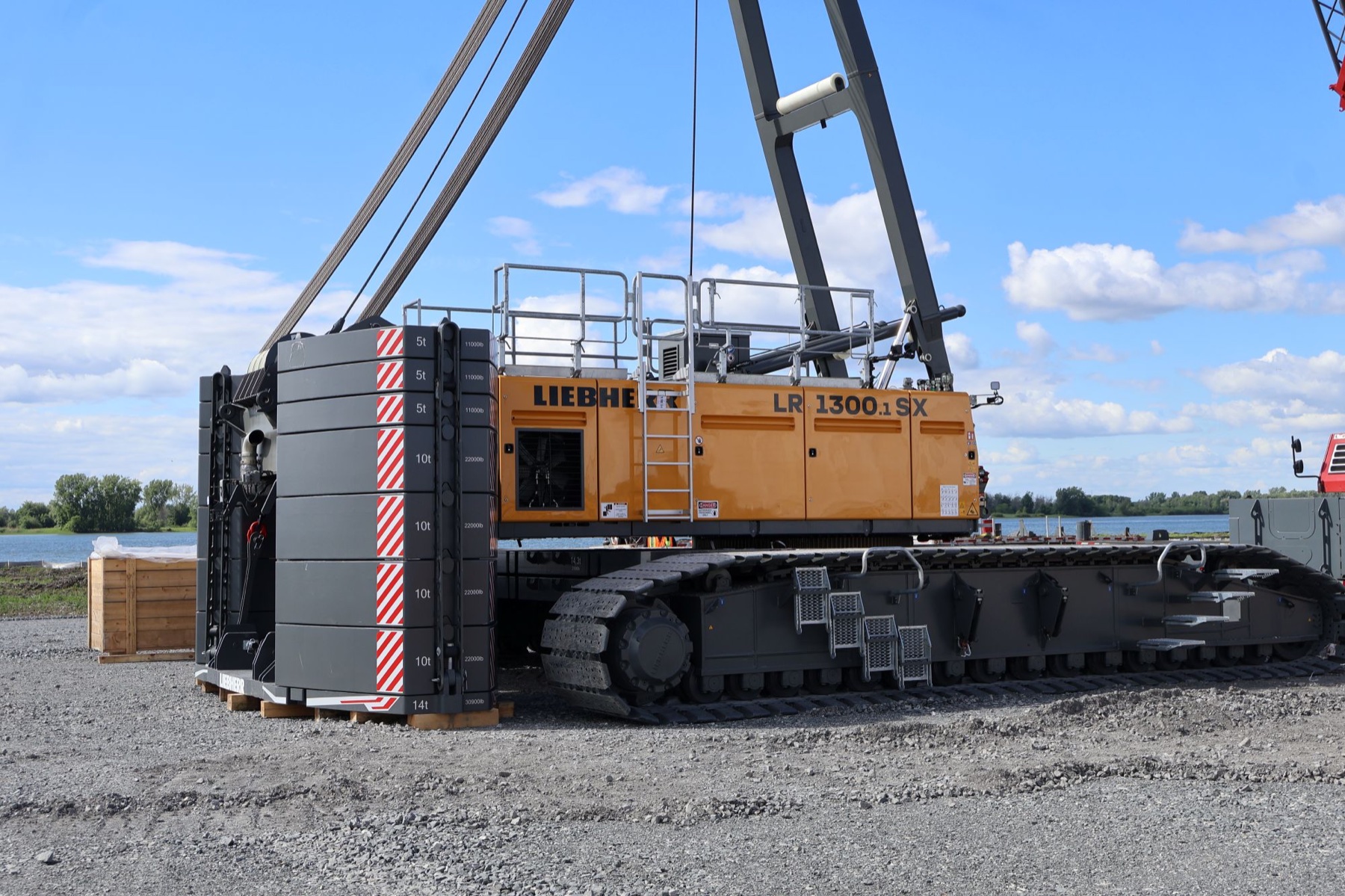

A 300-tonne crawler crane assembled beside the St. Lawrence River at the future Contrecoeur container terminal site

Montreal Port Authority, June 2026

A signed contract, marine plant on site, dredged volume, a completed quay and commercial vessel access mark different points in a port programme. Six current cases trace the remaining work between a package award and capacity an operator can actually use.

One update can close one part of the chain

Marine project announcements often use one visible event to stand in for the whole delivery chain. A contract is called a project start, equipment arrival becomes mobilisation, dredging becomes deeper access, and a finished quay becomes terminal capacity. Each event can be genuine while the operating conclusion remains premature.

Usable capacity appears only when each milestone is read at its own level. A signed package creates commercial authority to perform a defined scope. Plant mobilisation opens a workfront. Production and survey records can release a dredged area. Quay, fairway, navigation-system, environmental, terminal and harbourmaster acceptance cover different parts of the operating system. Only their controlled integration can support a usable-capacity claim.

Acceptance method

From package award to operating release

Usable capacity appears only when the awarded scope, as-built geometry, material route, accepted marine asset and operating release align.

  1. 01

    Map every delivery boundary

    Separate the overall programme, each employer, each contract package, port-side and fairway responsibility, terminal work, and any later operating or concession agreement before interpreting an award.

    Awarded scope is separated from the rest of the programme.
  2. 02

    Freeze geometry and survey control

    Record the design surface, horizontal limits, chart datum, baseline bathymetry, tolerances, overdepth rules, berth pockets, turning areas, and the authority that accepts the final survey.

    Completion is measured against accepted geometry.
  3. 03

    Reconcile material through destination

    Track material classes, in-situ and paid quantities, treatment, rehandling, reclamation, beneficial use, offshore or confined placement, environmental monitoring, and destination acceptance without merging unlike volumes.

    Cut volume reconciles with treatment and accepted destination.
  4. 04

    Prove the as-built marine asset

    Require completion records for dredged reaches, quay and berth structures, containment, reclamation formation, foundations, fenders, bollards, scour protection, utilities, and defects before calling the physical package complete.

    Physical package is accepted before capacity is claimed.
  5. 05

    Close nautical and terminal interfaces

    Connect accepted civil works to navigation aids, charts, under-keel-clearance policy, pilotage, towage, VTS, terminal equipment, power, systems, emergency response, permits, and trained operating teams.

    Civil, nautical and terminal systems serve the same vessel envelope.
  6. 06

    Require an operating release

    Look for the responsible authority's navigation or berth release, successful trial calls, owner acceptance, first commercial service, repeat operation, and performance against the capacity claim over time.

    Responsible authority releases constructed capacity into use.

Six-project acceptance map

Public milestones close different gates

The six programmes separate award, mobilisation, physical acceptance and operating release in different ways.

United States Confirmed

Sabine-Neches Waterway Channel Improvement Project

Current evidence gate
44-foot package awarded
What is controlled now
A defined inland dredging and anchorage package advances usable draft to 44 feet inside a wider 48-foot inland and 50-foot offshore programme.
Next capacity proof
Accepted 44-foot geometry and operating release, followed by awards, surveys, and acceptance for the remaining full-depth inland contracts.
Netherlands Confirmed

Port of Rotterdam Yangtzekanaal widening and quay programme

Current evidence gate
Phase B quay construction
What is controlled now
The completed tug quay and active inland-shipping quay create staged passing and berth capacity while post-2028 channel widening and deepening remains separate.
Next capacity proof
Phase B quay and operating acceptance, then a Phase C award, as-built channel survey, navigation controls, and authority release for the future vessel envelope.
Sweden Confirmed

Skandia Gateway fairway and quay deepening

Current evidence gate
Quay active, port dredging awarded
What is controlled now
Quay reinforcement and port-side blasting and dredging are progressing ahead of the separately controlled national fairway and navigational-marking sequence.
Next capacity proof
Accepted quay and port reach, national fairway execution and hydrography, commissioned navigation aids, and one operating release for the deeper vessel envelope.
Senegal Confirmed

Port of Ndayane Deep-water Port and Container Terminal

Current evidence gate
Marine package in construction
What is controlled now
A five-kilometre channel, roughly 10 million cubic metres of mixed-material dredging, and an 89-hectare reclamation platform feed the quay and terminal programme.
Next capacity proof
Accepted channel and reclamation, completed quay and terminal systems, harbour-service readiness, trial calls, and repeat commercial operation against the published capacity target.
Canada Confirmed

Port of Montreal Contrecœur Container Terminal

Current evidence gate
Wharf-readiness formation
What is controlled now
The crawler crane is assembled and sheet piles are stored on site before the owner's August 2026 wharf start and fall 2027 dredging sequence.
Next capacity proof
Installed and accepted quay works, later dredging mobilisation and hydrography, terminal commissioning, final operating arrangements, and an owner-confirmed 2030 opening.
Tunisia Confirmed

Tunisia three-port access and dredged-material programme

Current evidence gate
Contract and controls forming
What is controlled now
One dredging award covers three port areas with containment first and distinct reclamation, onshore pumping, and offshore-disposal routes under separate supervision controls.
Next capacity proof
Accepted containment, mobilisation, port-specific production and material balances, environmental records, final surveys, defects closure, and authority release at each location.

Package boundaries decide what an award can prove

Sabine-Neches makes the boundary visible. The April 2026 Callan package is a USD 239 million step toward a 44-foot usable draft, while the authorised programme extends to a 48-foot inland channel and 50-foot offshore reach. Later contracts remain in the full-depth sequence. Treating the Callan award as the complete deepening would erase both the remaining physical scope and the public-federal delivery split.

Rotterdam separates capacity by phase even more explicitly. The completed Phase A tug quay supports two-way traffic for vessels up to 18,000 TEU; Phase B adds inland-shipping quay capacity and targets two-way traffic for the current fleet up to 24,000 TEU; Phase C, after 2028, carries the widening and deepening needed for the stated future-vessel objective. One programme name therefore contains three different civil and nautical releases.

Production is incomplete without material and survey control

A dredged quantity has limited decision value unless the record also identifies the design surface, survey datum, tolerances, material classes, authorised placement routes, environmental windows, rehandling, and acceptance method. Tunisia's three-port contract demonstrates the material problem: Sousse and Menzel-Bourguiba use reclamation, Bizerte combines reclamation and offshore disposal, and Rades-La Goulette sends material ashore. The containment works and the separate monitoring and technical-assistance assignment are part of the delivery system, not background detail.

Ndayane combines a five-kilometre access channel, about 10 million cubic metres of dredging, hard material, Atlantic exposure, and reuse for an 89-hectare reclamation platform. Those published quantities establish a substantial marine package. They do not by themselves establish final channel geometry, accepted reclamation formation, quay readiness, terminal commissioning, or an open commercial service.

Quay and fairway work must meet at one operating interface

Skandia Gateway has an active quay-reinforcement package, an awarded port-side blasting and dredging package, and a separately controlled national-fairway programme. The port-side contract cannot release the nearly five-kilometre fairway, and the fairway cannot create usable deeper access if the quay, turning area, navigation aids, terminal controls, and operating procedures are not ready for the same vessel envelope.

This interface is where schedule headlines become operational questions. The controlling records should reconcile horizontal geometry, chart datum, berth-pocket depth, under-keel-clearance rules, turning and passing conditions, quay structural capacity, fenders and bollards, navigation aids, pilotage, towage, traffic restrictions, and the authority that issues the final navigation or berth release.

Visible readiness should not be promoted into physical progress

Contrecoeur now has a 300-tonne crawler crane assembled for pile and sheet-pile installation and sheet piles delivered to storage on 13-15 July 2026. The owner's current sequence places wharf construction from August 2026, dredging from fall 2027, and completion and opening in 2030. The equipment and deliveries are real readiness evidence, but they are not proof of installed piles, completed quay wall, dredger mobilisation, accepted depth, or terminal opening.

For suppliers, assembled equipment signals that a workfront is forming; for lenders, operators and cargo owners, it does not show handover. Keeping those two readings separate also prevents later updates from having to reverse an inflated completion claim.

The last unresolved interface controls usable capacity

Near-term scope and cash flow depend on the unresolved event: a survey baseline, containment completion, seasonal work window, national-fairway award, quay handover, navigation-aid commissioning, harbourmaster notice, or first repeat commercial service.

Without that event, the status can identify only the scope already released and the evidence still missing. This is more precise than a generic progress percentage and makes unlike projects comparable without flattening their contract and acceptance structures.

Knowledge context

Related knowledge topics

Continue through the topic collections to compare this record with related projects, evidence guides, briefs, articles, reports, and performance records.
