Veseli nad Moravou marina phase-one expansion

Participation
Not assessed
Project facts checked

The Czech Waterways Directorate opened 30 new public berths in August 2025 and the Transport Ministry reports the expanded marina operating with capacity for 66 boats in the 2026 season; IDS holds the phase-one works contract, with the highest reviewed official modification snapshot at CZK 86,312,219.98

Project sources

The Czech Waterways Directorate expanded the public recreational marina at Veseli nad Moravou as phase one of the wider Veseli-Vnorovy navigation-loop programme. IDS - Inzenyrske a dopravni stavby Olomouc delivered fixed quay edges, floating fingers, bank works, access, power, water, sewerage, lighting and navigation systems designed by AQUATIS. Thirty berths entered public use in August 2025, with finishing works continuing; the Transport Ministry records 66 operational spaces for the 2026 season. The original award to IDS was CZK 78,399,979.53 excluding VAT, while the highest reviewed TED modification snapshot reports CZK 86,312,219.98.

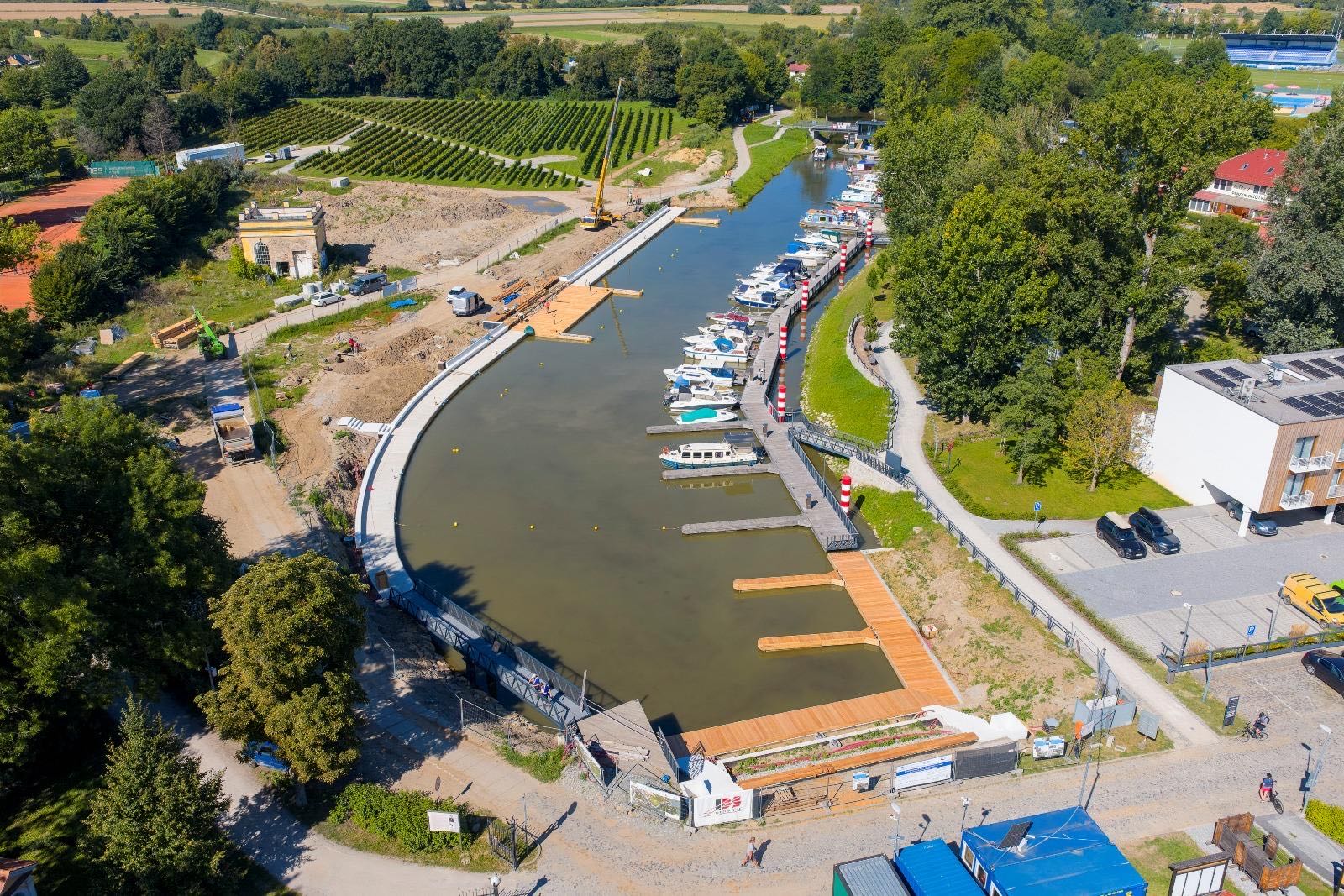

Official aerial view of the expanded Veseli nad Moravou marina, an inland waterway facility on the Bata Canal, showing the curved fixed quay edge, floating fingers, access bridge and operating harbour

Reditelstvi vodnich cest CR; official project photograph

Location

Czechia / Europe

Segment

Inland marina quay edges, floating fingers, bank protection and utilities

Phase

Completed / Confirmed

Last checked

12 August 2026

Coverage

Related sectors

Inland marina quay edges, floating fingers, bank protection and utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Reditelstvi vodnich cest CR (Czech Waterways Directorate)
Delivery parties
IDS - Inzenyrske a dopravni stavby Olomouc a.s. - confirmed phase-one works contractor under SML_2024_123, AQUATIS a.s. - confirmed designer named by the owner, Floating-finger, sheet-pile, electrical, water, sewerage, lighting, camera, landscaping and other lower-tier parties - not publicly identified
Contract route
The Czech Waterways Directorate tendered the first marina-expansion phase as harbour construction works. IDS signed SML_2024_123 on 18 February 2025 after an original procurement estimate of CZK 70,400,000 excluding VAT. TED fixes the award at CZK 78,399,979.53. A sequence of published contract-modification notices then documents additions and omissions without changing the named prime contractor.
Execution window
The owner records physical implementation from 25 February 2025 to 30 April 2026. It opened 30 new berths to the public on 18 August 2025 while finishing work, including power and water service columns, continued. On 1 May 2026 the Transport Ministry reported the expanded marina operating with capacity for 66 boats. This operating statement is stronger completion evidence than the owner project page, which still carries an outdated in-progress label and zero-percent indicator.
Works package
The first phase provides 31 designed berths: 29 for craft up to 8 m, one up to 10 m and one up to 20 m. Works include fixed quay edges of 17.7 m, 17.5 m, 53.4 m and 54.5 m; sixteen floating fingers; a 21.6 m by 9.8 m rest platform; a 31.5 m connecting walkway and steel footbridge; bank works; seven service pedestals, four with drinking-water connections; power, lighting, CCTV, navigation marking, marina information, water and sewer connections, landscaping and accessible routes.
Marine interfaces
Delivery combined sheet-pile and reinforced-concrete edge construction with floating berths in an operating inland marina. Published modifications expose recurring brownfield risks: buried concrete from a former weir, timber piles, an old wall footing, weak and poorly reinforced existing viewing-platform walls, unsuitable soil and unexpected sediment, soft founding layers, a deformed DN 400 connection and an erosion-prone exposed bank. Responses included demolition, pile removal, a new anchored concrete footing, imported compactable stone, lawful disposal, pipe replacement and 200-500 kg quarry-rock protection.
Commercial evidence boundary
The original IDS award was CZK 78,399,979.53 excluding VAT against a CZK 70,400,000 estimate. The highest reviewed modification snapshot reports CZK 86,312,219.98, an increase of CZK 7,912,240.45 or about 10.1% over the award. The same-day TED notices are separate snapshots after individual changes, not a reliable chronological ledger and not values to add together. The notices include both additions and omissions, but no final paid value, settled final account or lower-tier values are public.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Phase-one works contract

SML_2024_123 marina expansion

Named party
IDS - Inzenyrske a dopravni stavby Olomouc a.s.
Evidence status
Confirmed
Source position
TED records the 18 February 2025 contract, the IDS award at CZK 78,399,979.53 and a latest reviewed cumulative modified value of CZK 86,312,219.98. Source
Design and physical scope

Quay edges, fingers, access and marina systems

Named party
AQUATIS a.s.; Czech Waterways Directorate
Evidence status
Confirmed
Source position
The owner names AQUATIS and publishes the 31-berth layout, fixed-edge lengths, floating fingers, platform, walkway, service pedestals and utility systems. Source
Operational opening

Expanded public marina

Named party
Czech Waterways Directorate / Czech Transport Ministry
Evidence status
Confirmed
Source position
The owner opened 30 berths in August 2025 and the ministry reported 66 operating spaces for the May 2026 navigation season. Source
Brownfield and bank-risk changes

Buried structures, foundations, soil, sediment, pipe and rock protection

Named party
IDS under owner-approved modifications
Evidence status
Confirmed
Source position
The August 2026 TED modification series describes the discovered former-weir concrete and timber piles, weak platform walls, unsuitable soil, sediment, soft founding layers, deformed pipe and exposed-bank protection response. Source
Downstream delivery chain and closeout

Suppliers, subcontractors, final account and acceptance

Named party
Not publicly identified
Evidence status
Not evidenced
Source position
The cited public record does not name lower-tier parties or publish a completion certificate, final paid value or settled final account.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Modification series exposes the phase-one risk and cost chain

The notices document brownfield demolition, foundation, soil, sediment, drainage and bank-protection changes; the highest official modification snapshot reviewed is CZK 86,312,219.98.

Source

Transport Ministry confirms the expanded marina in operation

The ministry reports the expanded Veseli marina serving the 2026 navigation season with capacity for 66 boats, stronger evidence than the stale owner progress display.

Source

Thirty new berths opened during the navigation season

The owner put 30 new spaces into public use during the navigation season while utility-pedestal and other finishing work remained in progress.

Source

IDS receives the phase-one works contract

The award fixes IDS as prime contractor under SML_2024_123 at CZK 78,399,979.53 excluding VAT, establishing the commercial baseline for later modifications.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Final SML_2024_123 account, paid value and completion certificate
  • Phase-two procurement, scope, contractor and delivery date
  • Wider Veseli-Vnorovy navigation-loop permitting and ship-lift package
  • Operating capacity reconciliation between 30 opened, 31 designed, 66 current and 80 or 81 future spaces
  • Settlement and durability of replaced weak founding layers
  • Performance of quarry-rock bank protection and sediment controls
  • Condition of reused structures, anchored viewing-platform footing and DN 400 connection
  • Named sheet-pile, floating-finger, concrete, utilities and electrical lower tiers

Reporting status

Project phase
Completed
Evidence confidence
Confirmed
Last checked
12 August 2026
