Mali's Landscape Restoration Project is clearing and dredging the Niger River access route to Mopti's boat quay under a World Bank-financed works contract with Entreprise Danaya SARL. The tender baseline requires a route at least 40 metres wide and 2.2 kilometres long, clearance of seven named islands or sand bars, pre- and post-work bathymetry and associated enabling works. The USD 3,277,976.49 contract was signed on 7 November 2024, officially launched on 13 February 2025 and inspected for progress on 6 March 2025. A separate USD 256,342.26 supervision contract is held by SERTAS SARL. No official completion or acceptance record was located through 5 August 2026.
Project signal
Construction in Mali
Current statusThe package was officially launched on 13 February 2025 and a project team inspected progress on 6 March 2025; the latest disclosed procurement plan, dated 13 April 2026, still records the contract only as signed, and no official completion, accepted bathymetry or operating release has been publishedSource confidenceConfirmed
Location
Mali / Africa
Segment
Inland river-port access dredging and sediment clearance
Status
The package was officially launched on 13 February 2025 and a project team inspected progress on 6 March 2025; the latest disclosed procurement plan, dated 13 April 2026, still records the contract only as signed, and no official completion, accepted bathymetry or operating release has been published / Confirmed
Last checked
5 August 2026
Coverage
Related sectors
Inland river-port access dredging and sediment clearance is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Mali Landscape Restoration Project (PRTD-Mali), Ministry of Environment, Sanitation and Sustainable Development, financed by the International Development Association
Delivery parties
Entreprise Danaya SARL - main works contractor for dredging and sediment clearance, Societe d'Etudes, Recherches et de Technologies Adaptee pour le Sahel (SERTAS SARL) - control and supervision consultant, Dredging plant, survey, transport, sediment-management and other lower-tier suppliers - no public supplier names disclosed
Contract route
PRTD-Mali procured one works lot under reference ML-UGP-PRTD-408165-CW-RFQ and a separate quality-based consulting assignment under reference ML-UGP-PRTD-408160-CS-QBS. World Bank contract records show Danaya's works agreement signed on 7 November 2024 for USD 3,277,976.49 and SERTAS's supervision agreement signed on 6 September 2024 for USD 256,342.26. The latest procurement plan keeps the works package at 'Signed' and does not provide an actual completion or accepted final amount.
Execution window
The tender allowed six months from notice to proceed. A 29 November 2024 framing meeting said work orders were set for 16 December 2024 and effective start was planned for 1 January 2025. The owner officially launched the Mopti works on 13 February 2025 and documented a progress inspection on 6 March 2025. The procurement plan displayed a planned completion date of 20 April 2025, but no official completion, provisional acceptance or navigation reopening evidence was located as of 5 August 2026.
Works package
The single works lot covers dredging and sediment clearance along the access route to the Mopti boat quay. The tender requires a navigable corridor at least 40 metres wide over 2.2 kilometres, clearance of islands or sand bars numbered 1 through 7, pre- and post-work bathymetric surveys, execution studies, mobilisation and demobilisation, temporary access or diversions and clearance of kiosks and vendors from the work area. PRTD-Mali later described the launched dredging reach as nearly 3 kilometres; that rounded programme narrative does not replace the contract baseline.
Marine interfaces
The works sit inside a live inland-waterway transport system used by boats and pinasses at Mopti. Delivery therefore depends on survey control, dredging plant access, vessel traffic management, temporary shoreline access, quay-side public interfaces, sediment handling and the post-dredge evidence needed to release a usable navigation route. The related quay rehabilitation and dike-road packages are adjacent works, not part of Danaya's disclosed dredging contract value.
Commercial evidence boundary
The World Bank award record gives USD 3,277,976.49 as the committed works amount and USD 256,342.26 for supervision. The April 2026 procurement plan shows a USD 4,219,672 estimate for the works but leaves the actual amount field at zero; the award record therefore controls the disclosed signed value. The FCFA 4.56 billion announced at the February 2025 launch covers four Mopti work packages and must not be presented as the dredging contract value, paid amount or final account.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Latest disclosed procurement plan still records the works contract as signed
The plan carries a planned April 2025 completion date but supplies no completion, acceptance or actual-value evidence, leaving the closeout gate unresolved.

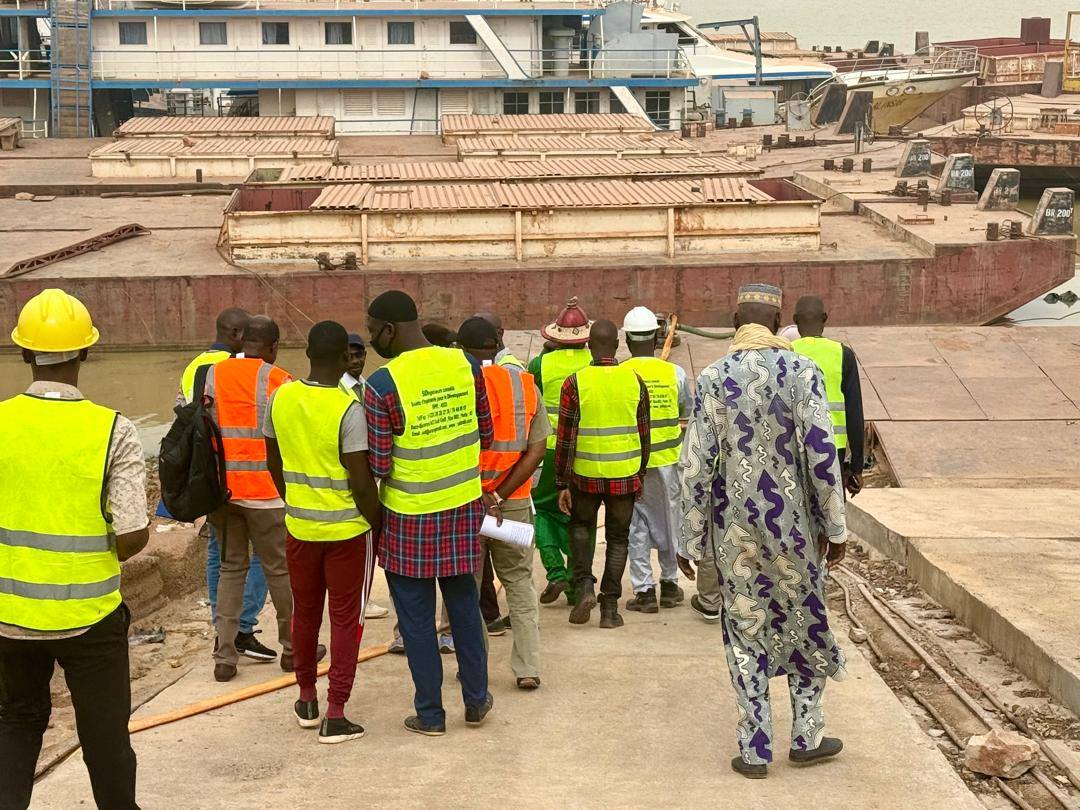

PRTD-Mali inspected field progress at the Mopti work sites
The project team documented a site visit covering the boat-quay works, providing physical-progress evidence but no measured production or acceptance result.
Government and PRTD-Mali officially launched the Mopti works
The launch covered four local packages and described nearly 3 kilometres of dredging intended to improve navigation and port activity; the combined programme value is not the dredging contract value.
Danaya signed the main dredging and clearance contract
World Bank contract data records Entreprise Danaya SARL, reference ML-UGP-PRTD-408165-CW-RFQ and a signed value of USD 3,277,976.49 for the works package.
