Project record

Barranquilla access-channel maintenance dredging

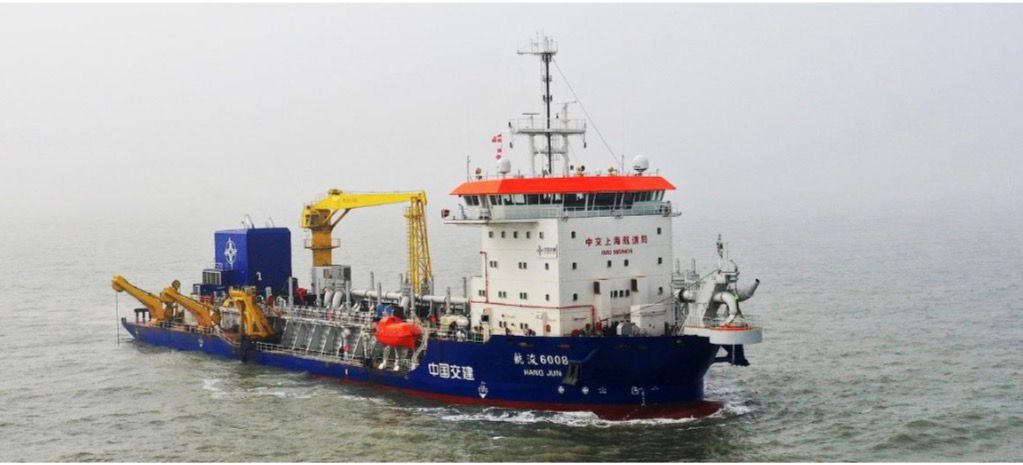

Hang Jun 6008 trailing suction hopper dredger mobilised for Barranquilla access channel maintenance dredging

Cormagdalena

Cormagdalena's Barranquilla access-channel maintenance contract moved from a COP 150.967 billion award to a COP 241.685 billion current contract ledger. SECOP II names the Consorcio Dragado Puerto de Bquilla 2024-2025 and records Caribbean Region Water Conservancy Engineering SAS at 70%, Panamerican Dredging at 20% and CFD Ingenieria SAS at 10%. Cormagdalena documented field execution aboard Xin Hai Ma in June 2025, mobilisation of Hang Jun 6008 in February 2026 and 80.7% execution at 31 March. The later SECOP modification extends the current end date to 31 December 2026; final quantities, acceptance and commercial close-out remain open.

Project signal

Delivery in Colombia

Current status SECOP II shows contract 0-525-2024 modified to COP 241.685 billion and 31 December 2026 after a 365-day extension; Cormagdalena reported 80.7% execution at 31 March before the later ledger update, while completion and acceptance remain unconfirmed Source confidence Confirmed

Location

Colombia / Americas

Segment

Navigation channel maintenance dredging

Status

SECOP II shows contract 0-525-2024 modified to COP 241.685 billion and 31 December 2026 after a 365-day extension; Cormagdalena reported 80.7% execution at 31 March before the later ledger update, while completion and acceptance remain unconfirmed / Confirmed

Last checked

6 August 2026

Coverage

Related sectors

Navigation channel maintenance dredging is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Cormagdalena
Delivery parties
Consorcio Dragado Puerto de Bquilla 2024-2025 - awarded contracting group under 0-525-2024, Caribbean Region Water Conservancy Engineering SAS - 70% consortium member and registered group leader, Panamerican Dredging - 20% consortium member, CFD Ingenieria SAS - 10% consortium member, Dredger owner, hydrographic, environmental, survey, support-vessel and other lower-tier assignments - not disclosed in the cited records
Contract route
Cormagdalena ran LP-008-2024 as a public-works tender. SECOP II records publication of the selection phase on 15 August 2024, one response from one unique provider and award on 18 September 2024 to Dragado Puerto de Bquilla 2024-2025 for COP 150.967 billion. Contract 0-525-2024 was signed on 15 October and started on 6 November 2024. The electronic contract ledger, last updated 11 May 2026, reports modified status, COP 241.685 billion current value, 365 added days and a 31 December 2026 current end date.
Execution window
The base procurement set a 16-month term. The contract began on 6 November 2024. Cormagdalena reported 13 channel interventions during 2025 by 13 June, mobilised Hang Jun 6008 to address accelerated K0-K1 sedimentation in February 2026 and reported 80.7% execution at 31 March. Owner articles then referred to a 31 July 2026 finish, but the later SECOP ledger supersedes that snapshot with a 31 December 2026 current end date. Substantial completion and final acceptance are absent from the cited sources.
Works package
Hydraulic maintenance dredging in the Magdalena River sector forming the navigation channel to the Port of Barranquilla, including the Bocas de Ceniza entrance. The operating programme includes repeated sediment removal, continuous channel monitoring, two-dimensional numerical modelling, river-bank analysis and thalweg tracking. Public sources do not publish a final contract-specific dredged volume, accepted channel survey, disposal ledger or final measured bill.
Marine interfaces
The work protects a reported stable 10-metre navigation draft across a high-sedimentation river-mouth channel. Cormagdalena identified accelerated deposition around K0-K1 and required a trailing suction hopper dredger with at least 6,000 cubic metres of hopper capacity. Hang Jun 6008 was reported at about 6,500 cubic metres. Dredger availability, hydrographic control, traffic coordination, channel markers and rapid response to changing river morphology govern continuity of port access.
Commercial evidence boundary
The procurement dataset records a COP 150.967 billion initial award. Cormagdalena's 9 April 2026 report described a then-current COP 198.564 billion contract at 80.7% execution as of 31 March. The later SECOP contract ledger reports COP 241.685 billion and a 365-day extension. These are dated contract states, not proof of overrun, final cost or payment. The public ledger does not disclose the priced variation schedule, member-level allocation, certified quantities, claims or final account.

Contract and delivery chain

Named roles and open packages

Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.

Prime contract and consortium

LP-008-2024 / contract 0-525-2024

Named party
Consorcio Dragado Puerto de Bquilla 2024-2025
Status
Confirmed
Source position
SECOP II records the selected group, signed contract, current modified value and term. Source
Consortium composition

Legal participation in group 728030099

Named party
Caribbean Region Water Conservancy Engineering SAS 70%; Panamerican Dredging 20%; CFD Ingenieria SAS 10%
Status
Confirmed
Source position
The SECOP II provider-groups dataset records all three members, percentages and the 70% member as group leader. Source
Field dredging

Maintenance interventions and vessel mobilisation

Named party
Contracting consortium; vessel operator not identified in the cited sources
Status
Confirmed
Source position
Cormagdalena documented Xin Hai Ma operations in June 2025 and Hang Jun 6008 mobilisation in February 2026. Source
Lower-tier supply chain

Dredger ownership and operation, survey, monitoring, environmental and support craft

Named party
Undisclosed subcontractors and suppliers
Status
Undisclosed
Source position
The cited official records identify the consortium and vessels but do not name lower tiers or allocate operating scope.
Completion and acceptance

Maintained channel and final measured account

Named party
Cormagdalena and the contracting consortium
Status
Not evidenced
Source position
Progress and a modified contract end are published; final surveys, accepted quantities, completion and close-out are not.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

SECOP ledger carries the modified contract to COP 241.685 billion and year-end

The current electronic contract record adds 365 days and moves the end date to 31 December 2026, superseding earlier owner snapshots for current contract state.

Source

Owner reported 80.7% execution at 31 March

Cormagdalena reported a then-current COP 198.564 billion value, 2026 dredging progress and continued 10-metre navigation draft; the article is a dated execution snapshot, not close-out.

Source

Hang Jun 6008 mobilised for the channel contract

The approximately 6,500-cubic-metre hopper dredger was mobilised in response to accelerated sedimentation around K0-K1 and planned to begin work on 10 February.

Source

Cormagdalena documented active Xin Hai Ma operations

The owner reported 13 channel interventions during 2025 by June and described continuous two-dimensional modelling, bank analysis and thalweg monitoring.

Source

Cormagdalena awarded maintenance contract LP-008-2024

SECOP II records a COP 150.967 billion initial award after one response from one unique provider, establishing the commercial baseline before later modifications.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Contract modification instruments supporting the COP 241.685 billion current ledger
  • Current dredger assignment, ownership and operating party
  • Baseline and completion hydrographic surveys with accepted 10-metre channel geometry
  • Contract-specific measured dredged volume and disposal route
  • Physical work allocation among the 70/20/10 consortium members
  • Named survey, environmental, support-vessel and dredging lower tiers
  • PAGA implementation and environmental close-out
  • Completion certificate, navigation release and final account

Reporting status

Delivery, confirmed confidence

Last checked 6 August 2026 across 7 cited sources. The dated timeline above carries the project events.

Last checked 6 August 2026 Cited sources 7

Sources and related records

Read featured analysis Methodology Submit a correction Project tracker

Project sources 7
