Regional intelligence

Europe marine construction intelligence

Deep-draft access, energy transition interfaces, port redevelopment, coastal adaptation, environmental compliance, and specialised delivery.

Projects, client activity, procurement and contractor appointments across Europe.

Latest item update 113 public projects 135 region-coded publications 75 active organizations
On this page

Current focus

Baltic industrial port deepening visible

Tracker coverage

113 project records connected to this region.

Publication coverage

135 current analyses and briefs coded to this region.

Organization coverage

75 public profiles identify active work or decision roles in this region.

Project coverage

All current Europe project records

113 records
Confirmed

Bridgwater Tidal Barrier and downstream flood defences

United Kingdom / Tidal surge barrier and downstream flood defences / Permanent reinforced-concrete foundations advancing; revised superstructure scheduled from early 2027

construction / Last checked
Confirmed

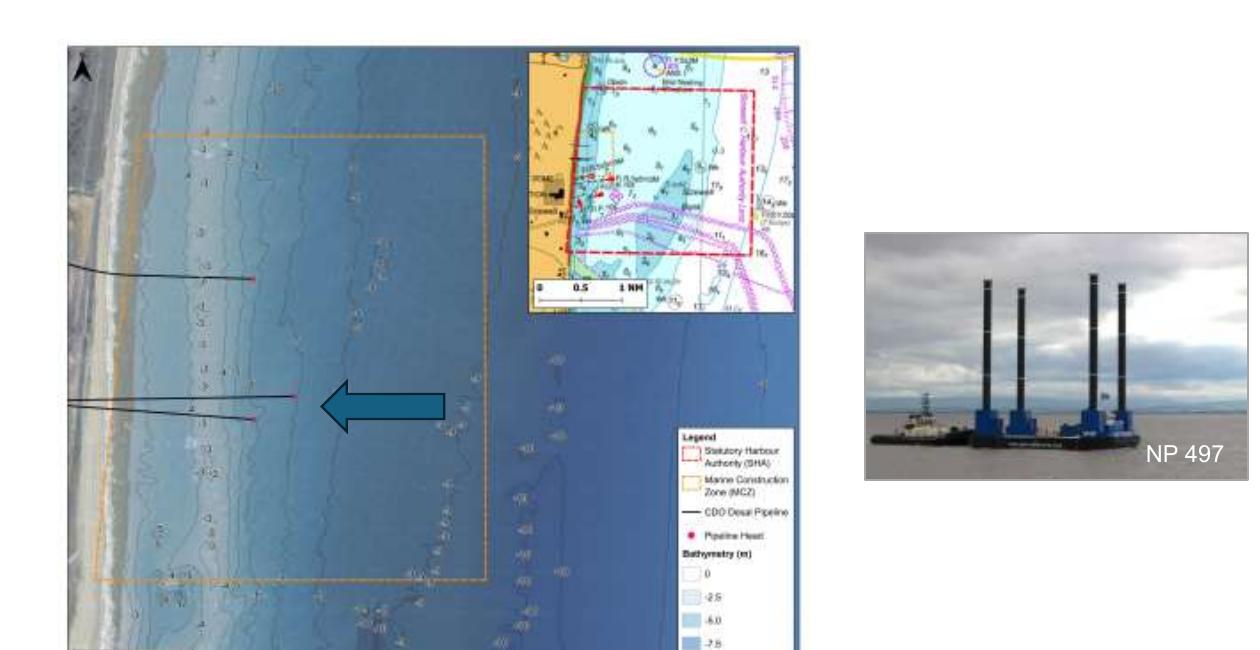

Sizewell C Marine Bulk Import Facility

United Kingdom / Bulk-import jetty, conveyor and berthing pocket / Owner reports offshore construction progress and expects bulk-import operation in Q2 2027

construction / Last checked
Confirmed

Barton to New Holland tidal flood-defence scheme

United Kingdom / Tidal embankment and outfall adaptation / Detailed design, land discussions and environmental assessment; Full Business Case targeted for summer 2027

planning / Last checked
Confirmed

Lymington Toll Bridge tidal-flap and sill renewal

United Kingdom / Tidal outfall and flood-gate renewal / September flap installation reported 7 October; separate regulating-float repair planned by yearend

construction / Last checked
Confirmed

Torcross rock-armour sea-defence renewal

United Kingdom / Rock-armour coastal defence / Construction reported begun 14 October 2026; rock-delivery and installation programme extends into 2027

construction / Last checked
Confirmed

Salcombe-Kingsbridge estuary 2026 maintenance dredging

United Kingdom / Maintenance dredging and operating-port access / The Harbour Master's 22 June 2026 report confirms Van Oord completed dredging at Batson, Lincombe and Kingsbridge, with pontoons reopened by April; published draft meeting minutes record subsequent receipt of the post-dredge survey

award / Last checked
Confirmed

Kishorn Phase 1B East Quay development

United Kingdom / Port infrastructure / Restricted selection and marine pre-application consultation for the proposed East Quay

prequalification / Last checked
Confirmed

Montrose Port Berths 9-11 redevelopment

United Kingdom / Port infrastructure / Initial selection closed 16 October; invitations expected 20 November 2026

prequalification / Last checked
Confirmed

Portsmouth Water service-reservoir maintenance framework

United Kingdom / Service-reservoir maintenance / Planning history checked 31 October 2026 still contains only the 13 October notice; its expected 30 October formal notice is absent from that history

planning / Last checked
Confirmed

Port Ellen ferry terminal marine redevelopment

United Kingdom / Marine infrastructure / Marine construction programme; owner 9 October steel-pile import and local-transfer plan, with actual receipts to confirm.

construction / Last checked
Confirmed

Mermaid Beach breakwater walkway-unit recovery and repair

United Kingdom / Coastal infrastructure / UK6 notice 097475-2026 names Chunnel Plant Hire and Contractors Limited for the six-unit repair at GBP 169,187.49 excluding VAT; signature is scheduled for 19 October 2026, with reinstatement and acceptance unconfirmed

award / Last checked
Confirmed

Fort George North Glacis sea-wall underpinning

United Kingdom / Coastal infrastructure / Recorded tender deadline passed on 4 November 2026 at 17:00 GMT; advertised duration 28 working days

tender / Last checked
Confirmed

Malaga Port Quay 4 facing rehabilitation

Spain / Submerged masonry quay repair and structural concrete rehabilitation / Malaga Port Authority declared Quay 4 procedure 26exma-033 unsuccessful on 7 September 2026 after receiving no bids; the 15 September notice retains the seven-zone repair design and EUR 78,739.06 excluding-VAT tender budget, with no works award under this procedure

tender / Last checked
Confirmed

Dunkirk port mechanical preventive-maintenance framework

France / Port structures and mechanical installations maintenance / BOAMP extended submissions to 28 September 2026; that date has passed and the latest buyer-profile result remains unverified

tender / Last checked
Confirmed

Dunkirk port cathodic-protection replacement framework

France / Port structures and underwater asset maintenance / The published 4 September 2026 bid deadline has passed; the latest buyer-profile result and framework holder remain unverified

tender / Last checked
Confirmed

Sidmouth and East Beach coastal defence scheme

United Kingdom / Two-stage coastal flood and erosion defence, beach recharge and offshore rock works / East Devon's 28 September UK7 notice records a Boskalis Westminster contract signed on 14 September 2026 at GBP 18,911,242.18 excluding VAT, with a 15 September 2026 to 29 March 2030 contract period; Stage 2 instruction and physical mobilisation remain unconfirmed

award / Last checked
Confirmed

Port of Aberdeen 2026-2028 maintenance dredging

United Kingdom / Maintenance dredging and operating-port access / Three-year Boskalis award covers annual 2026-2028 campaigns; dated navigation notices add operational evidence, with 2026 contractual acceptance unconfirmed in the appointment and navigation notices

award / Last checked
Confirmed

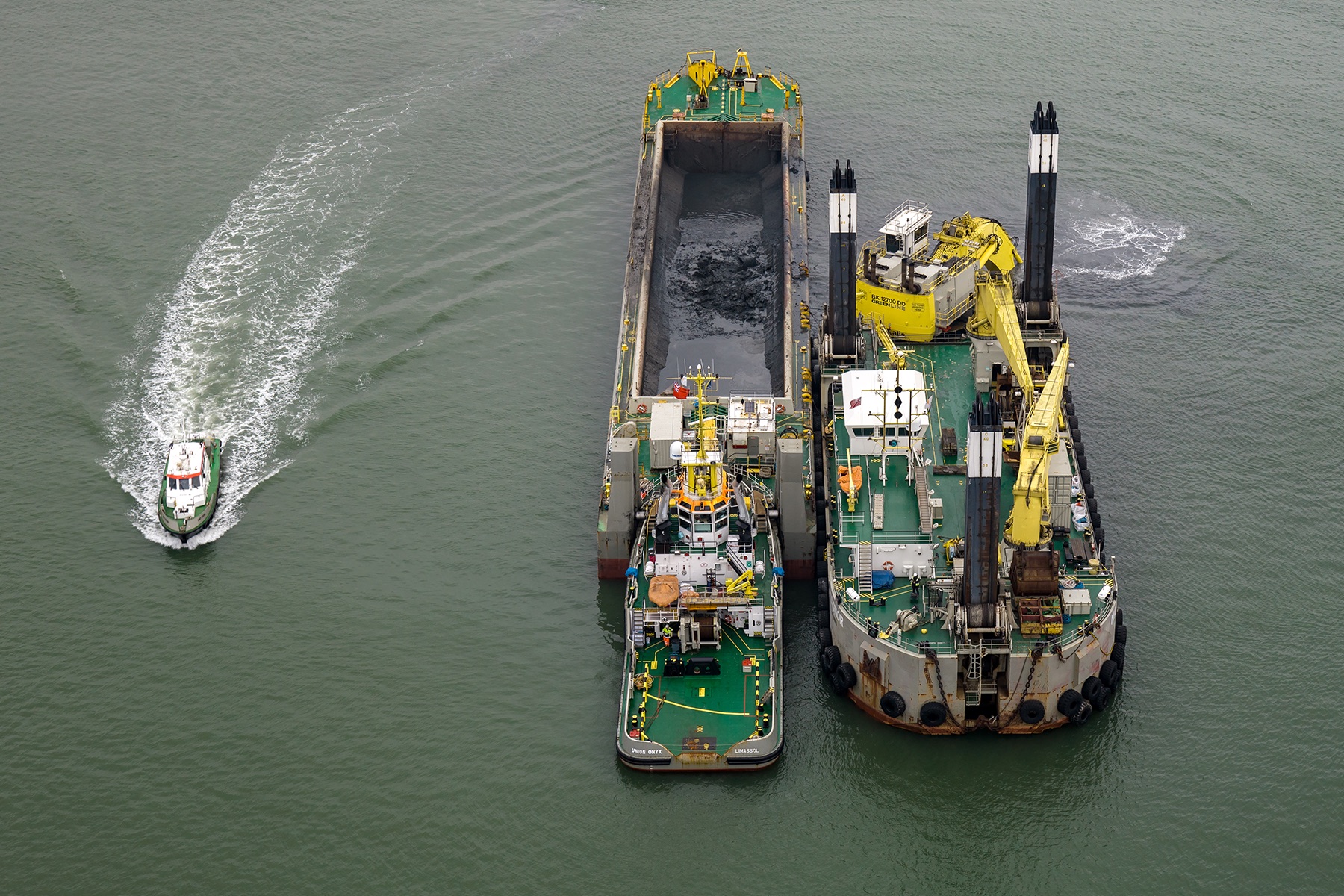

Southampton Channel Deepening capital dredge

United Kingdom / Dredging / ABP selected Boskalis Westminster on 11 August 2026; the UK6 award remains pending and signature is unconfirmed. MMO case MLA/2026/00178 shows Submitted / (In progress) / [On Hold], with no current consultation, as reviewed on 15 October

award / Last checked
Confirmed

Ardersier Port Phase 2 dredging procurement

United Kingdom / Port infrastructure / PQQ closed on 1 May 2026; subsequent invitation to tender and supplier appointment remain unconfirmed in the reviewed notice

prequalification / Last checked
Confirmed

Germany Beck flood-alleviation works procurement

United Kingdom / Inland flood-alleviation and pumping infrastructure / Procurement terminated on 30 September 2026 by notice 092372-2026; a replacement process and the wider scheme's future remain unconfirmed

tender / Last checked
Confirmed

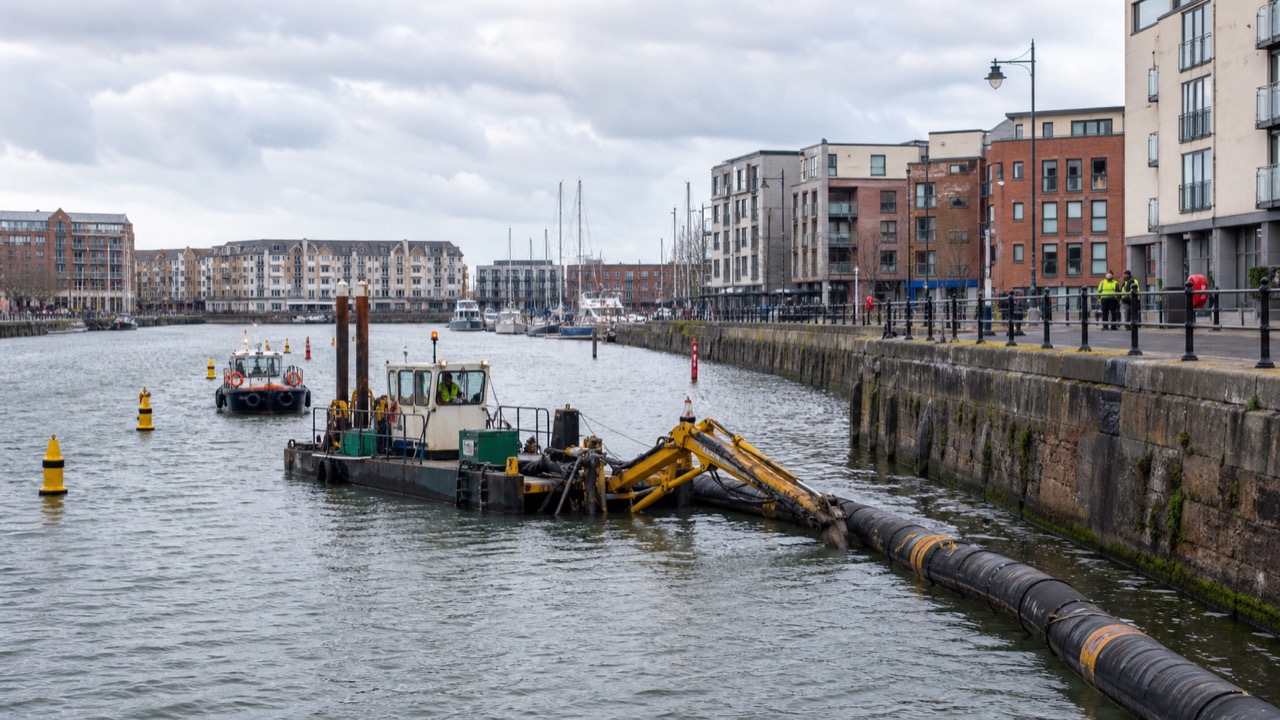

Bristol Floating Harbour 2026 maintenance dredging

United Kingdom / Maintenance dredging, floating-harbour navigation and marina access / Bullo holds the signed GBP 392,500 excluding-VAT contract; July and August navigation windows are historical, with the post-term instruction and accepted output unconfirmed

award / Last checked
Confirmed

Port of Felixstowe four ship-to-shore quay cranes

United Kingdom / Container-terminal handling equipment / Find a Tender records an active award to ZPMC for four STS cranes at GBP 43.594 million excluding VAT; actual contract signature, manufacture, shipment, commissioning and acceptance remain unconfirmed

award / Last checked
Confirmed

Burry Port pontoon floats

United Kingdom / Marinas, pontoons and berthing infrastructure / Solent Marine holds a GBP 72,600 float award.

award / Last checked
Confirmed

NOC Southampton quayside wall and pontoon repairs

United Kingdom / Seawall, quayside and pontoon repair / National Oceanography Centre signed Seawork Marine Services on 8 May 2025 for GBP 88,800 including VAT; the contract period ran from 13 August to 12 September 2025, but no dated completion, acceptance or final-account record has been located

award / Last checked
Confirmed

Swansea Morfa Quay and New Cut Road pontoons

United Kingdom / Marinas, pontoons and berthing infrastructure / Swansea signed the GBP 411,775.70 excluding-VAT two-pontoon contract on 15 July; the August amendment revised its start to 5 August, retaining a 2 October end, with site completion and acceptance unconfirmed

award / Last checked
Confirmed

Langstone Coastal Defence Scheme

United Kingdom / Continuous tidal flood and coastal erosion defence with early contractor involvement / Jackson is appointed; April 2027 main construction is planned, with the programme under refinement and signed terms and consent documents outstanding

award / Last checked
Confirmed

Burry Port Harbour emergency sand dredging

United Kingdom / Maintenance dredging, approach-channel access and beach placement / Carmarthenshire County Council signed a GBP 425,000 excluding VAT emergency dredging contract with Kaymac Marine & Civil Engineering on 29 June 2026 for a 13 July to 31 October delivery window; the council has published no mobilisation, dredger, production, survey, completion or acceptance update

award / Last checked
Confirmed

Harwich Haven five-year maintenance dredging

United Kingdom / Maintenance dredging, beneficial use and dredging technology / HHA confirmed Suffolk Dredging LLP's five-year maintenance award in July; the March procurement family was withdrawn for a scope-description correction, with current value and exact commencement unconfirmed

award / Last checked
Confirmed

Folkestone to Hythe beach management works 2025-2030

United Kingdom / Shingle recycling, beach regrading and coastal flood defence / Chunnel holds the signed beach-management contract; the March campaign and April order are historical programme evidence, with autumn activity and accepted output unconfirmed

delivery / Last checked
Confirmed

London Gateway C2526 maintenance dredging

United Kingdom / Maintenance dredging and operating-port access / Jan De Nul was selected at GBP 57 million excluding VAT under the 18 December 2025 decision; the UK6 award remains pending for signature and C2526 field execution is unconfirmed

award / Last checked
Confirmed

UK Navy Future Dredging Contract

United Kingdom / Dredging / Contract signed; individual campaign delivery and accepted depths remain unverified

award / Last checked
Confirmed

IJsselmeerdijk foreshore and conventional dike reinforcement

Netherlands / Coastal infrastructure / Owner reports realization has begun with the lake-side foreshore; conventional dike work planned from early 2027, quantities and acceptance unconfirmed

construction / Last checked
Confirmed

Sines quay and north-west breakwater design interface

Portugal / Ports and coastal protection / Design and environmental assessment; APS makes new-quay construction conditional on industrial demand and rules out a near-term works tender

design / Last checked
Confirmed

Anaklia marine infrastructure and terminal-delivery interface

Georgia / Capital dredging and navigation-channel deepening / Initial breakwater-channel dredging reported; main basin campaign and private terminal milestones follow separate delivery stages

construction / Last checked
Confirmed

Boskalis SEAWAY 31,000 m³ TSHD

Netherlands / Dredging / In service; first project off Den Helder reported

completed / Last checked
Confirmed

Igoumenitsa Port three-berth OPS shore-power systems

Greece / Commercial-port shore power and electrical utility integration / HEDNO signed the EUR 6.82 million turnkey contract with Paralos on 11 February 2026 for two 3 MVA OPS positions and one 0.5 MVA position. TED names Paralos Energy, Controls Vasiloglou and Siemens A.G. as subcontractors; mobilisation, installation, energisation, vessel connection and acceptance remain unconfirmed

award / Last checked
Confirmed

Molo Sali Phase B sheet-pile restoration and quay completion

Italy / Sheet-pile rehabilitation and port-yard conversion / TED notice 514687-2026 records a EUR 8,295,571.84 contract concluded on 23 July 2026 with the Rossi Renzo Costruzioni-led four-member RTI; notice to proceed, mobilisation, named subcontractors and installed work remain unverified

award / Last checked
Confirmed

Port 2000 Chatiere protected river access

France / Ports and coastal protection / Terelian and SDI/DEME are constructing the 1,800 metre protection dike; HAROPA reported nearly 800,000 m3 of foundation material placed by 1 June 2026 after a 760,000 m3 weak-silt purge, while channel dredging, dike tie-ins, completion and operating release remain pending

construction / Last checked
Confirmed

Veseli nad Moravou marina phase-one expansion

Czechia / Inland marina quay edges, floating fingers, bank protection and utilities / The Czech Waterways Directorate opened 30 new public berths in August 2025 and the Transport Ministry reports the expanded marina operating with capacity for 66 boats in the 2026 season; IDS holds the phase-one works contract, with the highest reviewed official modification snapshot at CZK 86,312,219.98

completed / Last checked
Confirmed

Torrent wastewater treatment plant adaptation

Spain / Urban wastewater treatment, tertiary reuse and flood resilience / CHJ currently lists the Torrent adaptation works in execution under the Global Omnium Medioambiente-CICLAGUA-BECSA UTE; its 2025 delivery report fixes the site-start baseline at 19 September 2023 and records separate certified amounts for modification 1 and the post-DANA emergency workfront, while PLACSP's 10 August 2026 modification record adds zero price and zero duration

construction / Last checked
Confirmed

Port of Rotterdam Yangtzekanaal widening and quay programme

Netherlands / Port infrastructure / Phase A tug quay delivered; the same consortium has started Phase B, including 1.4 million m3 of sand dredging; Phase C remains a post-2028 package

construction / Last checked
Confirmed

Cáceres El Marco wastewater treatment plant

Spain / Urban wastewater treatment, tertiary reuse and renewable-energy integration / ACUAES selected the Aquambiente-COPASA-PESA consortium on 30 July 2026 at EUR 61,784,295.49 excluding VAT; the award notice was published on 4 August, while contract signature, notice to proceed and mobilisation remain unconfirmed

award / Last checked
Confirmed

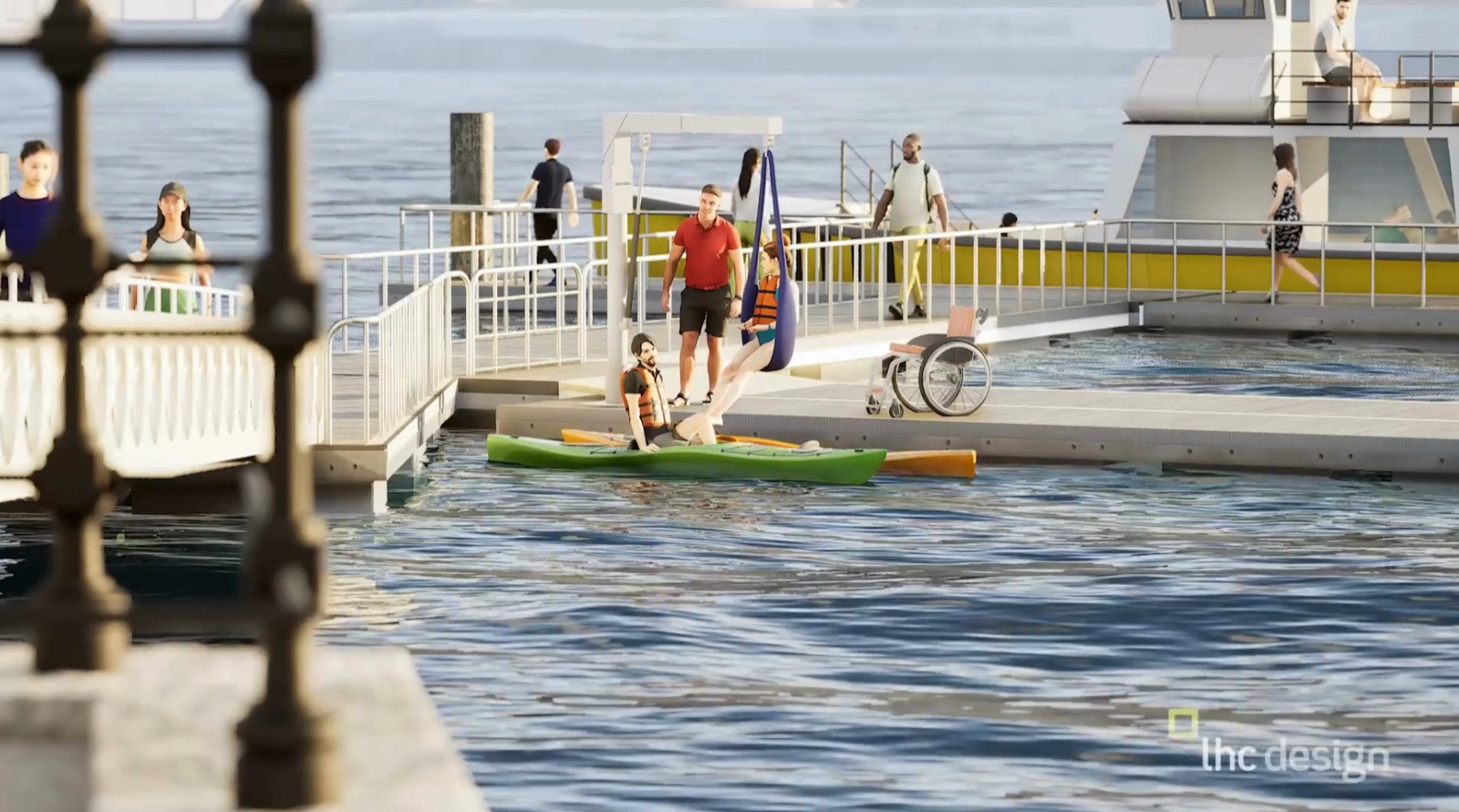

Plymouth Mount Batten pontoon replacement

United Kingdom / Marinas, pontoons and berthing infrastructure / Teignmouth Maritime Services holds the GBP 3.201 million excluding-VAT design-and-build contract; a weather-delayed temporary pontoon and bridge were commissioned on 17 March 2026, while permanent pontoon completion and owner handover remain unconfirmed

construction / Last checked
Confirmed

Ringvaart 2 dredging

Netherlands / Dredging / Award signed; start unverified.

award / Last checked
Confirmed

Tarifa fishing-wharf electrical utility upgrade

Spain / Fishing-wharf electrical distribution and utility connection / APBA awarded the EUR 273,030 works to VES Renewable; contract formalization and setting-out remain unpublished

award / Last checked
Confirmed

La Pozona harbour upgrade

Spain / Dredging, pontoons, piles and utilities / Cantabria awarded the EUR 2.647m works to a three-member UTE; contract and mobilisation remain unpublished

award / Last checked
Confirmed

Port-Vendres Quai Dezoums shore-power electrification

France / Commercial-port shore power and electrical utility integration / BOAMP notice 25-50611 records a EUR 5,436,212 contract issued on 3 April 2025 to the SPIE CityNetworks-led consortium with Nidec ASI and T.A.E.H., plus subcontractor Guintoli. A 24 March 2026 Department presentation classifies the work as in progress; energisation, vessel connection, commissioning, acceptance and completion remain unconfirmed

construction / Last checked
Confirmed

Maassluis M2 quay-wall replacement and waterfront renewal

Netherlands / Quay-wall replacement and waterfront public-realm renewal / TED notice 542353-2026 records a EUR 7,887,000 contract with De Vries Werkendam B.V. concluded on 4 August 2026; the owner plans physical works from 5 October 2026 to 21 July 2028 and publishes no current mobilisation evidence

award / Last checked
Confirmed

La Spezia Terminal del Golfo expansion and redevelopment Lot I

Italy / Container and multipurpose terminal quay extension / TED notice 521188-2026 records a 23 July 2026 works contract with a planned RTI led by Dott. Carlo Agnese at EUR 10,868,519.12 for 419 days; notice to proceed, mobilisation, installed quantities and named subcontractors remain unverified

award / Last checked
Confirmed

Granville Herel main breakwater and sill-wall repair

France / Breakwater and reinforced-concrete marine-structure rehabilitation / The owner-confirmed nine-month repair started on 25 August 2025; its planned end-May 2026 acceptance window has passed without a published completion certificate, handover or final account

construction / Last checked
Confirmed

Kustlijnzorg South Holland nourishment (31205037)

Netherlands / Beach and foreshore nourishment / Van den Herik signed the EUR 16.302 million contract on 10 March 2026; Rijkswaterstaat schedules Maasvlakte 2 nourishment for September and names Van den Herik with Van der Kamp there, while mobilisation and the parties' commercial relationship remain unverified

award / Last checked
Confirmed

Kustlijnzorg Walcheren beach nourishment (31205036)

Netherlands / Beach and foreshore nourishment / Fa. Gebr. Van der Lee signed the EUR 8.199 million contract on 31 March 2026; the contract is live through 2027, while no public evidence of physical mobilisation, vessel assignment or accepted production was identified by the 7 August 2026 review

award / Last checked
Confirmed

Kustlijnzorg North Holland and Texel nourishment (31205035)

Netherlands / Beach and foreshore nourishment / Boskalis signed the EUR 26.098 million contract on 12 May 2026; Rijkswaterstaat announced Den Helder tidal-channel nourishment from 14 July to mid-October and Julianadorp sinker-pipe removal from 20 July, while measured production and acceptance remain unpublished

construction / Last checked
Confirmed

Ras Hanzir replacement cargo facility

Malta / Cargo-port quay, land reclamation, piling and utilities / Infrastructure Malta is taking replacement works tender IMT008/2025 to 1 October 2026 after terminating predecessor contract IM027/2020; the replacement works package remains unawarded

tender / Last checked
Confirmed

Yukonhaven Jetty 4 LNG bunker-loading berth

Netherlands / LNG jetty, combi-wall, mooring structures, dredging and shore works / Gate took FID in January 2026, Port of Rotterdam signed the Hakkers Waterbouw-De Klerk combination on 6 February, and April works notices support early construction; start-up is planned around the end of 2028

construction / Last checked
Confirmed

Port Seine-Metropole Ouest phase-one river-port construction

France / Inland-port basin excavation, sheet-pile quays, pile-supported jetties and multimodal access / HAROPA PORT reports phase-one construction in execution: earthworks, a retaining wall and conveyor loading were active in summer 2026, South Quay sheet-pile installation had started, and piling for the west then east jetties was scheduled from the week of 6 July

construction / Last checked
Confirmed

Boulogne-sur-Mer-Calais maintenance dredging framework

France / Dredging / Region Hauts-de-France concluded contract 202613951 with SODRANORD on 24 February 2026 for a purchase-order maintenance dredging framework; the EUR 23 million figure is the four-year maximum ceiling, while the first call-off, 2026 quantity and mobilisation remain unconfirmed

award / Last checked
Confirmed

Santoña North Basin fishing-quay structural repair

Spain / Piled fishing-quay concrete rehabilitation and metal fender renewal / Cantabria formalized the EUR 2,486,545.15 excluding-VAT works contract with the Cuevas Gestión de Obras-COMSA UTE on 9 July 2026; the signed contract requires a viable setting-out check before the 24-month execution period starts, while the setting-out act, site mobilisation, monthly production and lower-tier appointments remain unpublished

award / Last checked
Confirmed

Ferry Terminal Turku marine and landside works

Finland / Ferry-terminal piers, passenger bridges and port-yard renewal / Pier S1 was handed over on 15 June 2026 but will not enter service until March 2027; the joint terminal, passenger bridges and 11-hectare field works remain under construction, while Quay S2 is targeted for 2028

construction / Last checked
Confirmed

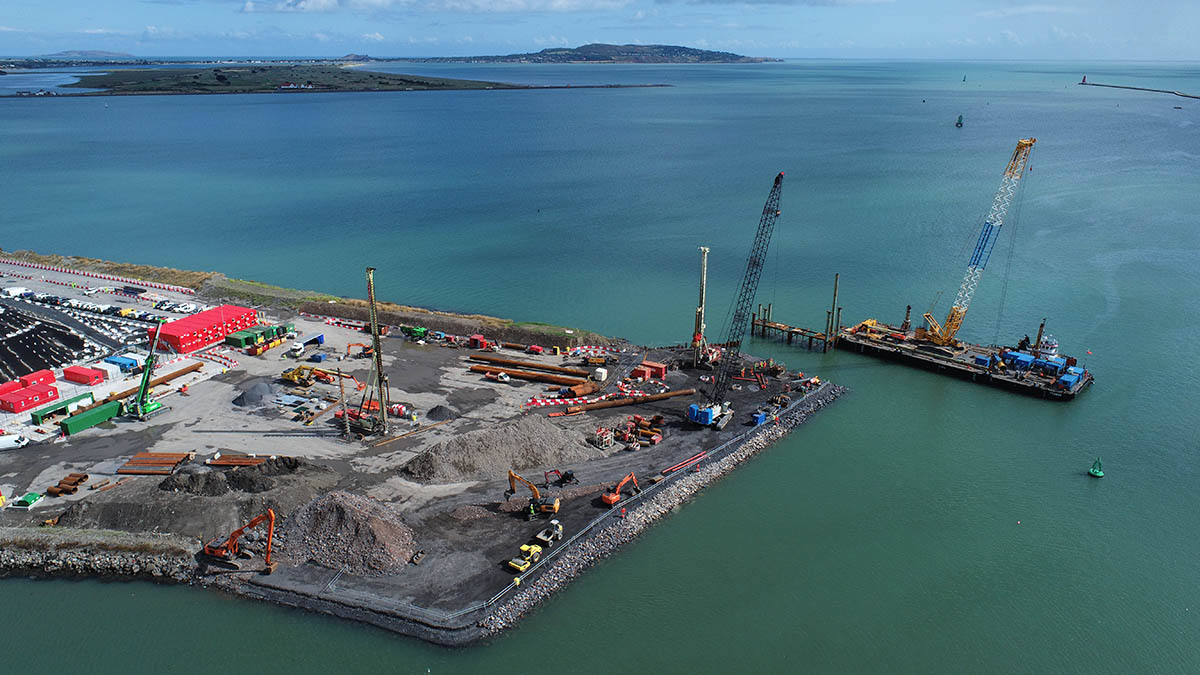

Castletownbere small craft harbour piling and utilities

Ireland / Fishery harbour piling, civil works and marine utilities / TED published the EUR 1.2498795 million Sorensen award on 5 August 2026 and records contract conclusion on 22 June; no project-specific mobilisation, commencement or subcontractor notice has been published

award / Last checked
Confirmed

Port de Plaisance du Grand Large marine works

France / Marinas, pontoons and berthing infrastructure / SPAD concluded three separate Grand Large marina works contracts on 30 June 2026 with Eiffage Travaux Maritimes et Fluviaux, Atlantic Marine and Ramery Travaux Publics; each lot carries a 24-month planned period, but no dated notice to proceed or field mobilisation has been located

award / Last checked
Confirmed

Port de l'Ayguade du Levant Ro-Ro quay

France / Ro-Ro berth and island freight access / Métropole Toulon Provence Méditerranée concluded contract 98RL25 with Océlian and TP Spada at EUR 2,104,311.99 on 20 August 2025 after an earlier procedure ended without an award; no dated mobilisation or completion record has been located

award / Last checked
Confirmed

Dunkirk Braek submerged sand-discharge pipeline replacement

France / Coastal protection and dredged-sand reuse / Baggerbedrijf de Boer holds the EUR 1.720365 million replacement contract concluded on 13 January 2025; the planned 31 May 2025 in-service deadline has passed, while physical completion, acceptance and downstream packages remain unverified

award / Last checked
Confirmed

Elizabeth Harbour marine redevelopment

Jersey / Ferry-terminal marine works, dredging and demolition / Final design and planning-condition discharge are evidenced; construction was scheduled for autumn 2026, while Stage Two authorization, dredger or piling mobilisation and physical works start remain unpublished

design / Last checked
Confirmed

Port of Workington maintenance dredging framework 2026-2030

United Kingdom / Maintenance dredging and operating-port access / Four-year framework awarded to Boskalis Westminster, Dutch Dredging and Van den Herik; the first mini-competition, call-off, assigned vessel, dredged quantity and acceptance remain unconfirmed

award / Last checked
Confirmed

Albert Pier and St Helier Marina berthing upgrades

Jersey / Marinas, pontoons and berthing infrastructure / Albert Pier's final berthing stage was complete by 6 April 2022 and St Helier Marina's refurbishment by May 2022; Ports of Jersey subsequently confirmed the marina works were on schedule and the combined capacity benefits were in use

completed / Last checked
Confirmed

Frioul East breakwater rehabilitation and rock spur

France / Historic rubble-mound breakwater rehabilitation and island-port protection / Contract Z250608F00 was concluded on 2 February 2026 with an Océlian-led five-company group for EUR 19.589919 million; the owner reports that the overall rehabilitation programme continues in 2026, while main-contract mobilisation, placed rock, accepted sections and downstream subcontract awards remain unpublished

award / Last checked
Confirmed

Normandy ports maintenance dredging framework 2026-2029

France / Maintenance dredging and operating-port access / Eight call-off lots were concluded on 12 November 2025 for a four-year maximum framework beginning in 2026; the award chain is confirmed, while the first 2026 call-off, vessel mobilisation, measured quantity and port acceptance remain unpublished

award / Last checked
Confirmed

Ploce New Bulk Cargo Terminal

Croatia / Deep-draft dry-bulk terminal, open piled quay, ground improvement, conveyors and rail-loading systems / Civil infrastructure was completed in June 2016, CNBM equipment arrived in October 2017, trial operation began in March 2019 and regular vessel service began in February 2021. The operator's current port card lists a 2,000 t/h grab ship unloader and 4.6 Mt/y design capacity

completed / Last checked
Confirmed

Gdynia Outer Port protective breakwaters

Poland / Caisson breakwaters and port access infrastructure / The May 2026 building permit has moved the design-build contract into principal in-water works; the first reinforced-concrete caisson was launched and towed toward its placement position in July 2026, with the remaining 48 caissons and breakwater systems still to be delivered

construction / Last checked
Confirmed

Poti Sea Port Berth 14 Rehabilitation

Georgia / Container berth rehabilitation, dredging, quay-top renewal and terminal equipment / EBRD lists Phase 1 as Completed, and a TRACECA technical record says Berth 14 was rehabilitated in 2009 for 1,000-TEU feeder vessels; the exact acceptance date, as-built dredging quantity and depth, delivery contractor and final account remain publicly unresolved

completed / Last checked
Confirmed

Mo i Rana entrance and Langneset deep-water quay

Norway / Deep-water quay, fairway dredging, contaminated-sediment containment and navigation works / Kystverket reported the Langneset quay in its finishing phase on 29 June 2026, with concrete works nearing completion and technical installations scheduled through summer and autumn; completion and an official opening are planned for autumn 2026, but handover, acceptance and operation remain unconfirmed

construction / Last checked
Confirmed

Galati Multimodal Platform Stage I quay works

Romania / Inland-port quay, dredging, basin infill and intermodal berth works / TED published a further contract modification on 27 May 2026, extending the recorded execution duration by 4 months and 23 days and reducing the stated contract value by RON 1,270.26; the latest owner progress figure located is 62.04% at 30 June 2025, and no completion or acceptance record has been published

construction / Last checked
Confirmed

Marsaxlokk fishing-port fairway dredging

Malta / Fishing-port fairway dredging and beneficial reuse / Transport Malta described the Marsaxlokk works as ongoing on 26 June 2026; the original navigation notice ran to 31 July, but no public final hydrographic survey, accepted quantity, completion certificate or final account was located by 2 August

construction / Last checked
Confirmed

Saint-Malo Terminal du Naye Lot 2 marine works

France / Ferry-terminal marine works, dredging and demolition / Région Bretagne reported one of the two old lock-guide structures under demolition on 1 April 2026 after the 270-tonne Ro-Ro ramp was removed in December 2025; the new reinforced-concrete guide caissons and maintenance dredging remain inside the two-year Lot 2 mission, with no owner acceptance published

construction / Last checked
Confirmed

Höfn Grynnslin 2025 maintenance dredging

Iceland / Maintenance dredging and operating-port access / Jan De Nul confirms that trailing suction hopper dredger Tristão da Cunha deepened the Höfn access channel between January and February 2025; the measured quantity and post-dredge acceptance remain unpublished, and a separate Boskalis contract now covers 2026-2028

completed / Last checked
Confirmed

Killybegs Smooth Point breasting dolphins and shore power

Ireland / Fishery harbour berthing, marine piling and shore power / Sorensen reported all 24 dolphin piles installed in August 2025; the government project page published the following month still described the works as ongoing with substantial completion due in Q3 2025, and DAFM has not published a later handover record

construction / Last checked
Confirmed

Dublin Port Marine Works Framework and Berth 29

Ireland / Port infrastructure / Single-party framework active with Murphy International; Berth 29 was handed over in 2024, Murphy reports 21 call-offs delivered during 2025, and owner confirmation of the contractor-stated July 2026 completion target for Berths 30/31 and McCairns Yard has not been identified

construction / Last checked
Confirmed

Husøy Fishing Port Deepening

Norway / Dredging / Kystverket's latest dated update records blasting complete and about 26,000 solid cubic metres of clean material dredged by 21 April 2026; the owner page says work remains in progress toward December 2026 completion

construction / Last checked
Confirmed

Inis Oírr Pier Improvement Project

Ireland / Port infrastructure / The construction contract started on 24 September 2025 and Marine Notice 23/2026 records Ward & Burke commencing the two-year marine works; no later completed work package has been published

construction / Last checked
Confirmed

Port Atlantique La Rochelle Chef de Baie 4 terminal

France / Port infrastructure / Quay construction and the four-hectare yard remain the latest official delivery state; handover to operator AMLP was targeted for the second half of 2026 but has not been published

construction / Last checked
Confirmed

Fehmarnbelt Fixed Link Immersed Tunnel

Denmark / Germany / Immersed tunnels and marine crossings / Third tunnel element immersed and connected on 1 August 2026; protection, serial immersion, systems integration, and a two-stage road-then-rail opening remain active

construction / Last checked
Confirmed

Thessaloniki Port Pier 6 expansion

Greece / Container terminal expansion, quay construction and dredging / ThPA signed the EUR 195.6 million METKA-TEKAL construction contract in November 2025 and installed the first of 21 quay caissons in July 2026; the second caisson was under construction at publication

construction / Last checked
Confirmed

Oslo Kneppeskjaer East quay replacement and expansion

Norway / Multipurpose quays, dredging and carbon-logistics infrastructure / Repstad Anlegg began works in August 2025; demolition, dredging and subsea blasting preceded a 99-pile quay-foundation programme scheduled from March to July 2026

construction / Last checked
Confirmed

London Gateway Berth 5 quay and automated yard

United Kingdom / Deep-water ports and automated container terminals / Port of London Authority reported the 430-metre Berth 5 quay extension complete by 1 August 2026 while further retaining-wall piling continued toward the Berth 6 interface; the separately contracted ten-module automated yard remains on a contractor-reported programme to March 2027

construction / Last checked
Confirmed

Baltic Hub T3 deep-water container terminal

Poland / Deep-water ports and container terminals / Marine construction was completed in 2025 and T3 entered full operation in October 2025; 2026 aRMG relocation and yard-line commissioning continue as operational optimisation

completed / Last checked
Confirmed

Zeevonk phase 1 foundation installation

Netherlands / Offshore wind foundations / DEME holds the transport and installation contract for 69 monopile foundations; offshore mobilisation has not been announced

award / Last checked
Confirmed

Dublin Port MP2 Berths 52 and 53 marine construction

Ireland / Port infrastructure / Marine construction is active; the 2026 harbour notice keeps the buoyed work zone in place through January 2027, while berth acceptance and service release remain open

construction / Last checked
Confirmed

Algarve seawater desalination intake and outfall system

Portugal / Marine utilities / Construction was released on 22 April 2026 and the site milestone was held on 8 July; offshore intake and outfall execution remains unverified

construction / Last checked
Confirmed

DEME next-generation 22,000 m³ TSHD

Belgium / Dredging / 22,000 m³ TSHD ordered; China hull build, Singapore completion, trials, and 2029 delivery remain pending

delivery / Last checked
Confirmed

Genoa New Breakwater

Italy / Ports and coastal protection / 24 caissons installed and the first kilometre passed; seabed foundation, superstructure, dredging, and navigation-opening gates remain active

construction / Last checked
Confirmed

Skandia Gateway fairway and quay deepening

Sweden / Port infrastructure / Quay construction active; port-side dredging awarded; optimized national fairway package in procurement for 2027-2028 delivery

construction / Last checked

Current research

Latest region-coded publications

6 shown / 135 current
IVY 1 and IVY 2 supporting a standard Fehmarnbelt tunnel element during mooring trials at Rødbyhavn, in the owner's 2026 image-library record
Brief / Confirmed

Fehmarnbelt: IVY's 1,600-Tonne Load Test

Fehmarnbelt's September load test addressed a change in transport geometry. The first special tunnel element has a basement and must travel higher in the water than a standard element. Raising it reduces buoyancy and transfers more load to the immersion vessel IVY. Sund & Bælt reported on 11 September 2026 that the fourth standard element had been loaded with an additional 1,600 tonnes, distributed between water bags on its roof and tanks inside it, and lifted to the height required for transporting the special element. [1]

Updated
Jack-up barge and cranes beside sheet-piled works at Bridgwater Tidal Barrier, with the River Parrett bypass channel behind
Brief / Confirmed

Bridgwater's Gate Redesign Meets the Concrete Programme

Bridgwater's revised tidal-barrier design puts the gate-drive equipment at the base of three towers while work advances on the permanent foundations. The Environment Agency announced the changes on 15 January 2026: towers approximately 15 m high, a 10 m reduction, with simpler shapes and lighter operational walkways. Somerset Council's October construction account reports reinforcement beneath the central pier and permanent concrete taking shape. The next interface is between the revised machinery arrangement and the concrete being cast. [1][2]

Updated
A crane suspends a gate-and-frame assembly above the waterside walkway at Avon Water outfall, Keyhaven
Brief / Confirmed

Keyhaven: Inspecting a Submerged Tidal Outfall

The Environment Agency reported completion of the Avon Water tidal-outfall replacement at Keyhaven Harbour on 13 October 2026. Significant corrosion had prompted renewal of a structure serving a flood-defence system that protects around 40 properties. Much of the structure is submerged for long periods: specialist divers carried out detailed inspections, and the tides governed the work [1].

Updated
Sizewell bulk-import diagram connects the planned Wind jetty-head work and Canti-travel trestle to the berth, conveyor and shore receiving route
Brief / Confirmed

Sizewell targets Q2 2027 bulk imports as jetty works advance offshore

Sizewell C expects its Marine Bulk Import Facility to become operational in the second quarter of 2027. The owner's works tracker reports that construction has advanced from the beach into the sea, with platform works continuing through the end of 2026. The facility will transfer bulk materials from vessels to the main construction site. April's site forum recorded Canti-travel piling in progress; the harbour's subsequent phase-two plan paired offshore jetty-head construction with an approach trestle advancing seaward from the mainland. [1][2][4]

Updated
Northern coastal defences and foreshore at Fort George on 28 June 2016, shown as historical context for the North Glacis package
Brief / Confirmed

Fort George underpinning: recorded tender deadline passed

Historic Environment Scotland's 8 October notice covered concrete underpinning at Fort George North Glacis, near Ardersier: temporary propping, beach-side excavation, secured formwork, mass-concrete fill and beach reinstatement. The recorded PCS Postbox submission deadline of 17:00 GMT on 4 November 2026 has passed; the advertised duration is 28 working days.

Updated

Delivery network

Organizations active in this collection

6 shown / 75 profiled
Harwich Haven waters and Port of Felixstowe cranes in the operating context of HHA's Tiamat launch
UK dredging joint-venture LLP

Suffolk Dredging LLP

Maintenance-dredging contract supplier / Tiamat licensee / Harwich dredging joint venture

Last checked
IMWO illustrated guide to Boskalis' Dredging and Inland Infra, Offshore Energy, and Towage and Salvage businesses, separating corporate capabilities from individual project assignments
Dredging, marine infrastructure and offshore-energy contractor

Boskalis

Capital and maintenance dredging contractor / Port, waterway and reclamation contractor / Coastal defence, riverbank and hydraulic-infrastructure contractor

Corporate facts reviewed Procurement checked
Royal IHC-built cutter suction dredger Hussein Tantawy in Rotterdam before delivery to the Suez Canal Authority
Marine equipment provider

Royal IHC

Dredging vessel designer / Marine equipment manufacturer / Shipbuilder

Last checked
Official execution drawing comparing Tarifa fishing wharf's existing 20 kV route with the proposed 20 kV route to the new transformation centre
Spanish state-port authority and marine-infrastructure owner

Algeciras Bay Port Authority (APBA)

State-port authority / Port infrastructure owner and landlord / Marine and utility works client

Last checked
Aerial view across Igoumenitsa Bay showing ferry berths, Ro-Pax vessels, terminal aprons, breakwaters and the city waterfront
Greek concession port operator and marine-infrastructure owner

Igoumenitsa Port Authority S.A. (IPA S.A.)

Port concession operator / Passenger, vehicle and cargo handler / Vessel-berthing service provider

Last checked

Continue the regional evidence review

Search the complete public index for this geography, compare the tracker records, and use IMWO confidence labels before treating a signal as a tender, award, mobilisation, acceptance, or operating outcome.

Search Europe Open project tracker Review methodology
